Are we there yet? Countless travelers and business people ask that as work progresses on the $341 million widening of Interstate 35 through Waco.
Time is money, and from that perspective, the project is running well ahead of schedule. Specifically, 72% of contract dollars have been spent in 52% of the allotted time. Houston-based Webber LLC is burning through that $341 million, but in a good way. Sources say give the company another 18 months, and a ribbon could be tied around the widening, which started in April 2019.
“The project is progressing quickly and is on track to be complete in 2023,” Webber spokesperson Mari Pillar said in an email response to questions.
Pillar said Webber and its subcontractors have thrown considerable manpower at the job, averaging 150 employees on-site at any given time, with peaks of 230 employees. Subcontractors have peaked at about 150 employees, she said.
People are also reading…

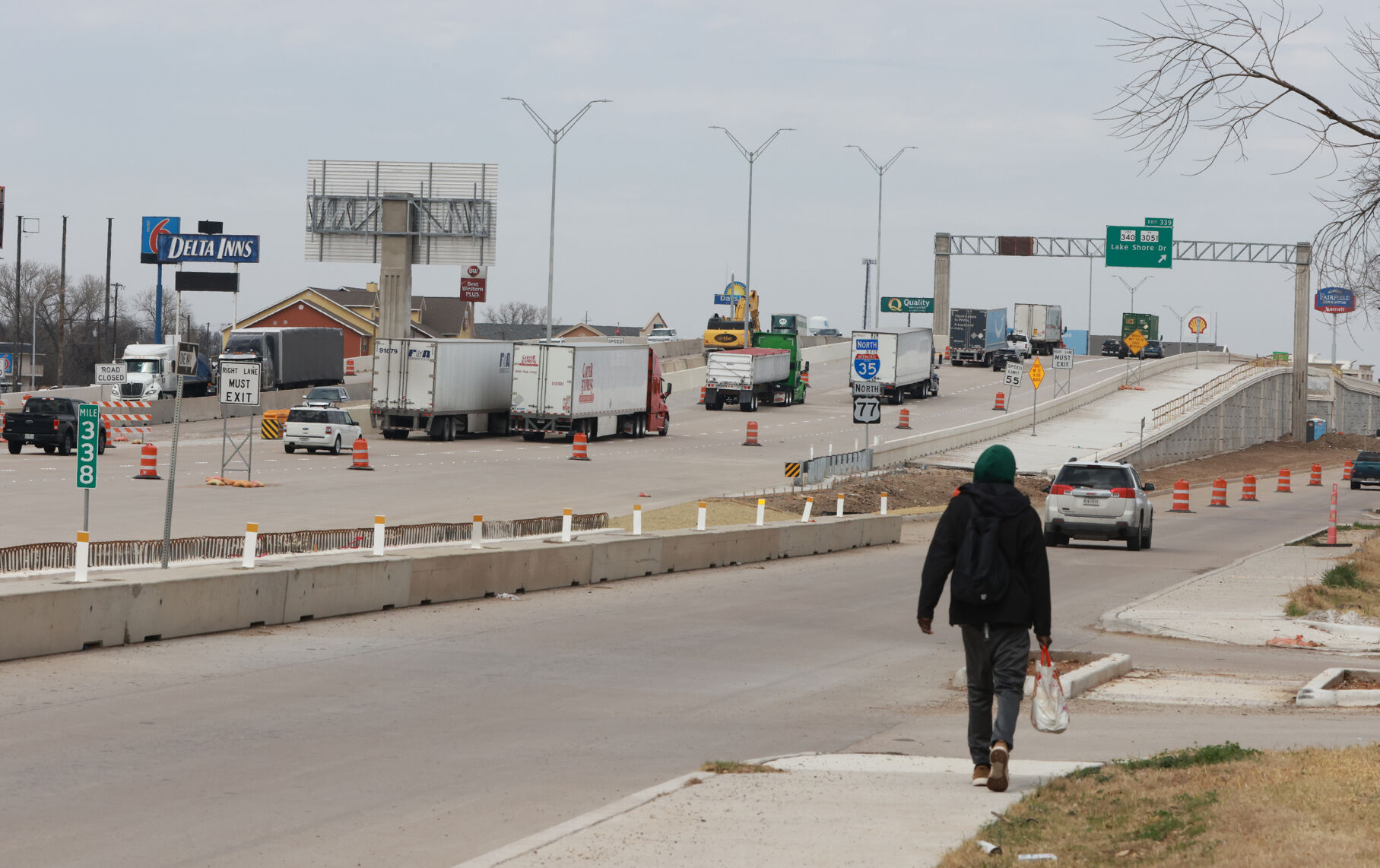

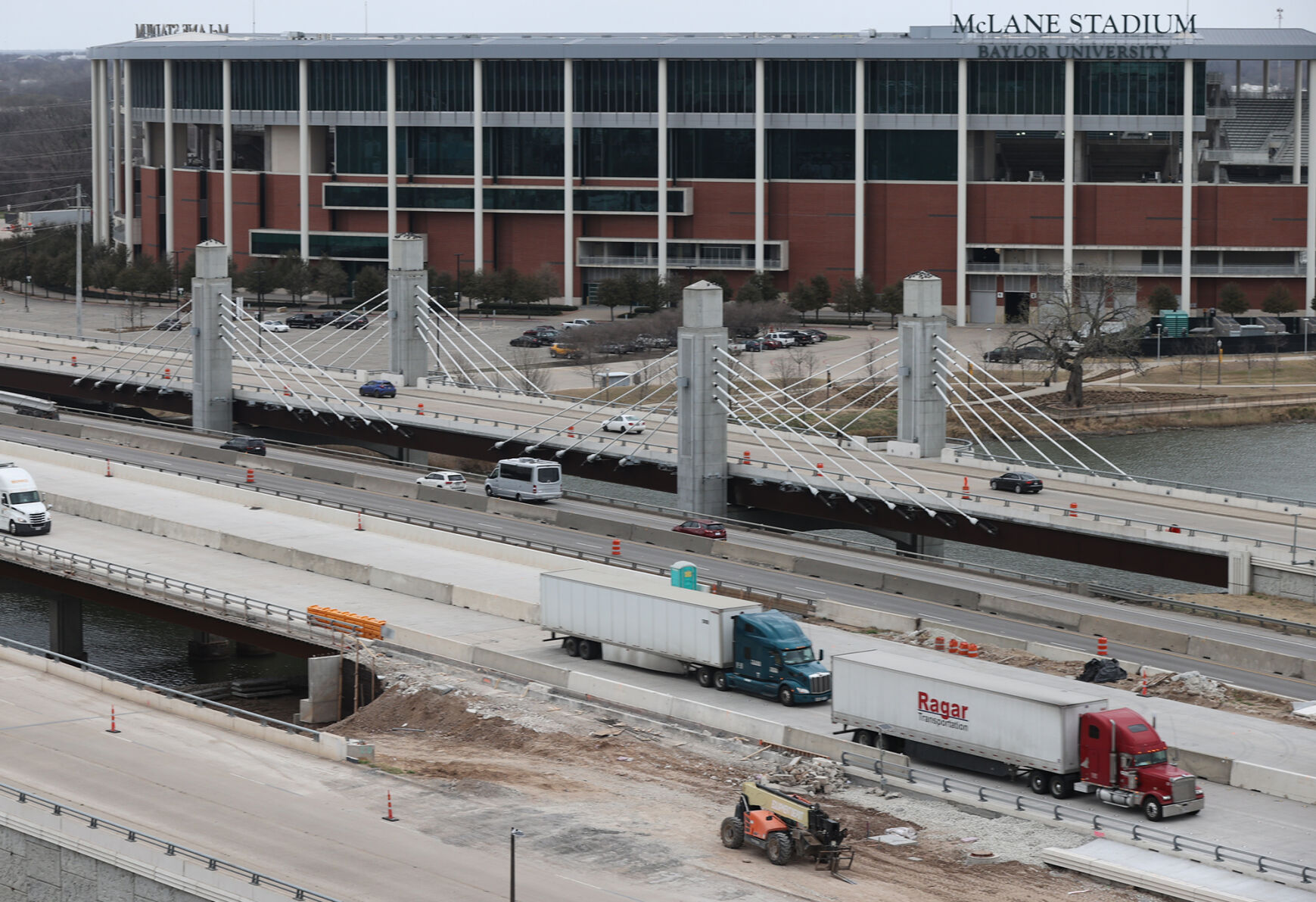

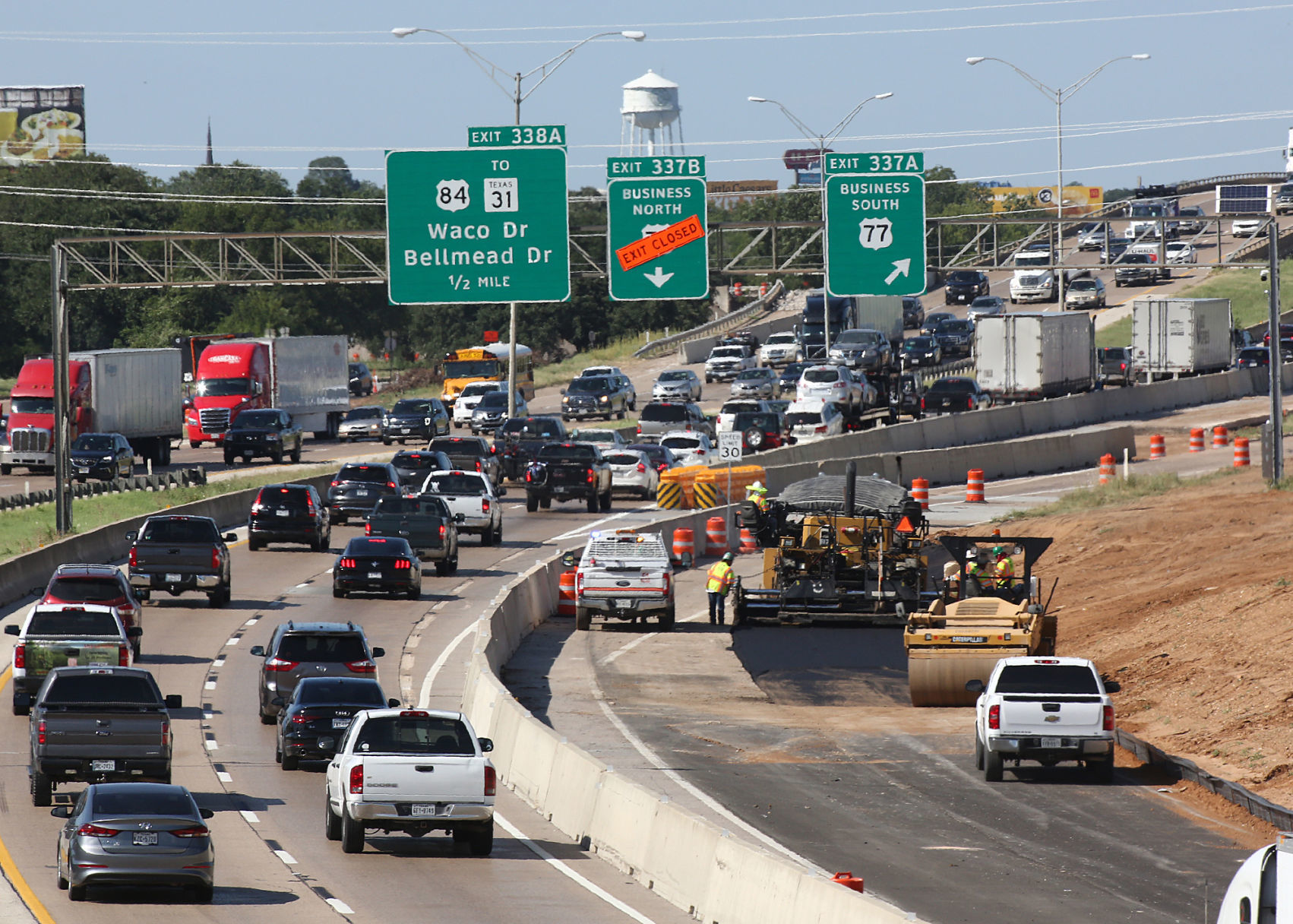

Crews were out in force on Saturday, concentrated near Bellmead.

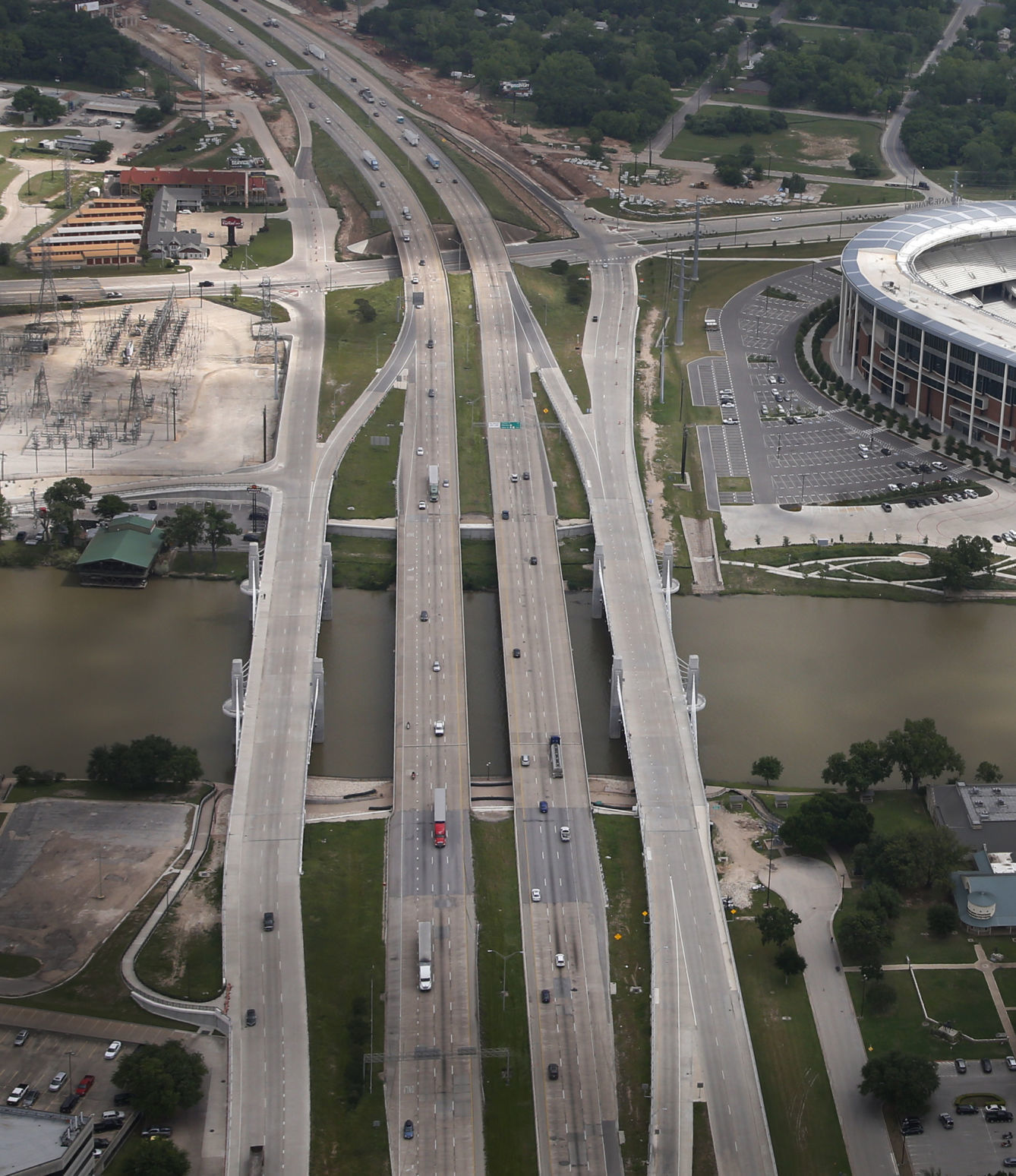

The full complement of southbound main lanes crossing nine new bridges, including one over the Brazos River, are complete, Pillar said. They are carrying traffic in both directions while work on the northbound side carries on.

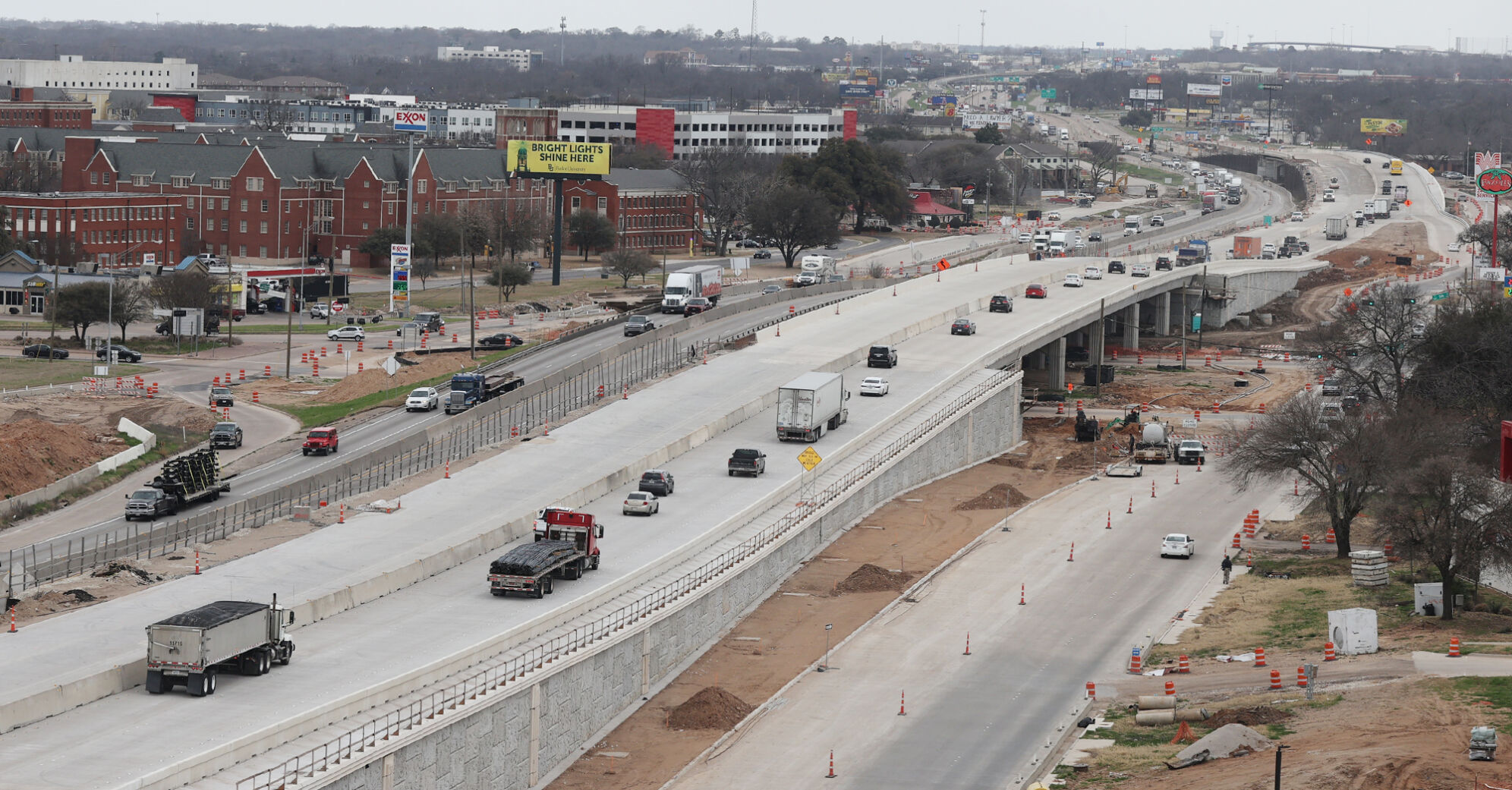

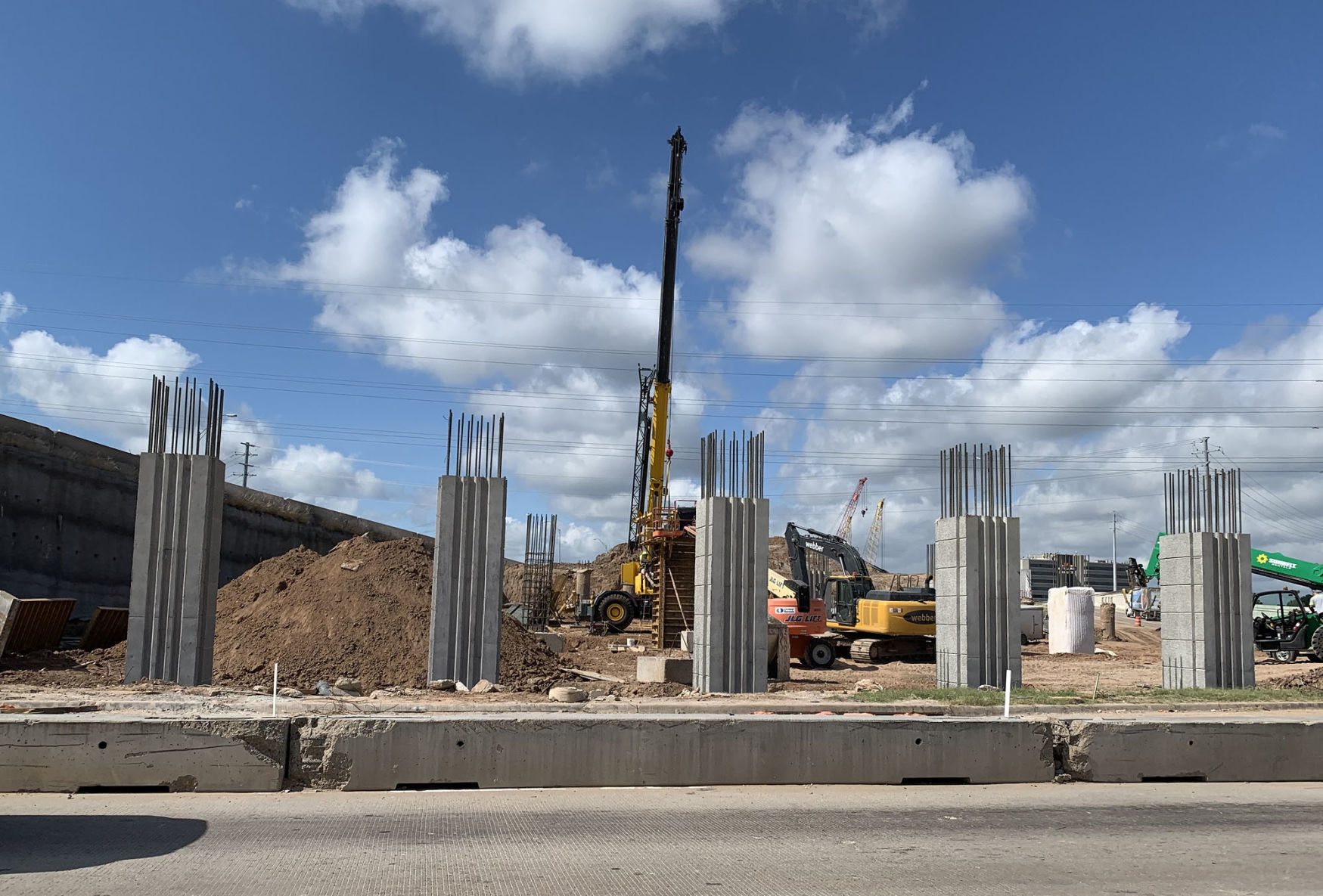

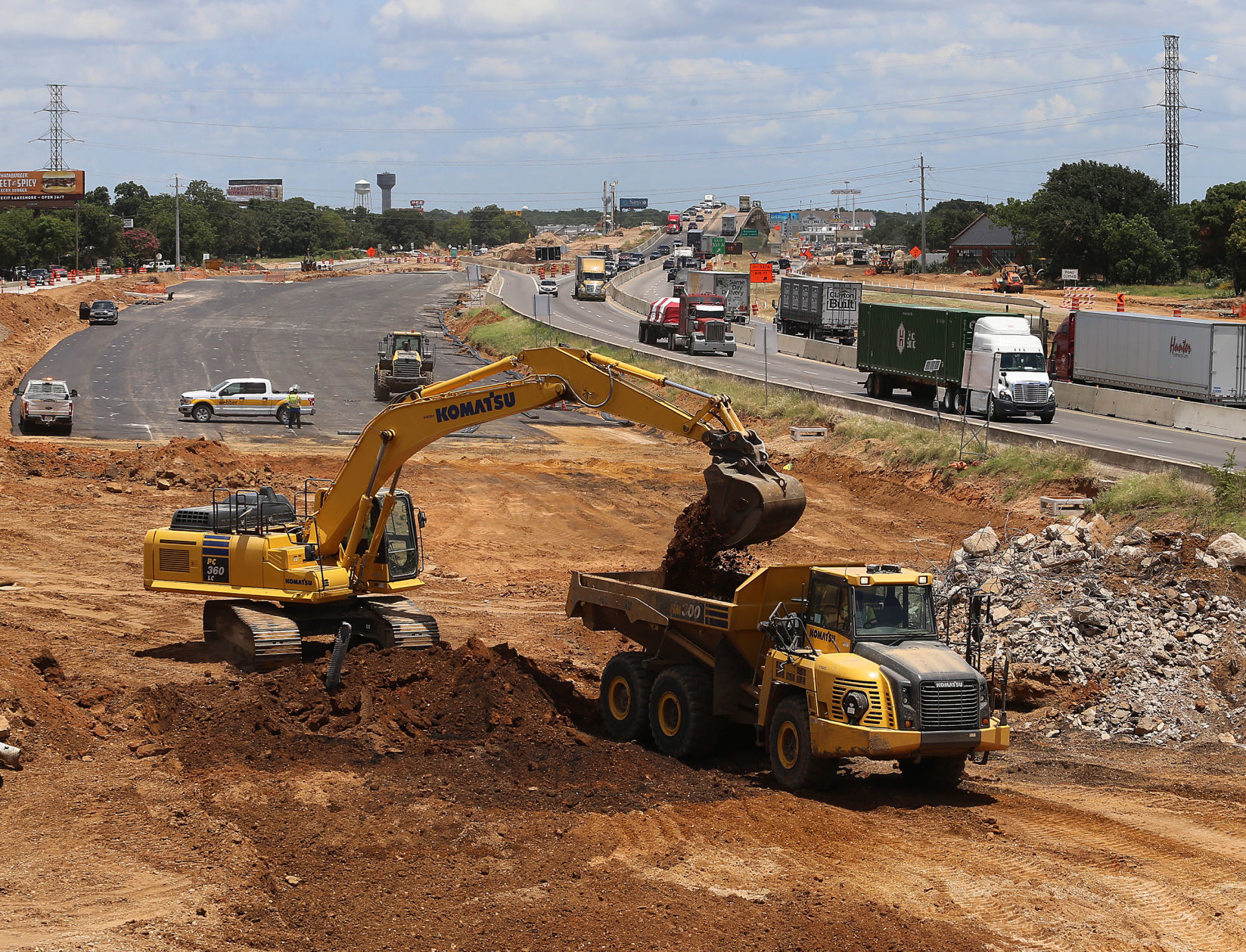

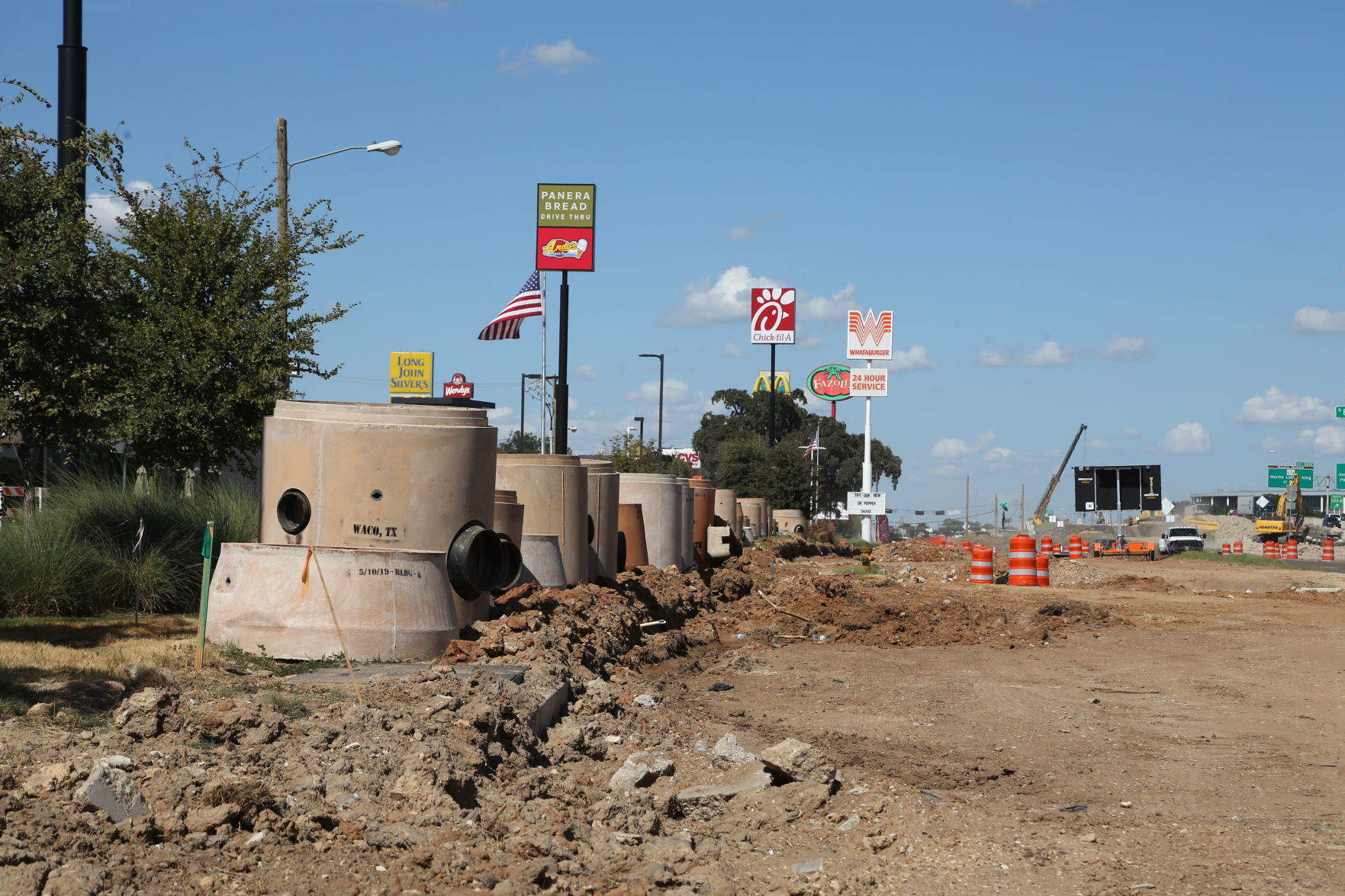

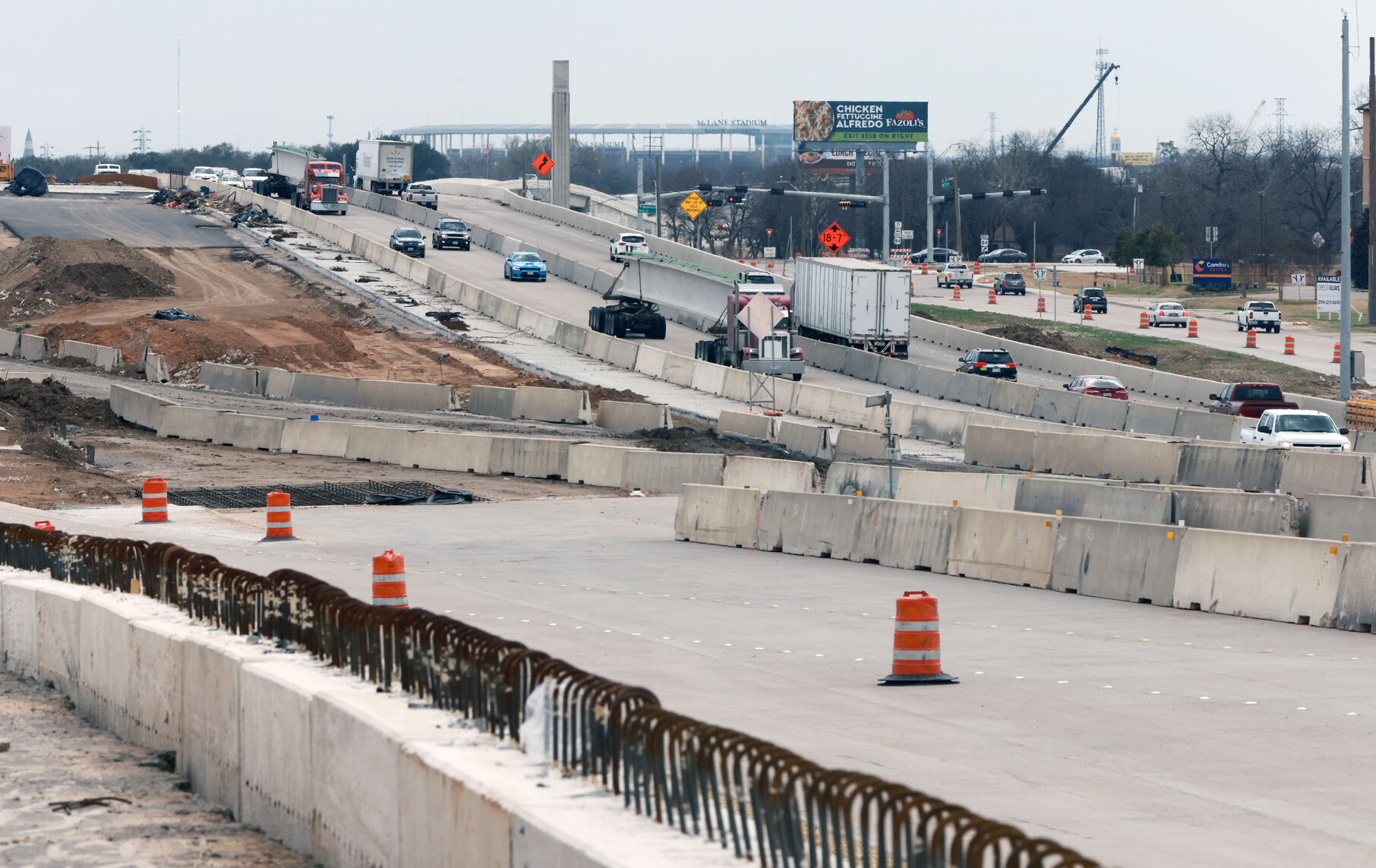

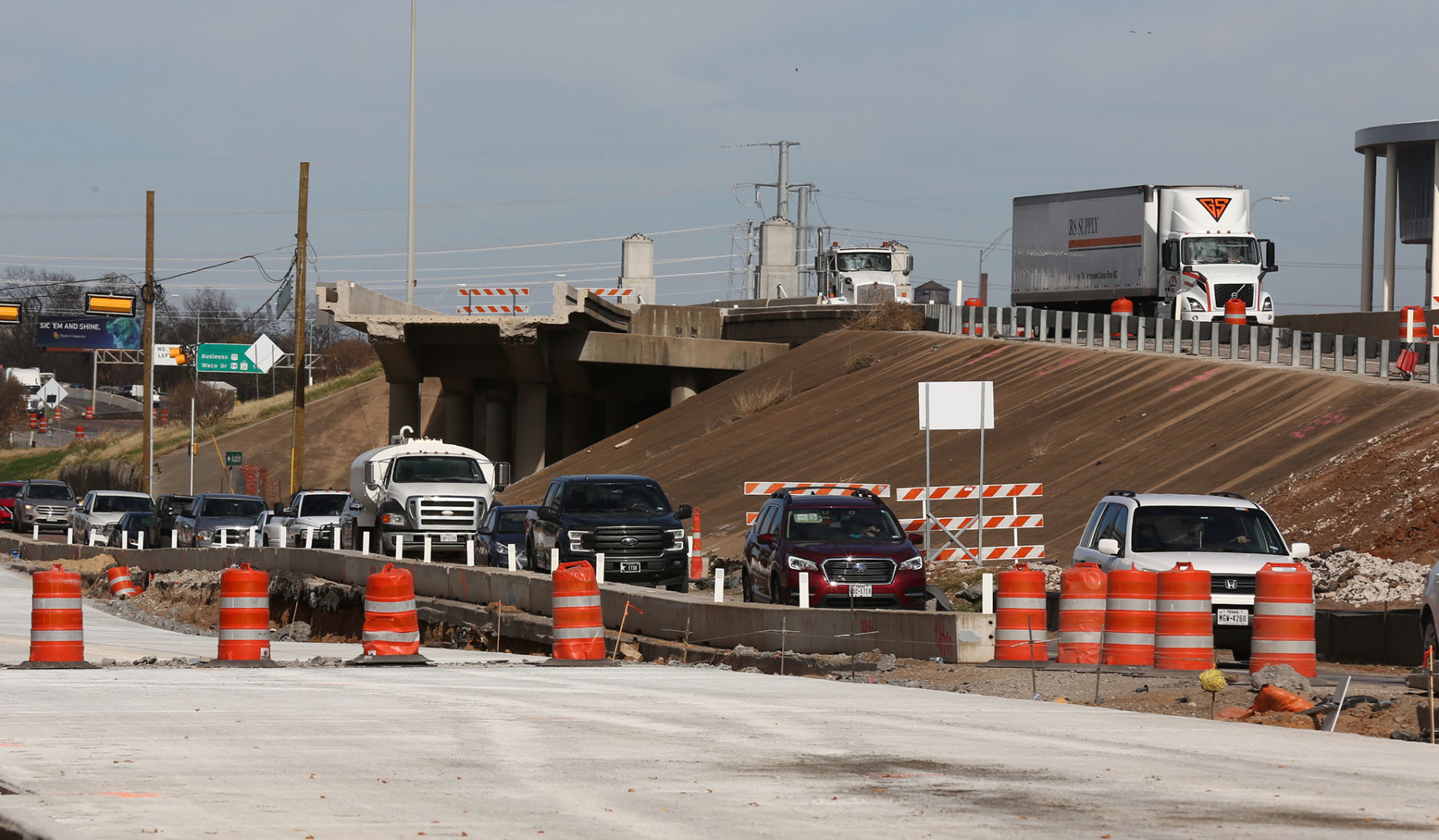

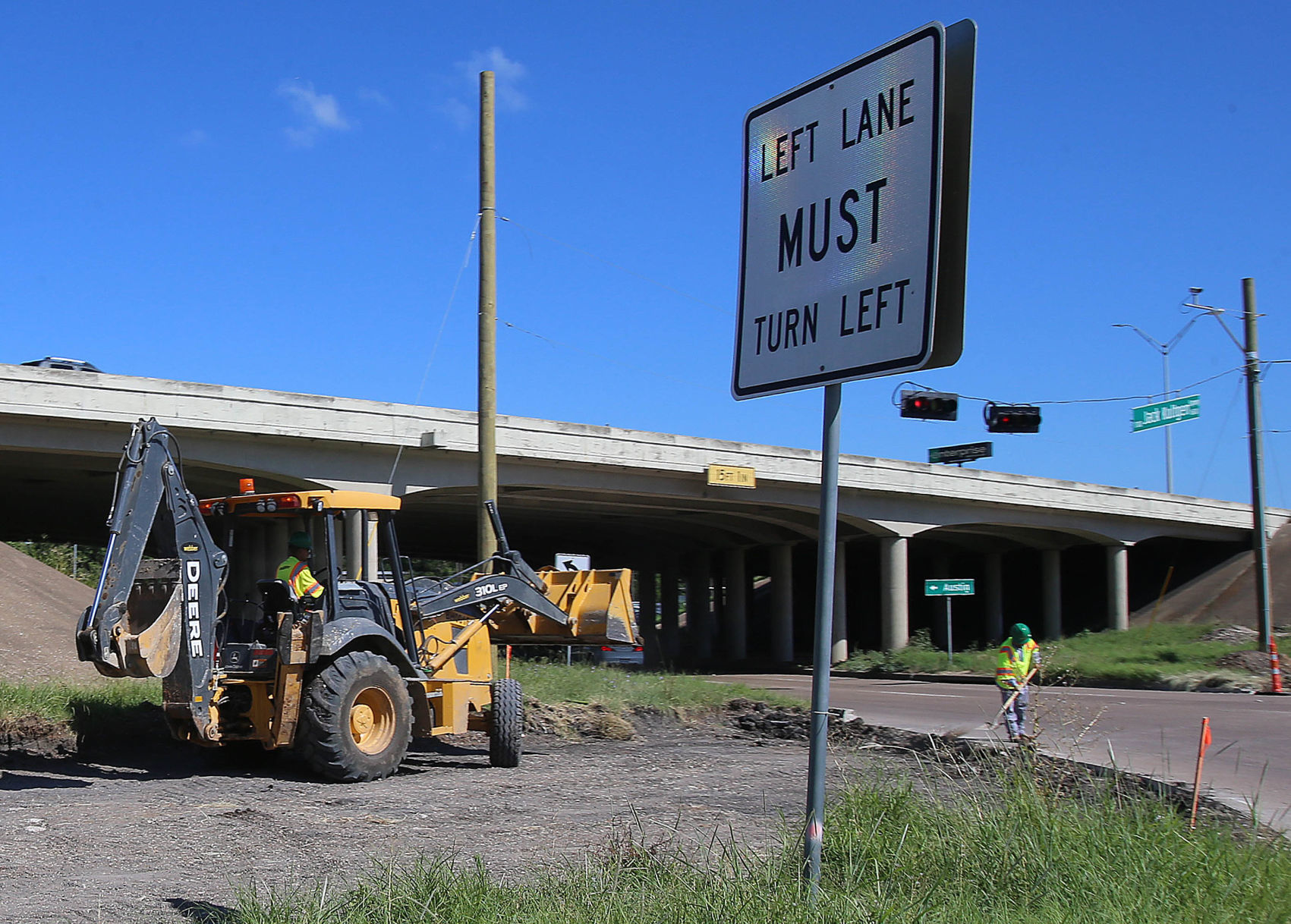

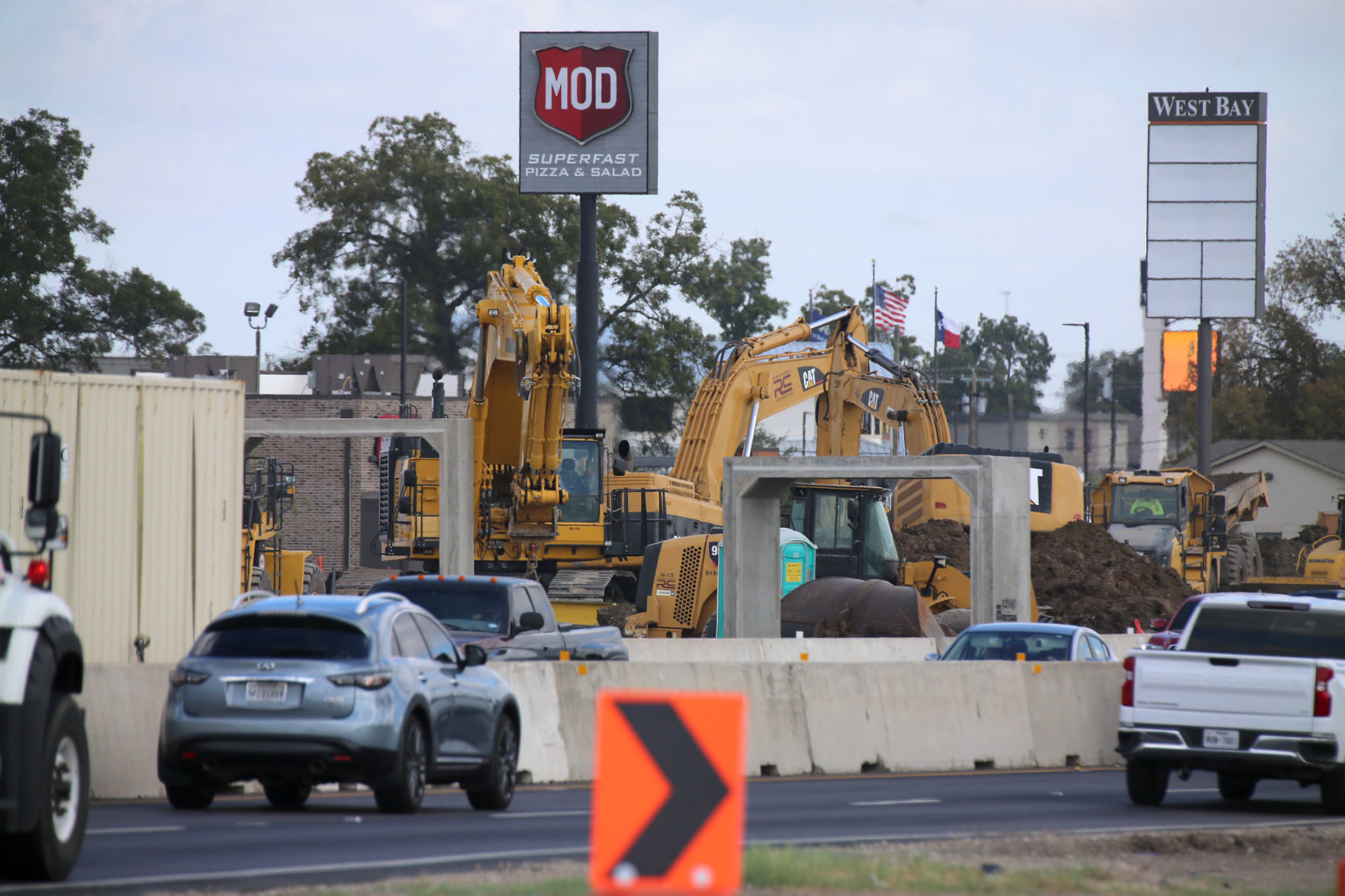

Frontage road intersections are a current focus of the I-35 expansion project through Waco.
Southbound frontage roads, likewise, are substantially complete, with the exception of some sidewalks and turn lanes. The northbound frontage road is 75% complete, “and we are now focusing heavily on the intersection work,” Pillar said.
She said an immediate goal going forward is “is finishing all the intersections on the frontage roads,” which should improve driving conditions around McLane Stadium, and those at University Parks Drive and Interstate 35.
The full project commissioned by the Texas Department of Transportation includes widening the main lanes to four lanes in each direction and improving frontage roads and interchanges from 12th Street to Loop 340. The widening is meant to improve safety and mobility, add capacity, incorporate technology, enhance aesthetics, add U-turns and improve bicycle and pedestrian access, according to a TxDOT fact sheet.
TxDOT included monetary incentives in its contract to encourage on-time completion and to reward Webber should it finish earlier than projected.
Community and business leaders early on expressed hope the project would not derail downtown’s momentum, blocking or hindering access to tourist attractions such as Magnolia Market at the Silos, the Dr Pepper Museum, Baylor University and shops along Austin Avenue.

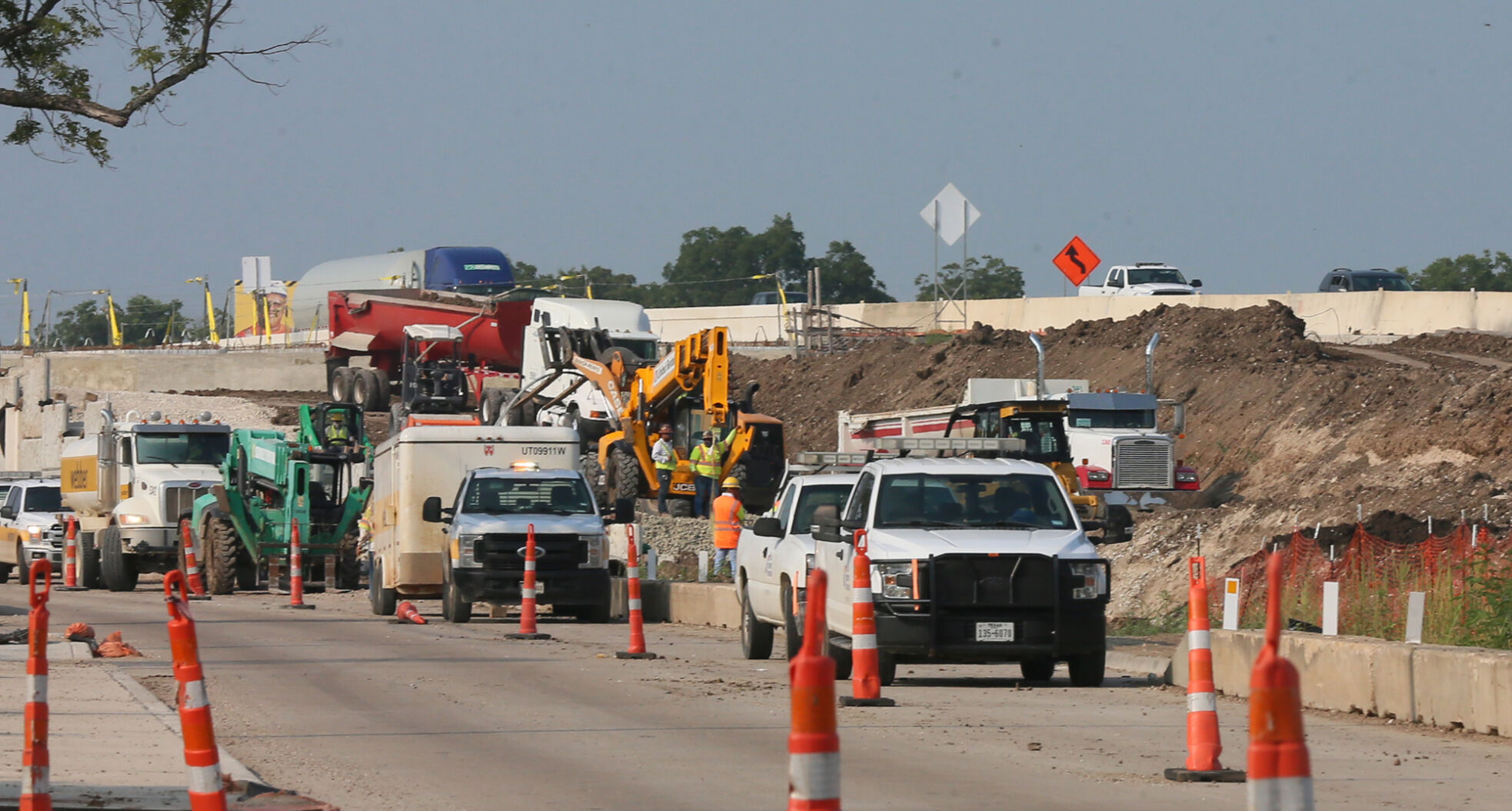

Webber LLC has an average of 150 people at a time working on the I-35 expansion through Waco, with peaks of 230, plus subcontractors.
Kris Collins, senior vice president for economic development at the Greater Waco Chamber of Commerce, said Webber has performed admirably in keeping the public, local governments and city planners informed of pending moves that could necessitate closing streets or rerouting traffic.
“I believe TxDOT learned a lot from construction in other places, and created partners locally to minimize the impact while moving forward,” Collins said. “I understand there are fewer than 18 months left on the project.”
Work along I-35 has been joined by pockets of work elsewhere downtown, as visitors no doubt have noticed. Detours, street closings and city crews abound near the First Baptist Church of Waco, Magnolia Market, River Square Center, Balcones Distilling and the McLennan County Courthouse.
Public ventures include a $2.2 million project on Webster Avenue that includes landscaping, upgrading sidewalks, improving drainage and adding an overlay to a street running through the thick of downtown tourist spots. The epicenter is near Balcones Distilling and a 54,000-square-foot building, recognizable by its block-long mural, being marketed by a local real estate company.
A city-posted sign suggests completion in the fall.

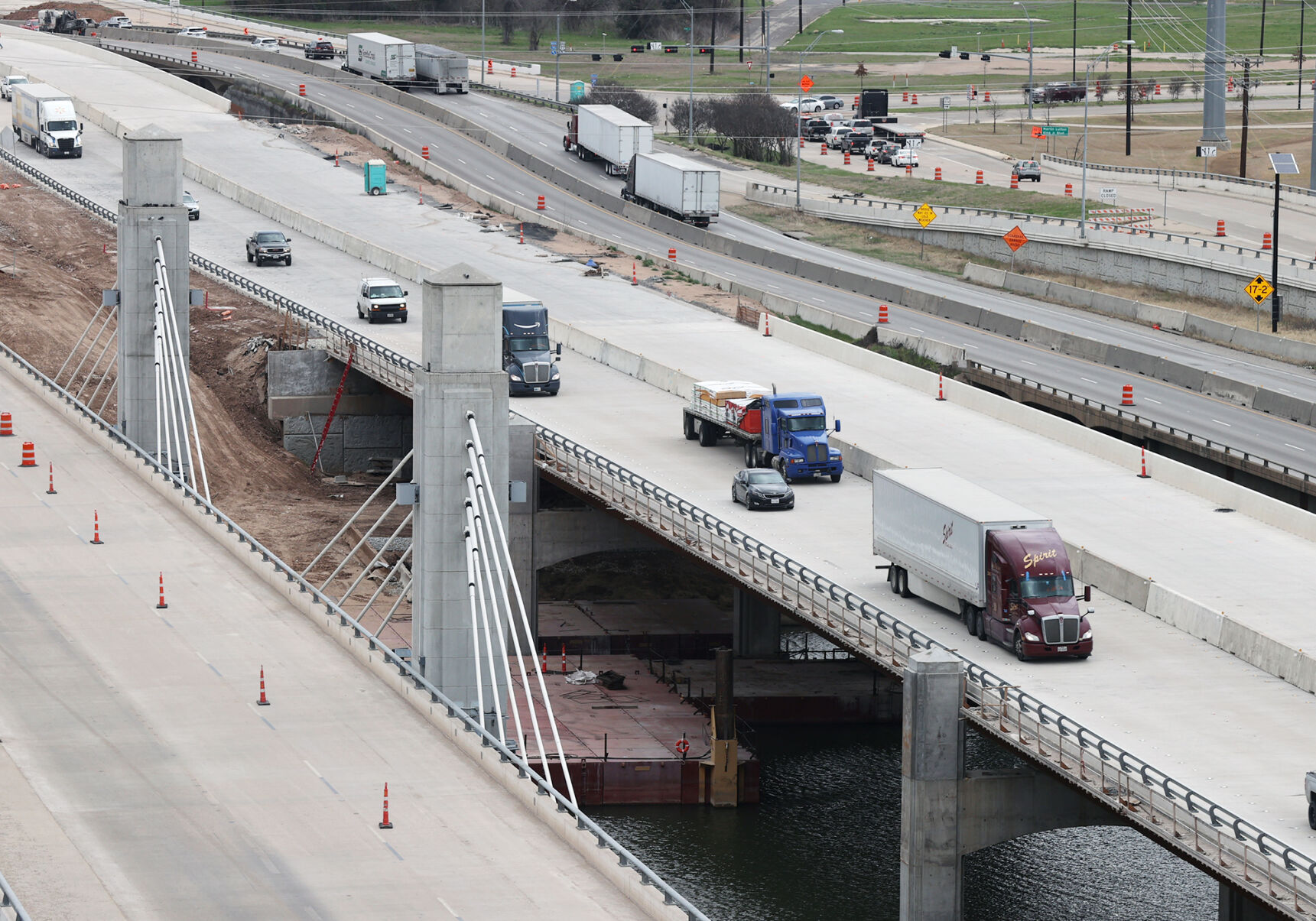

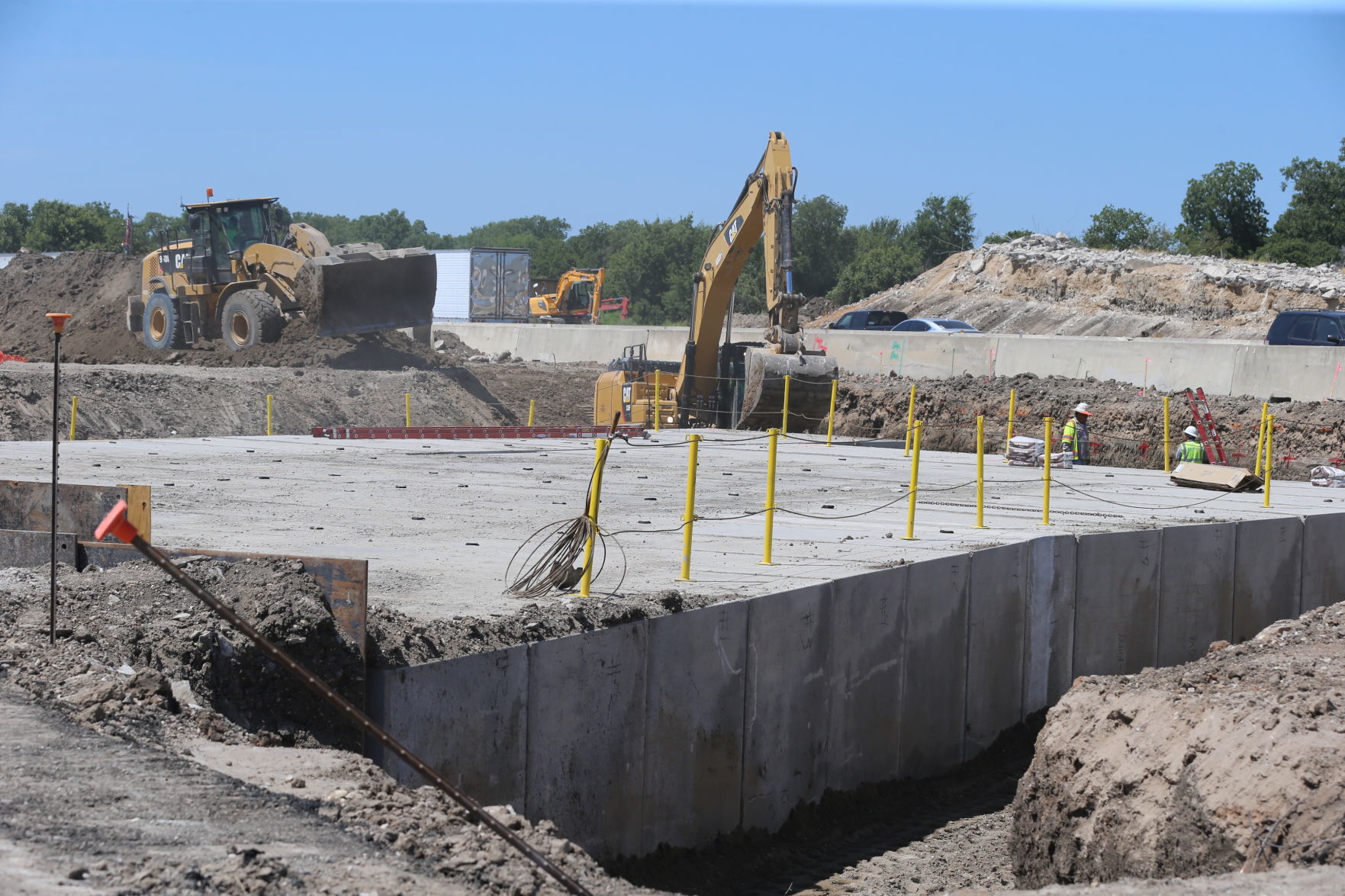

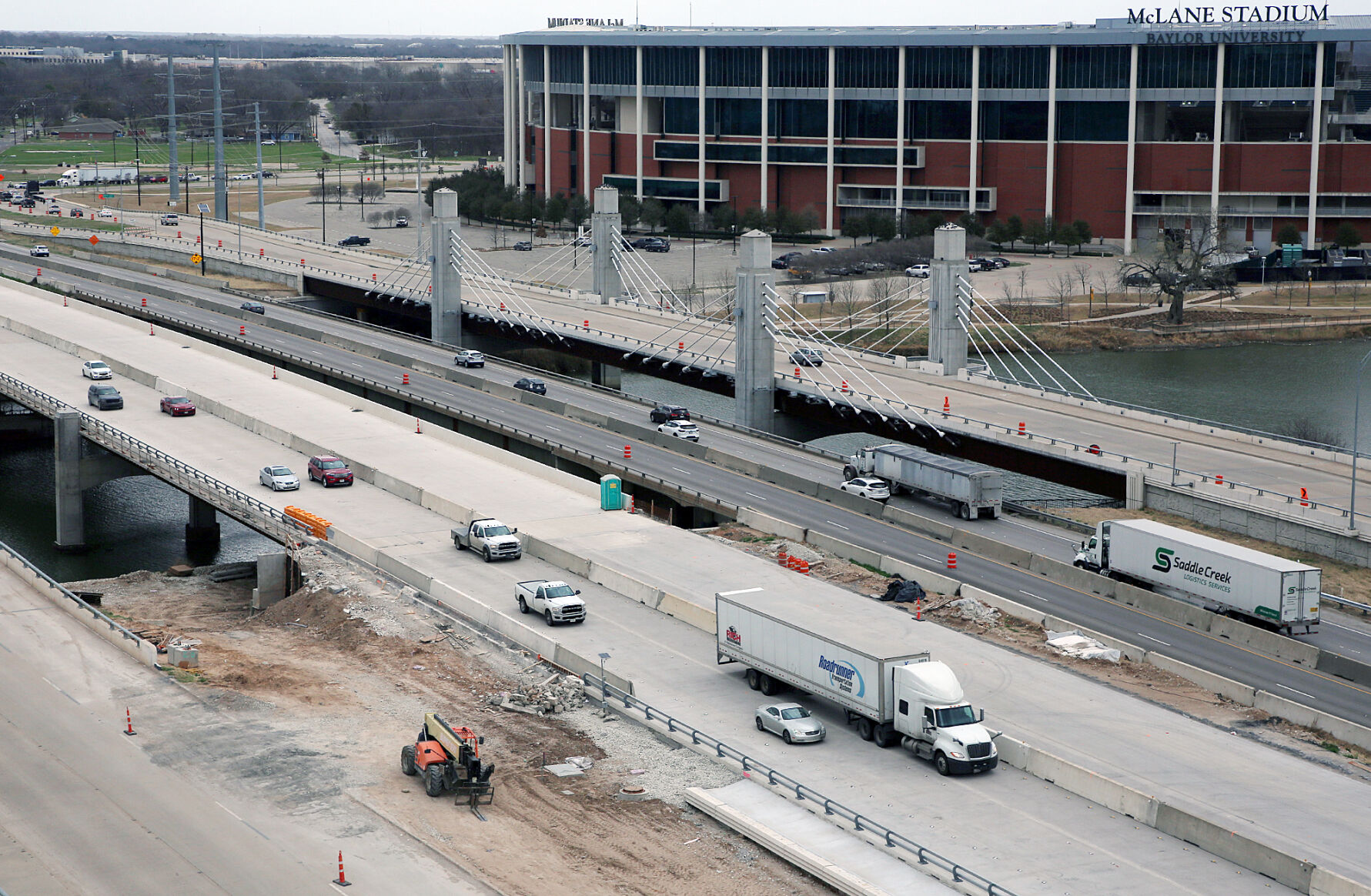

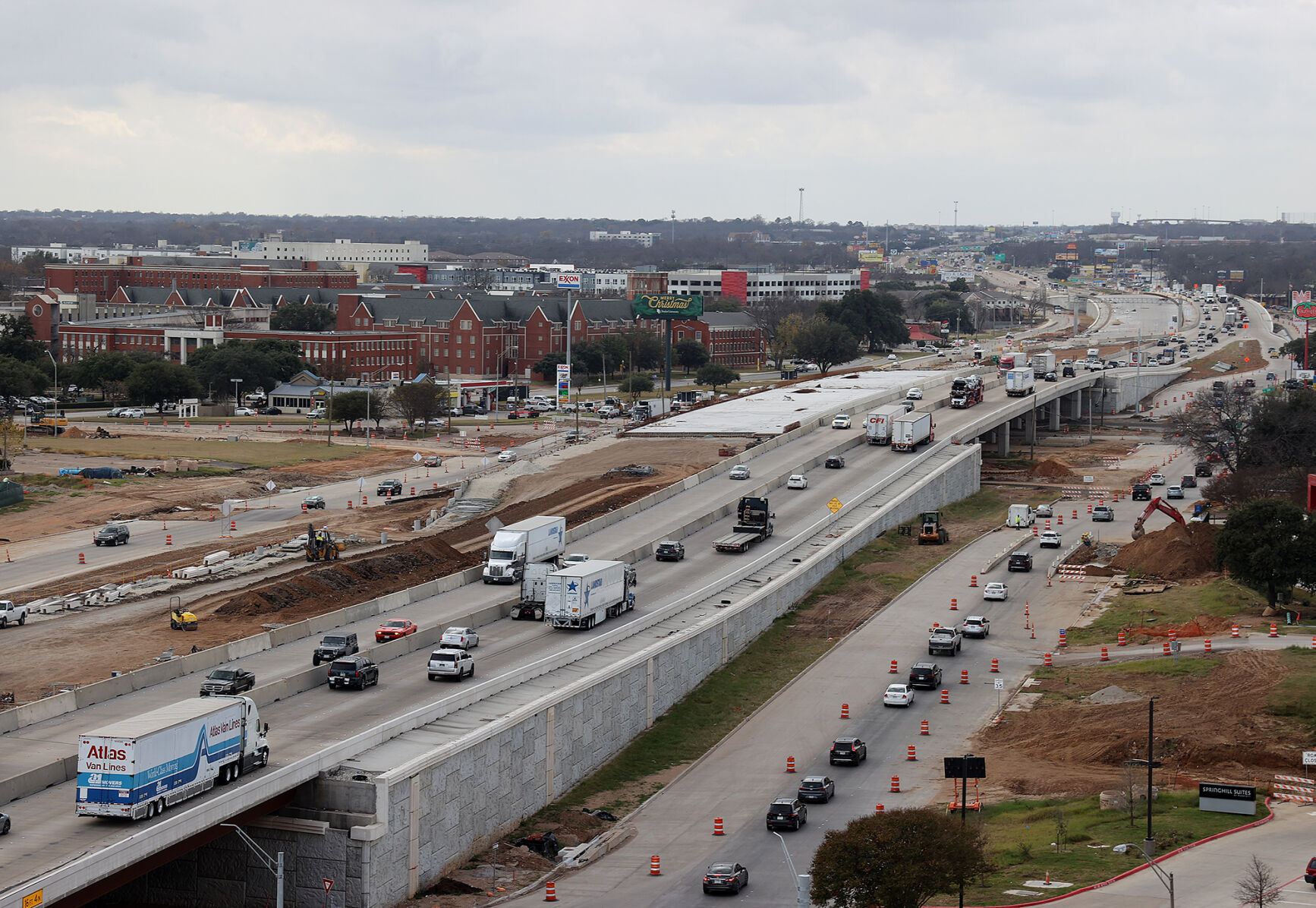

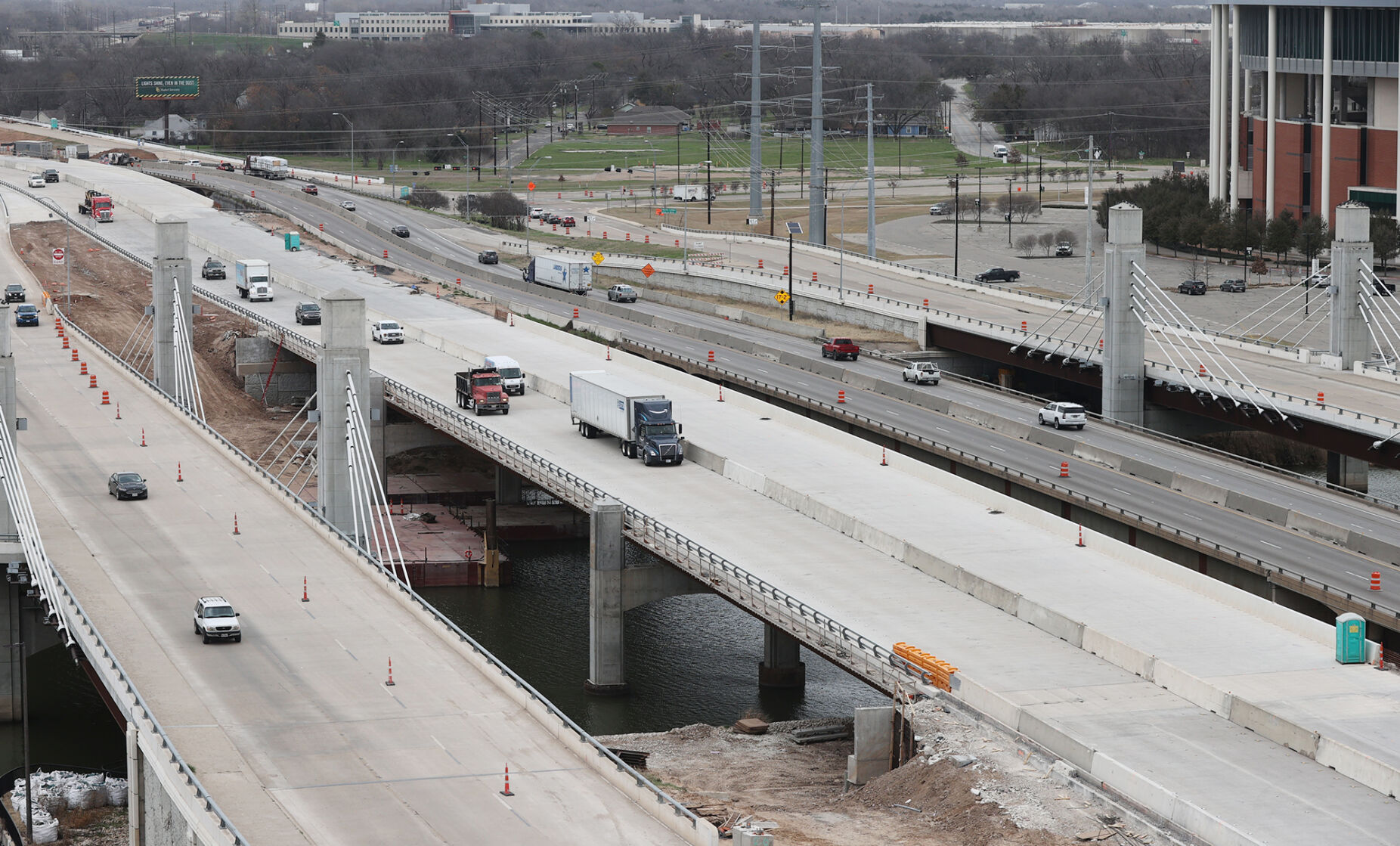

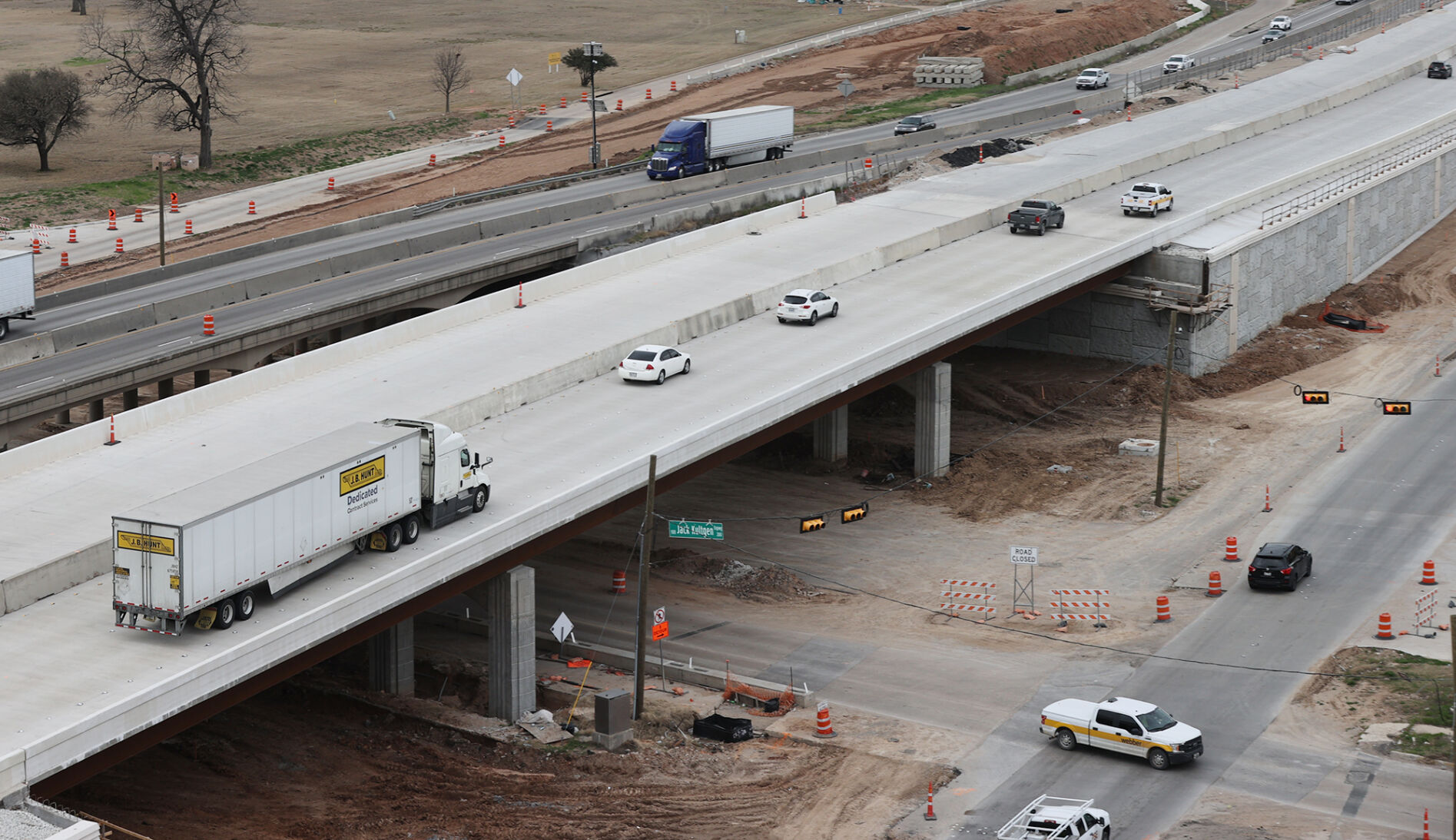

Work continues on the northbound main lanes, with the now-complete southbound side carrying traffic in both directions.

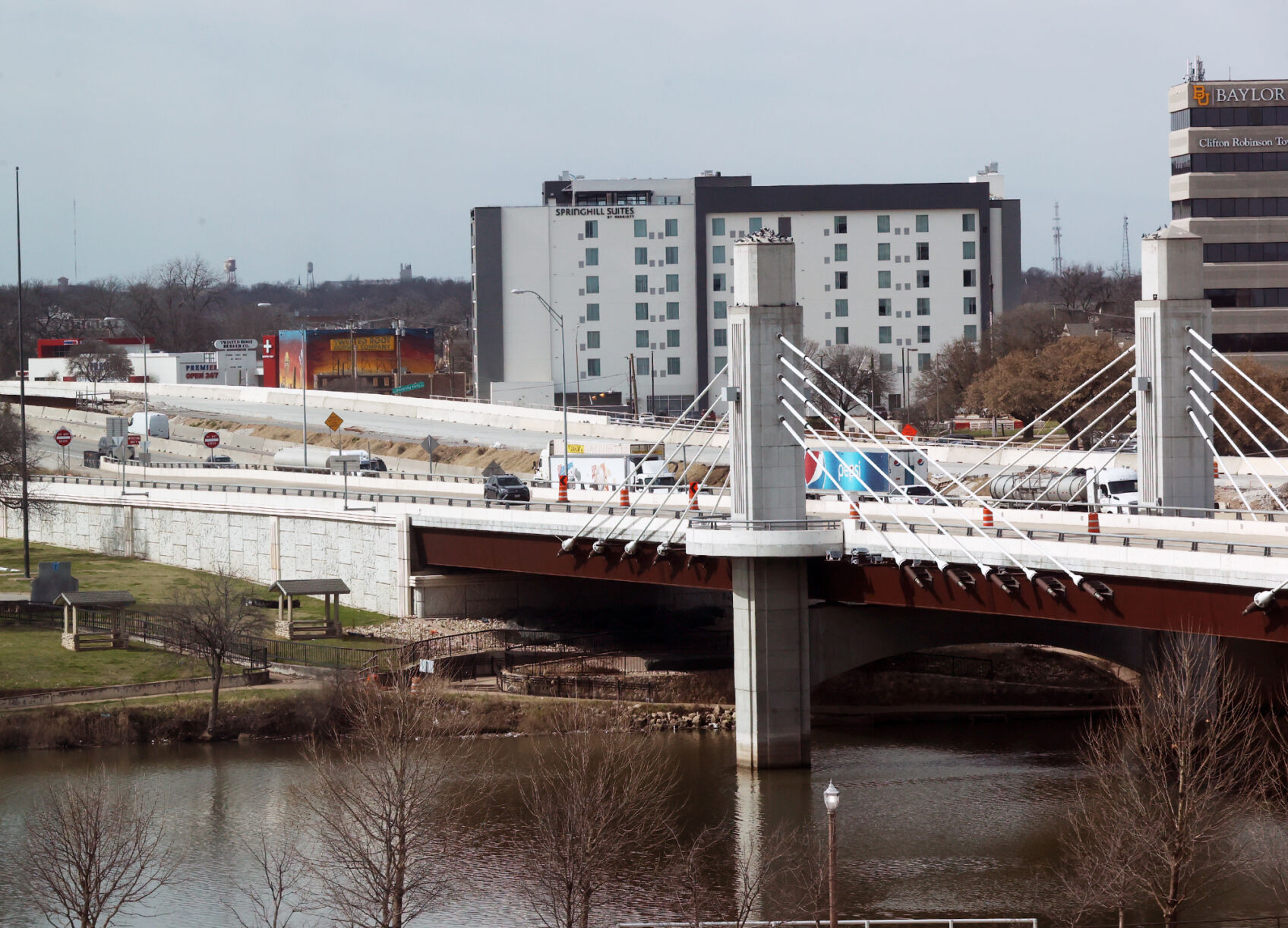

Converting Washington Avenue to a two-way street from Fifth Street to 18th Street also has captured Waco’s attention to the tune of $3.9 million. That price will cover street milling and overlay, signs, signals, striping and corner ramps that are Americans with Disabilities Act compliant.
That work, now visible at nearly every intersection along Washington Avenue downtown, has a projected January completion date.
Meanwhile, city crews are installing new sanitary sewer line and piping along University Parks Drive, near the Waco Hilton, Indian Spring Park and the restaurants and shops clustered along Mary Avenue. The work carries a $1.57 million price tag, and the city predicts completion this fall.

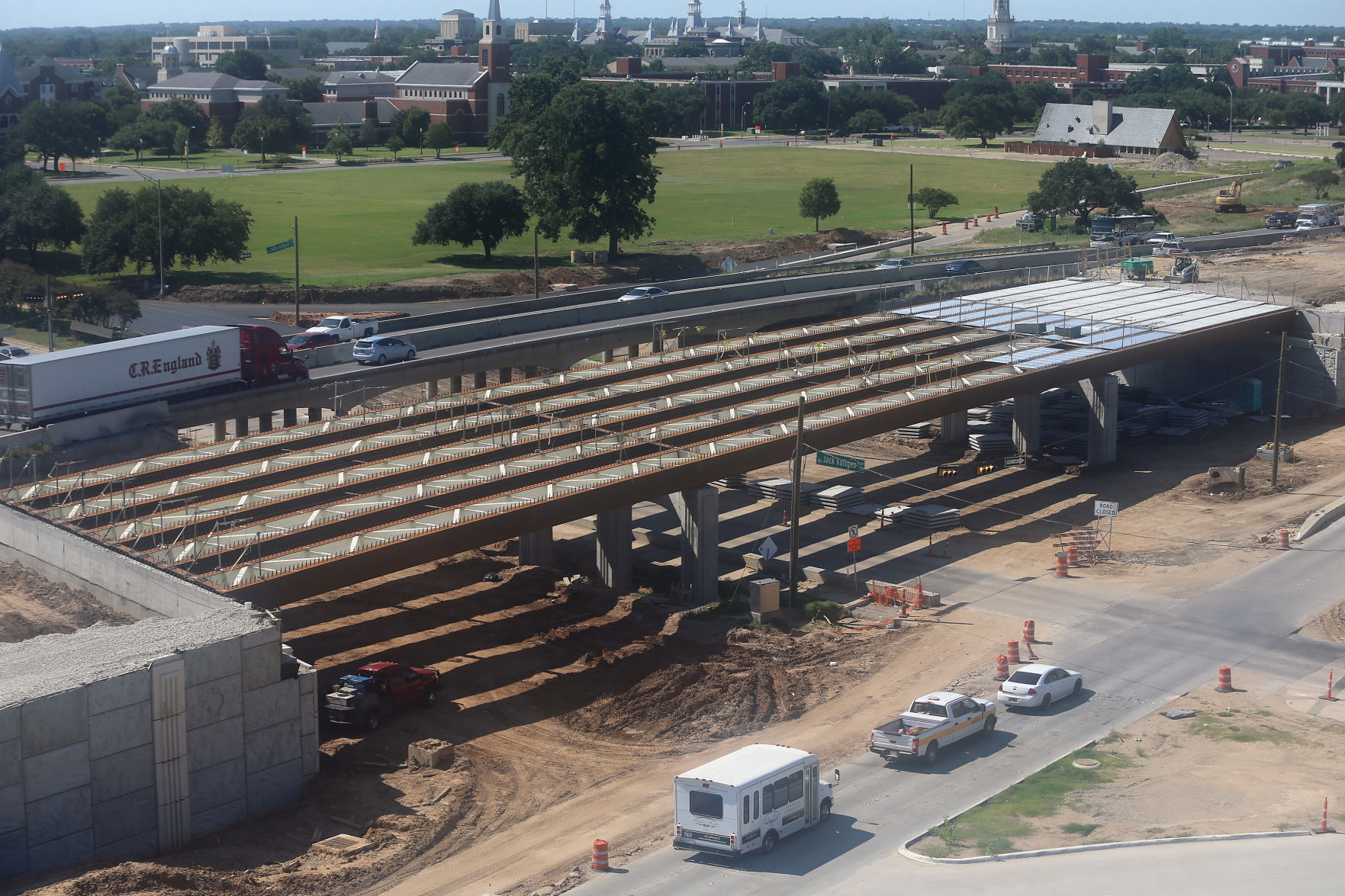

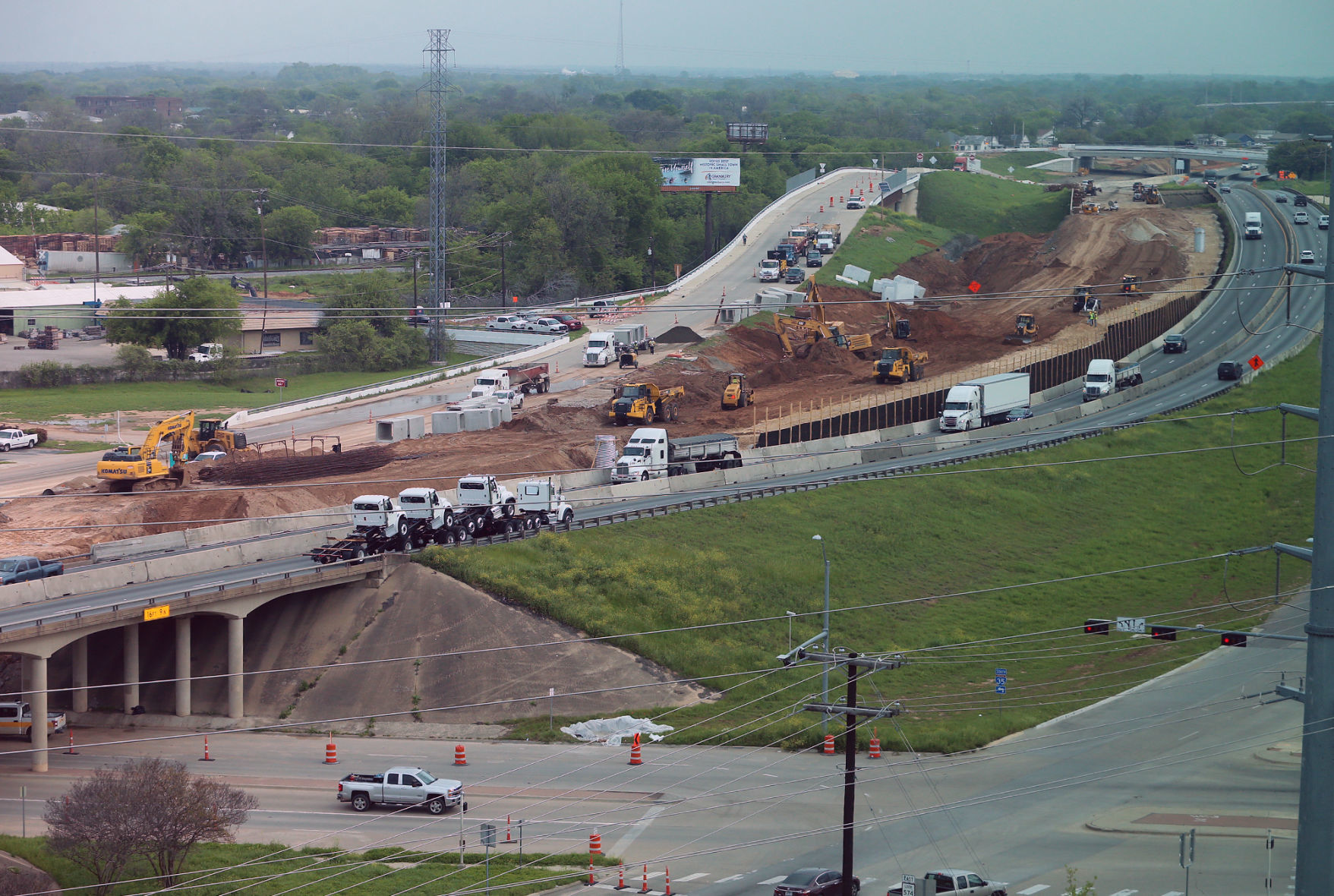

Interstate 35 widening project through Waco: 2019-2022

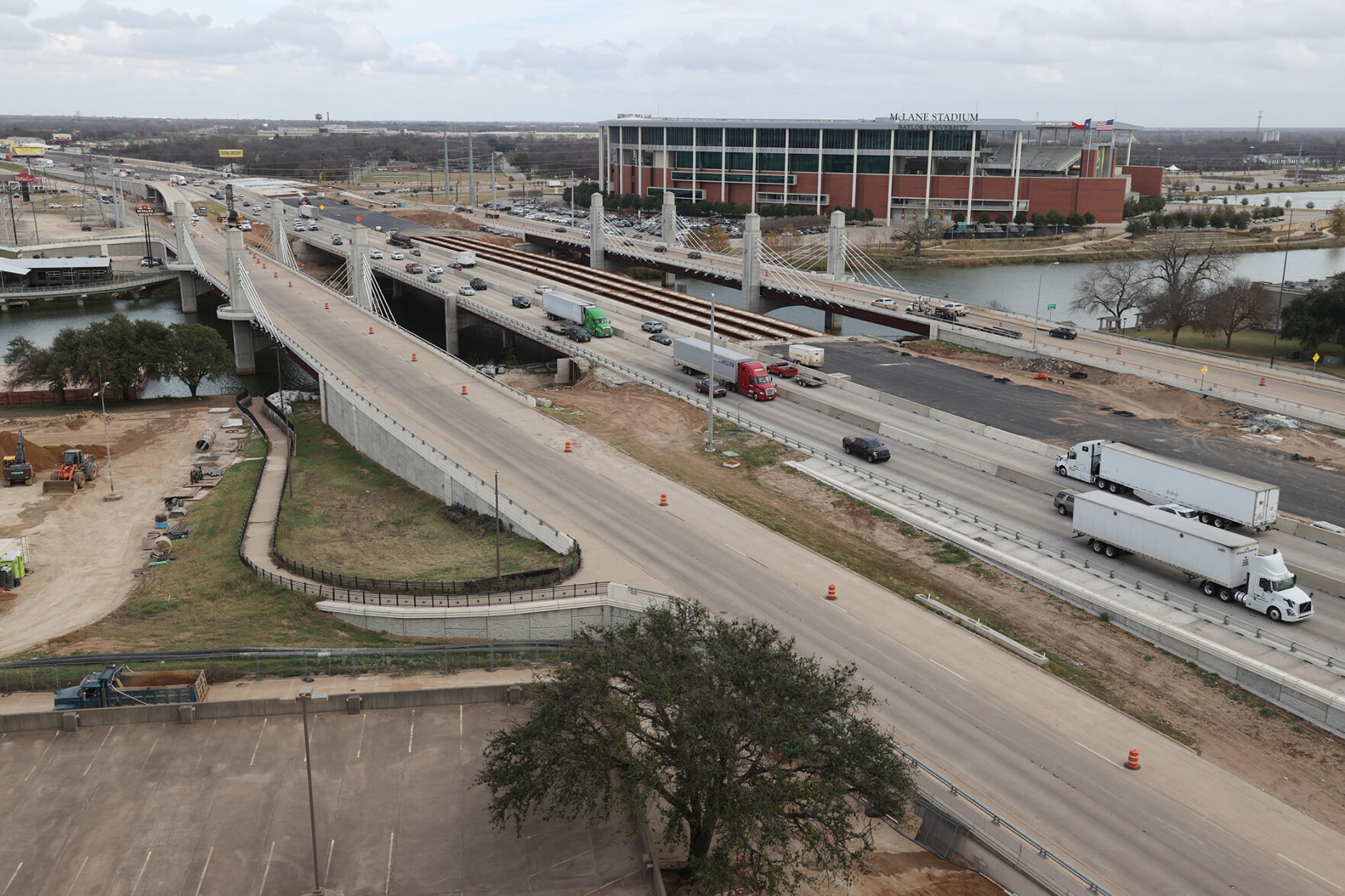

Interstate 35: March 2022

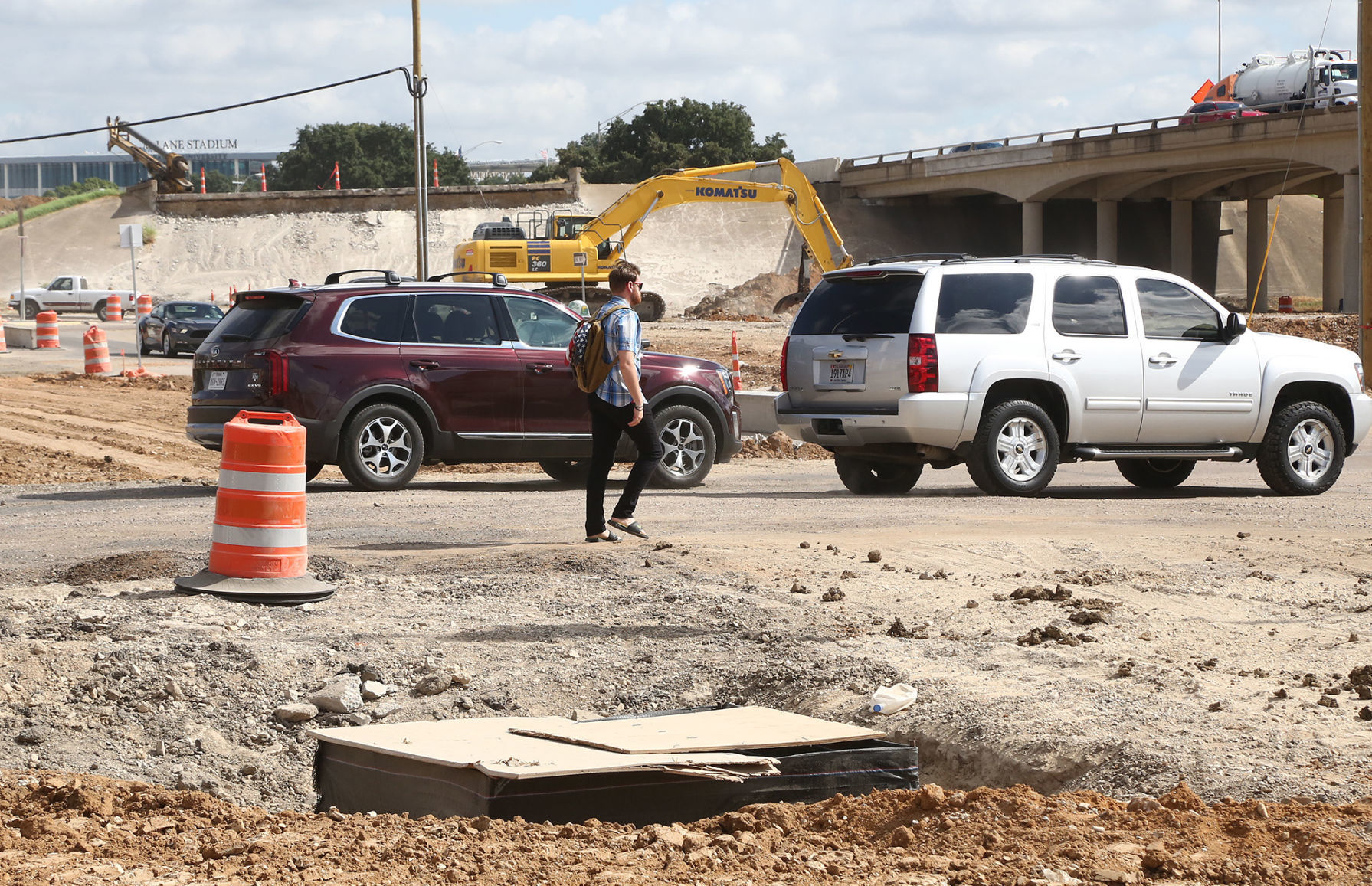

A man makes his way along the sidewalk near the northbound access road on Interstate 35, just south of the Lake Shore Drive exit.
Interstate 35: March 2022

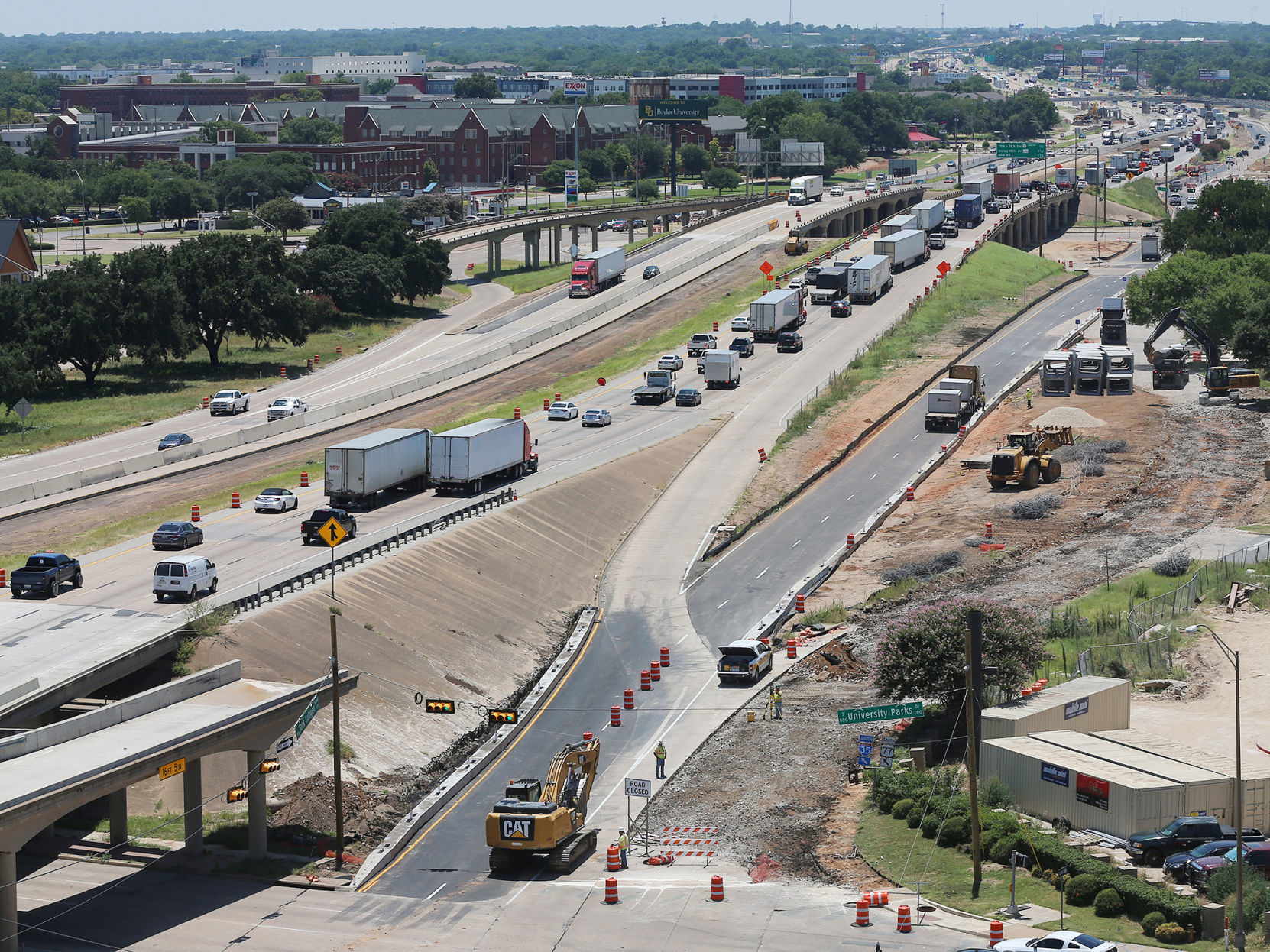

North of Waco Drive, a new section of northbound I-35 is in use for the first time since the $341 million reconstruction and widening started in April 2019. To the south, traffic in both directions continues to share what will eventually be the southbound side of the highway.
Interstate 35: March 2022

As the interstate crosses Waco Drive, traffic in both directions still shares what will be the southbound side of the highway. Just to the north though, the northbound traffic now shifts to new northbound pavement.
Interstate 35: March 2022

A man makes his way along the sidewalk near the northbound access road on Interstate 35, just south of the Lake Shore Drive exit.
Interstate 35: January 2022

Vehicles drive up and down Interstate 35.
Interstate 35: January 2022

Vehicles drive up and down Interstate 35.
Interstate 35: September 2021

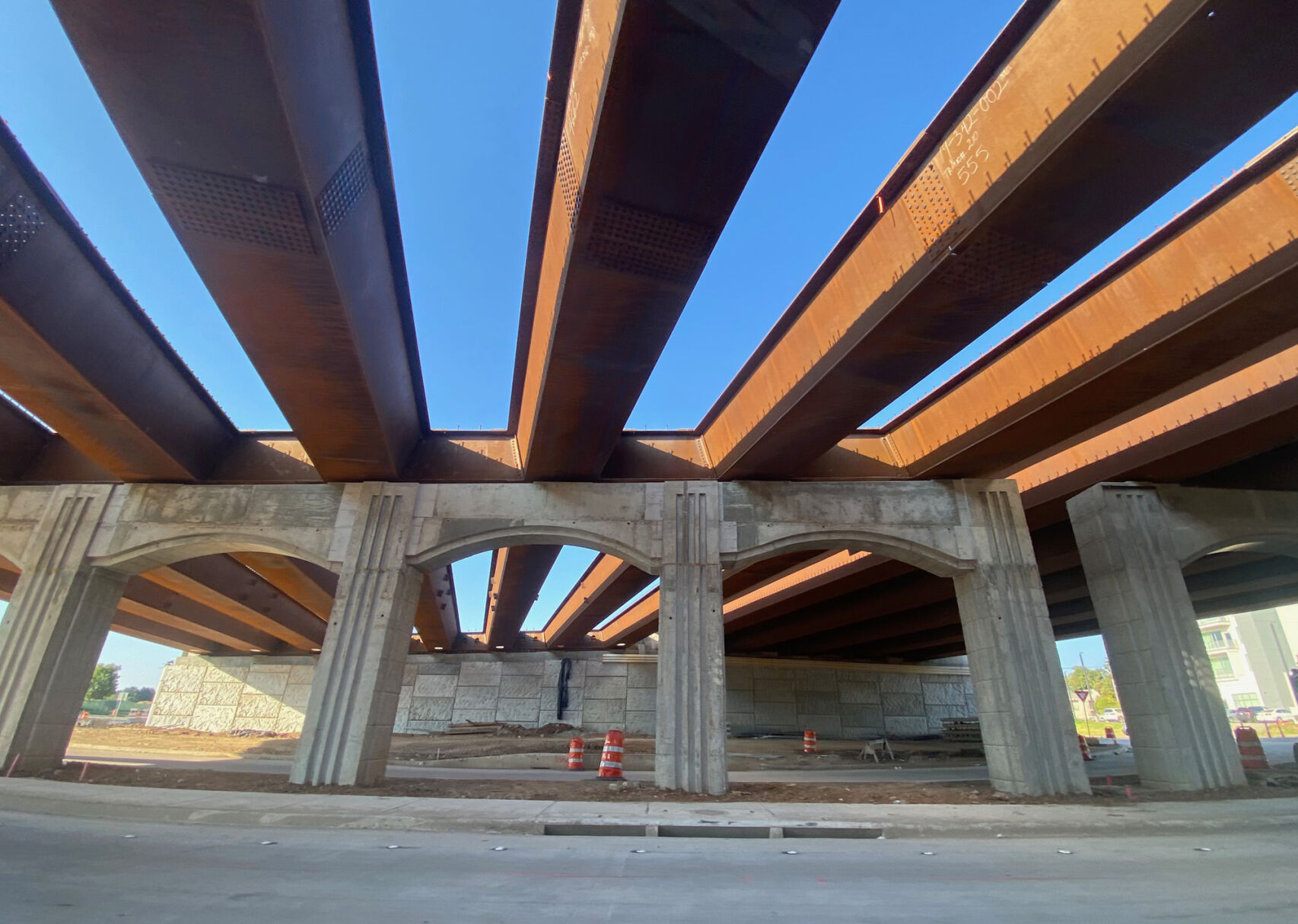

Metal support beams span over University Parks Drive as expansion of Interstate 35 continues.
Interstate 35: Aug. 2021

Heavy machinery works on a bridge ramp on the northbound lane of Interstate 35 under construction and making an illusion of the 22-story Alico being buried.
Interstate 35: Aug. 2021

Work continues on the northbound main lanes, with the now-complete southbound side carrying traffic in both directions.
Interstate 35: Aug. 2021

Frontage road intersections are a current focus of the I-35 expansion project through Waco.
Interstate 35: Aug. 2021

Frontage road intersections are a current focus of the I-35 expansion project through Waco.
Interstate 35: Aug. 2021

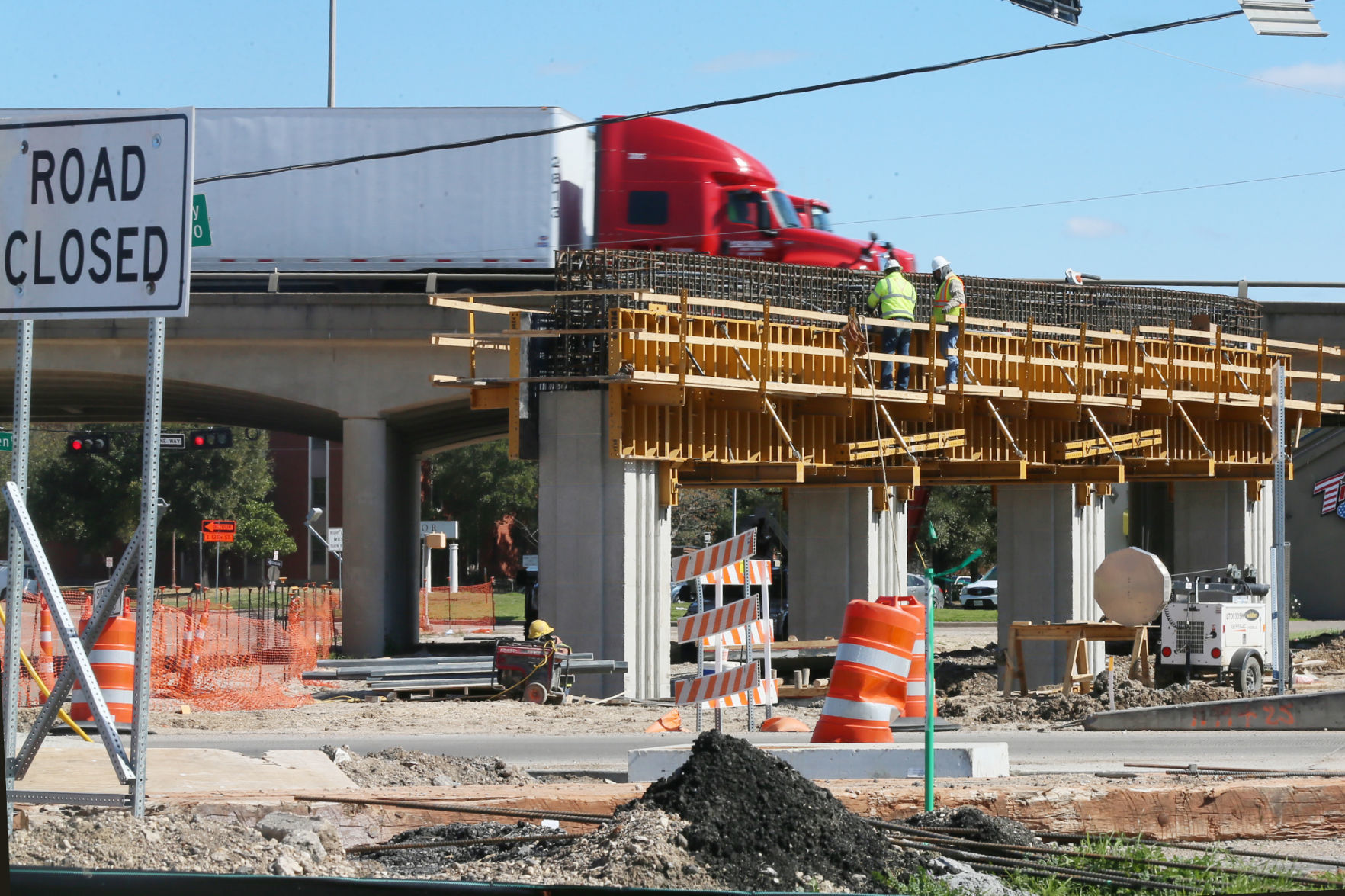

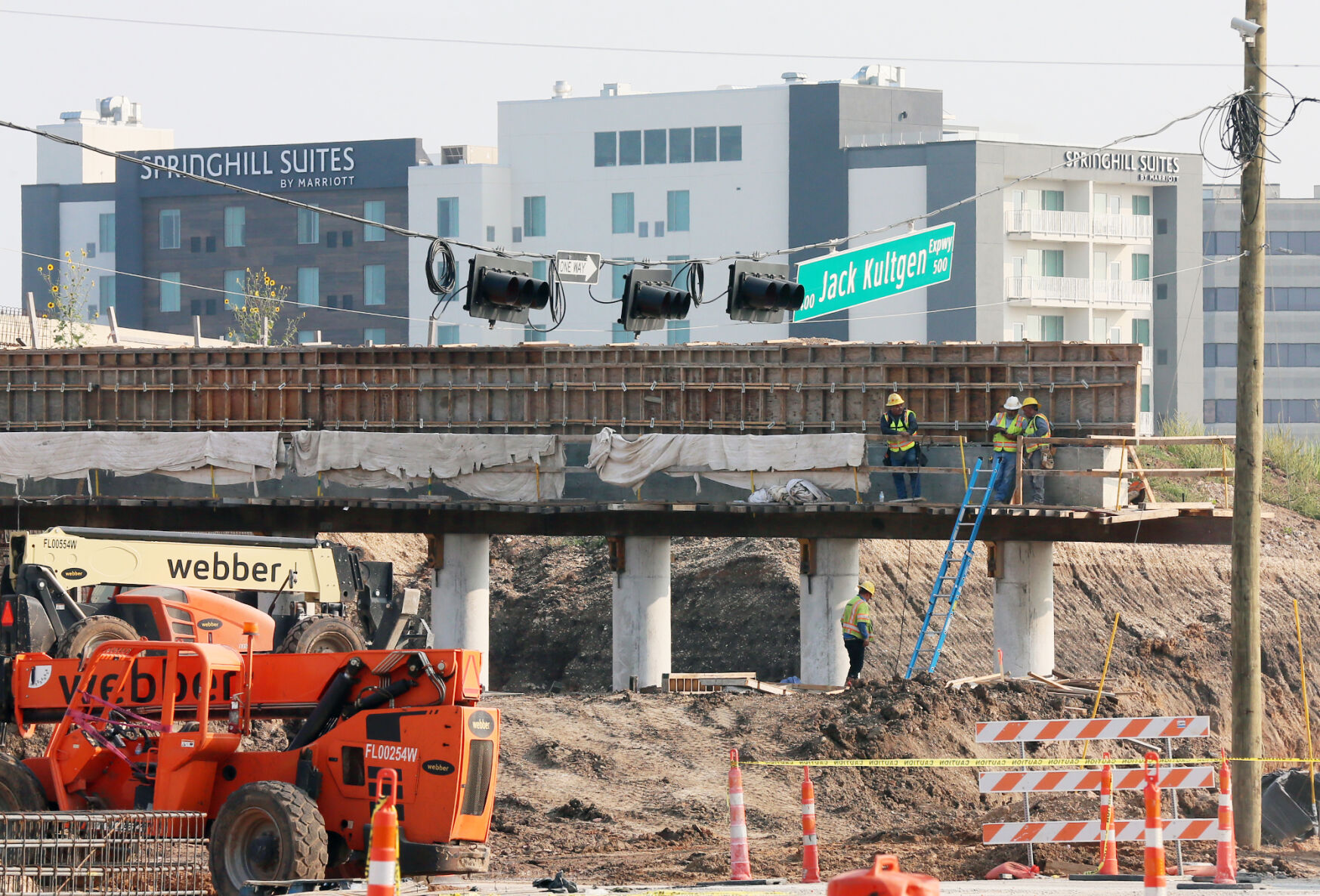

A northbound Interstate 35 overpass takes shape at the Fourth and Fifth street intersection. The project includes nine bridges in each direction, including the Brazos River crossing.
Interstate 35: Aug. 2021

The newly built southbound main lanes of Interstate 35 are carrying traffic in both directions while work continues on the northbound side.
Interstate 35: Aug. 2021

Frontage road intersections are a current focus of the I-35 expansion project through Waco.
Interstate 35: Aug. 2021

Frontage road intersections are a current focus of the I-35 expansion project through Waco.
Interstate 35: Aug. 2021

Frontage road intersections are a current focus of the I-35 expansion project through Waco.
Interstate 35: Aug. 2021

Frontage road intersections are a current focus of the I-35 expansion project through Waco.
Interstate 35: Aug. 2021

Frontage road intersections are a current focus of the I-35 expansion project through Waco.
Interstate 35: Aug. 2021

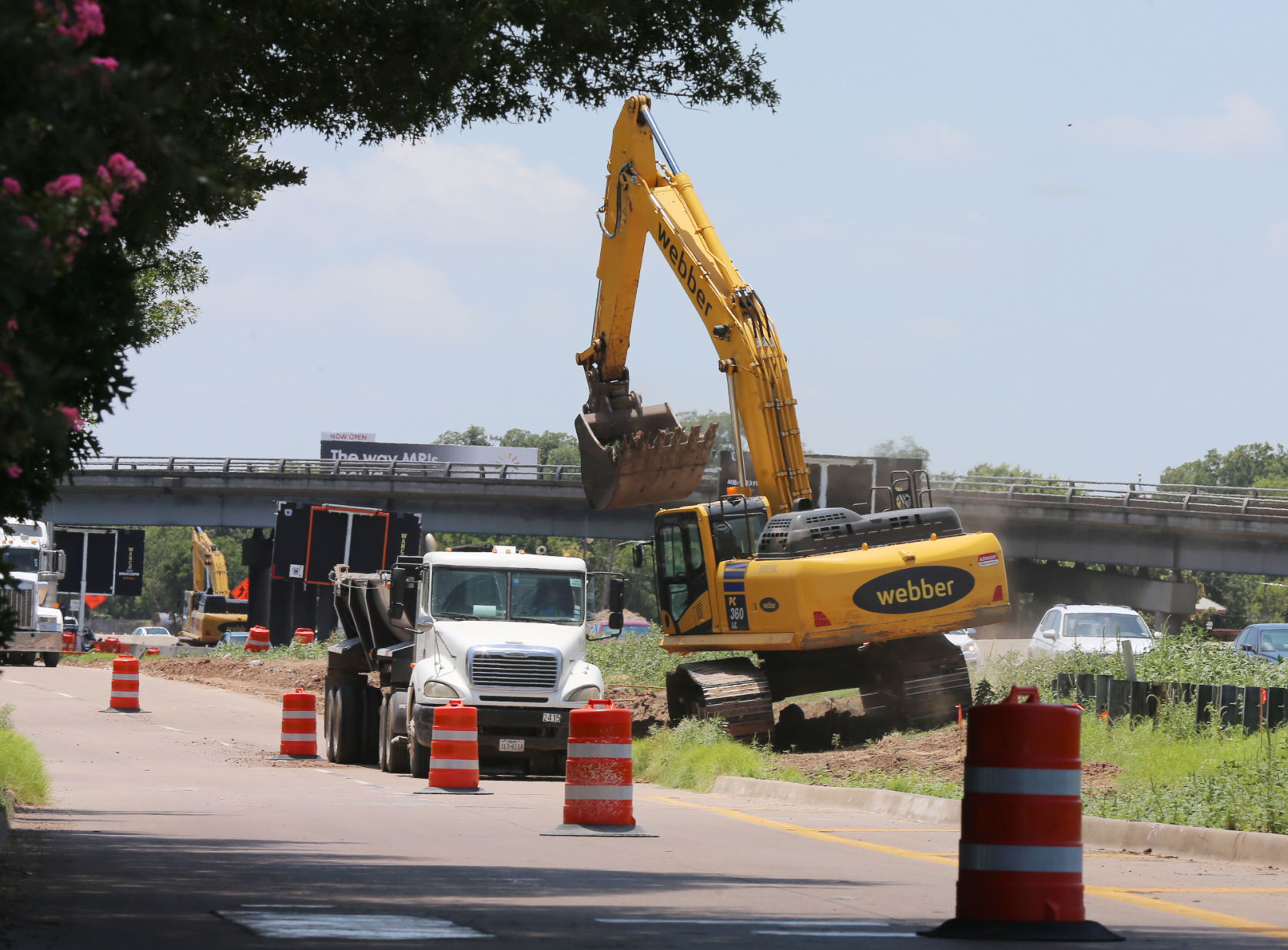

Webber LLC has an average of 150 people at a time working on the I-35 expansion through Waco, with peaks of 230, plus subcontractors.
Interstate 35: Aug. 2021

Frontage road intersections are a current focus of the I-35 expansion project through Waco.
Interstate 35: Aug. 2021

Frontage road intersections are a current focus of the I-35 expansion project through Waco.
Interstate 35: Aug. 2021

Frontage road intersections are a current focus of the I-35 expansion project through Waco.
Interstate 35: Aug. 2021

Frontage road intersections are a current focus of the I-35 expansion project through Waco.
Interstate 35: Aug. 2021

Frontage road intersections are a current focus of the I-35 expansion project through Waco.
Interstate 35: Aug. 2021

Frontage road intersections are a current focus of the I-35 expansion project through Waco.
Interstate 35: Aug. 2021

Frontage road intersections are a current focus of the I-35 expansion project through Waco.
Interstate 35: Aug. 2021

Frontage road intersections are a current focus of the I-35 expansion project through Waco.
Interstate 35: May 2021

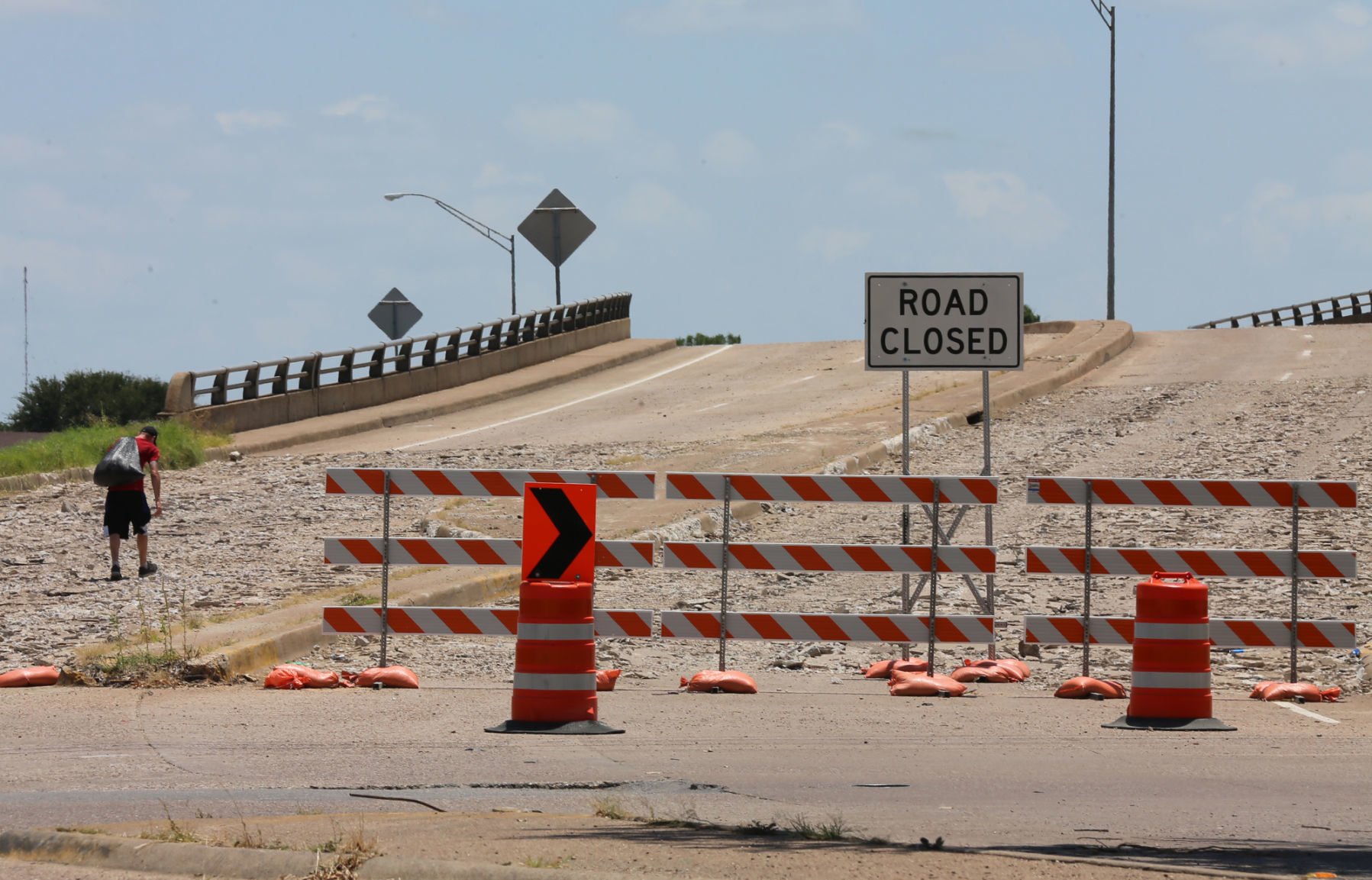

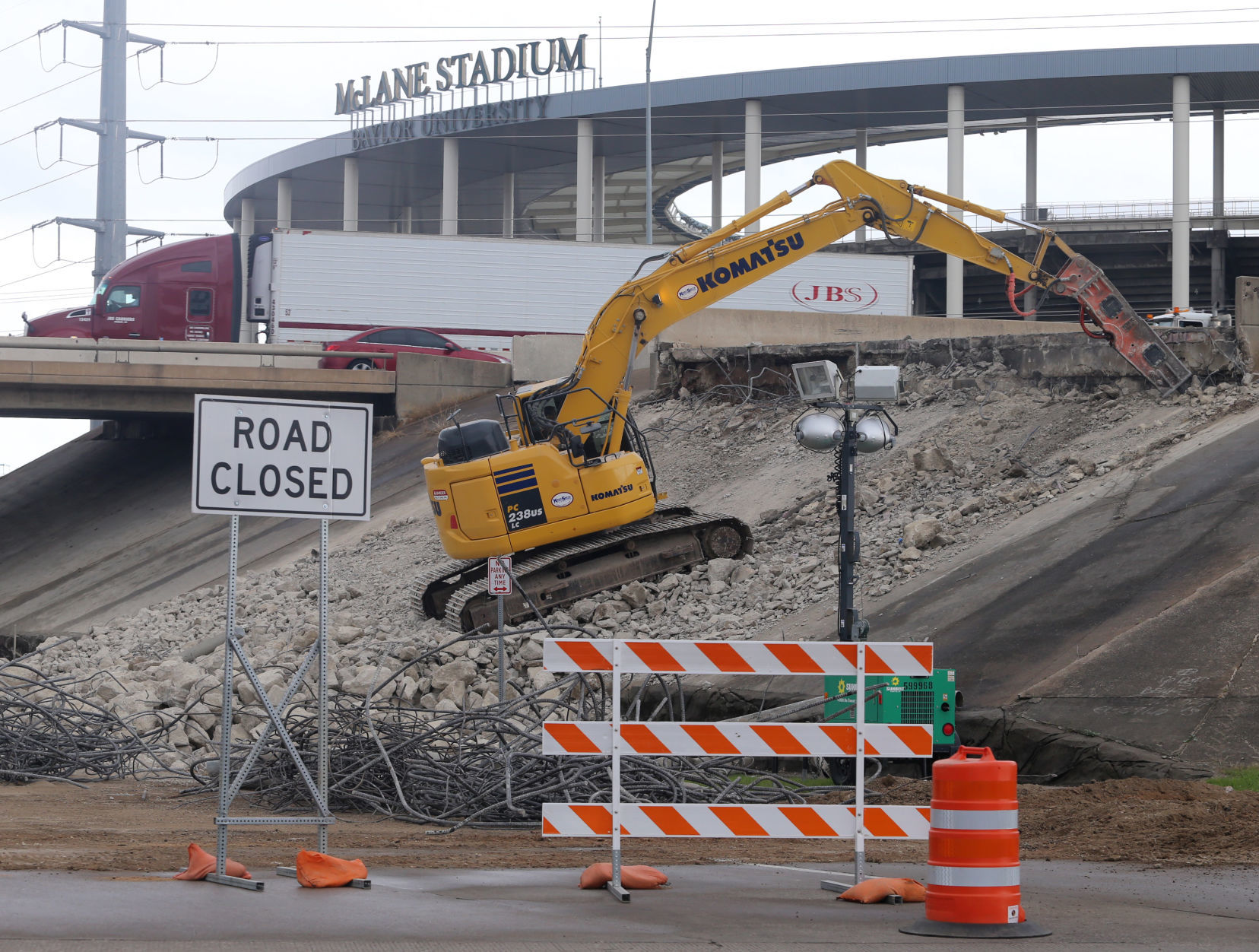

Work continues on the removal of the old northbound overpass at Business 77.
Interstate 35: May 2021

Work continues on the removal I-35 overpasses on the I-35 overpass at BUS 77.
Interstate 35: May 2021

Work continues on the removal I-35 overpasses on the I-35 overpass at BUS 77.
Interstate 35: May 2021

Work continues on the removal of the old northbound Interstate over passes on the I-35 overpass at BUS 77.
Interstate 35: March 2021

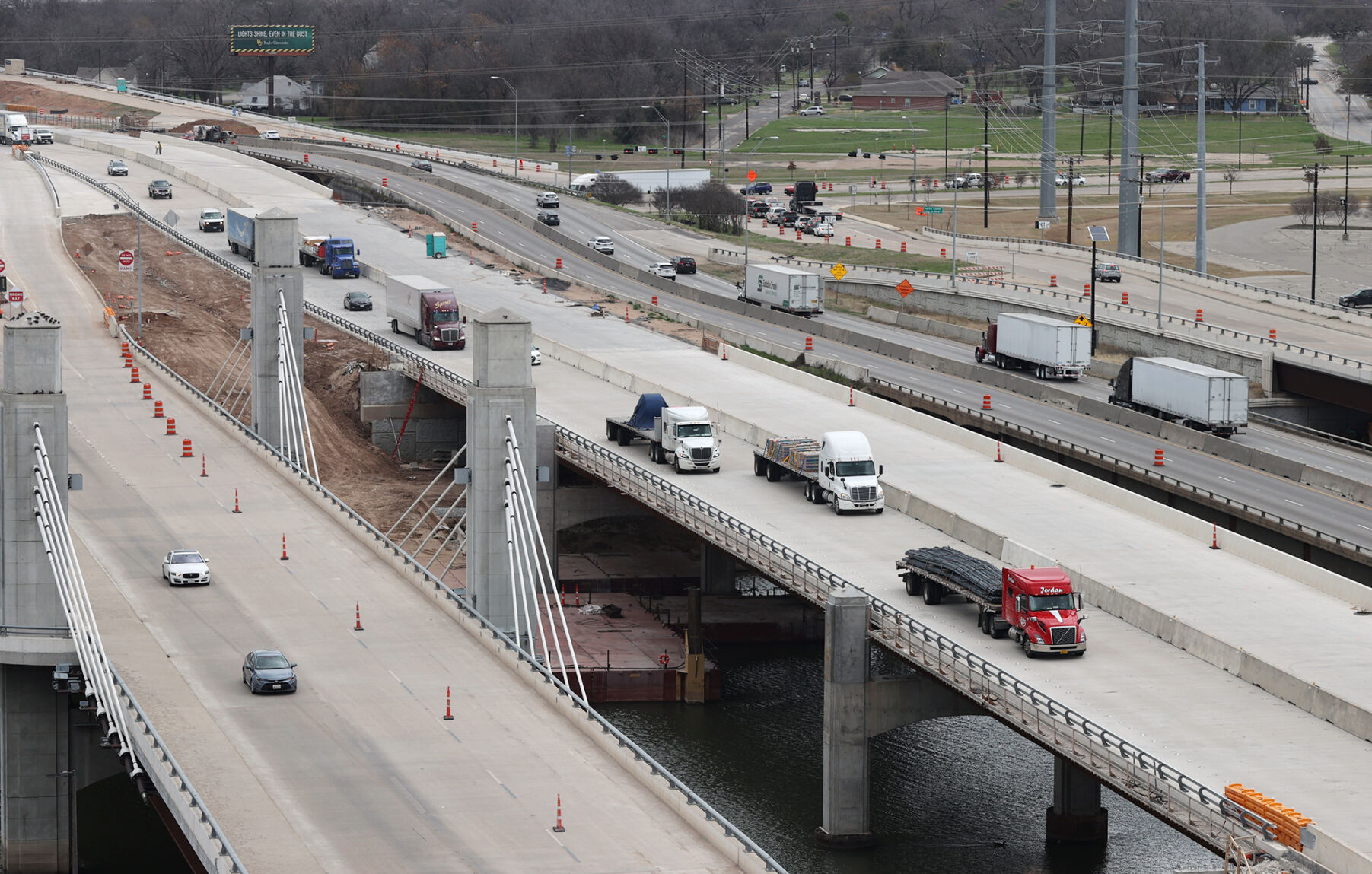

The new southbound I-35 bridge over Fourth and Fifth streets (left) is temporarily carrying traffic in both directions while the northbound side is rebuilt.
Interstate 35: March 2021

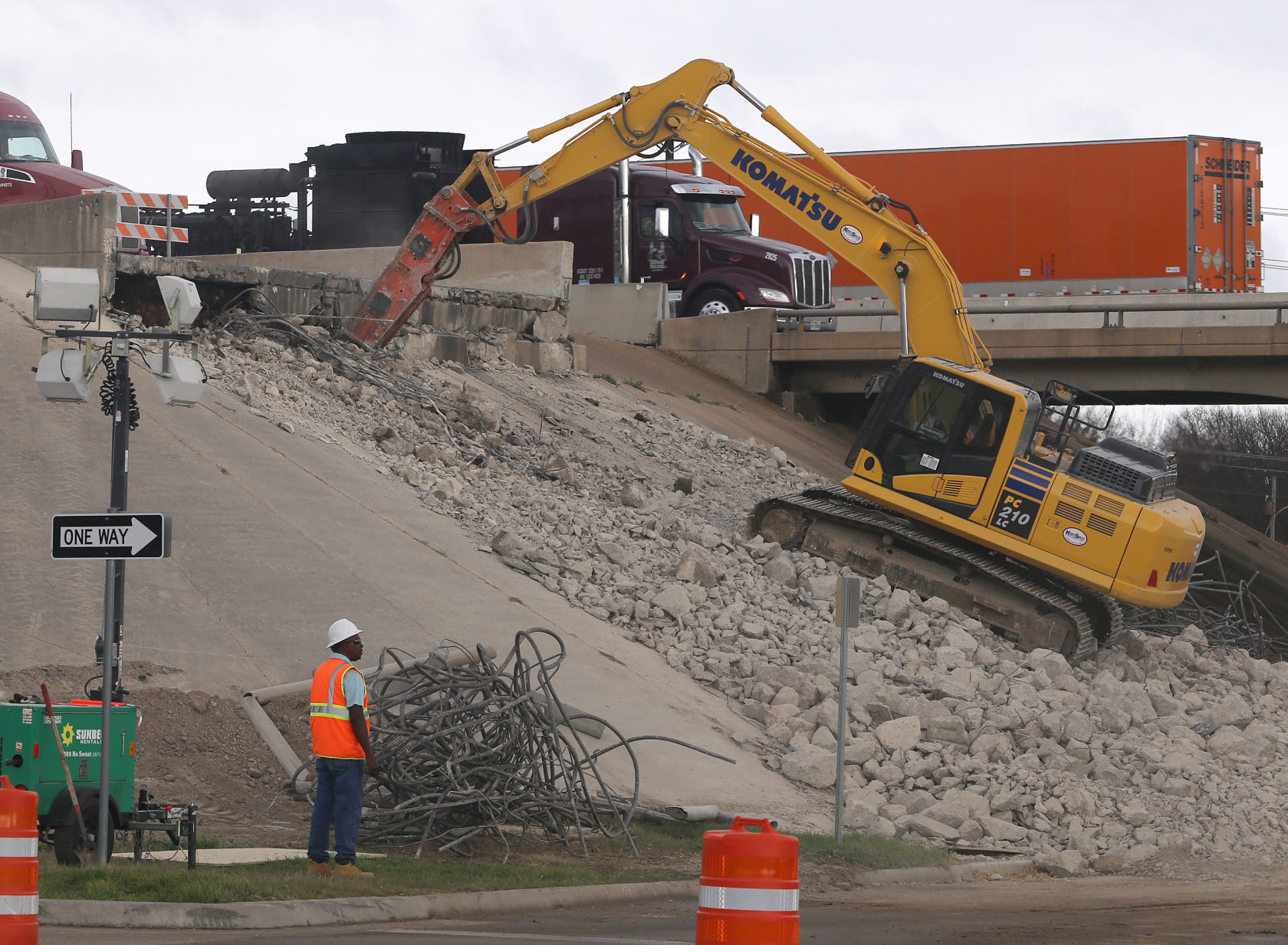

Demolition is set to start Monday, March 29 and continue for five days on the northbound I-35 bridge over Fourth and Fifth streets. Crews took down and cleared northbound overpasses last week at University Parks Drive and Martin Luther King Jr. Boulevard.

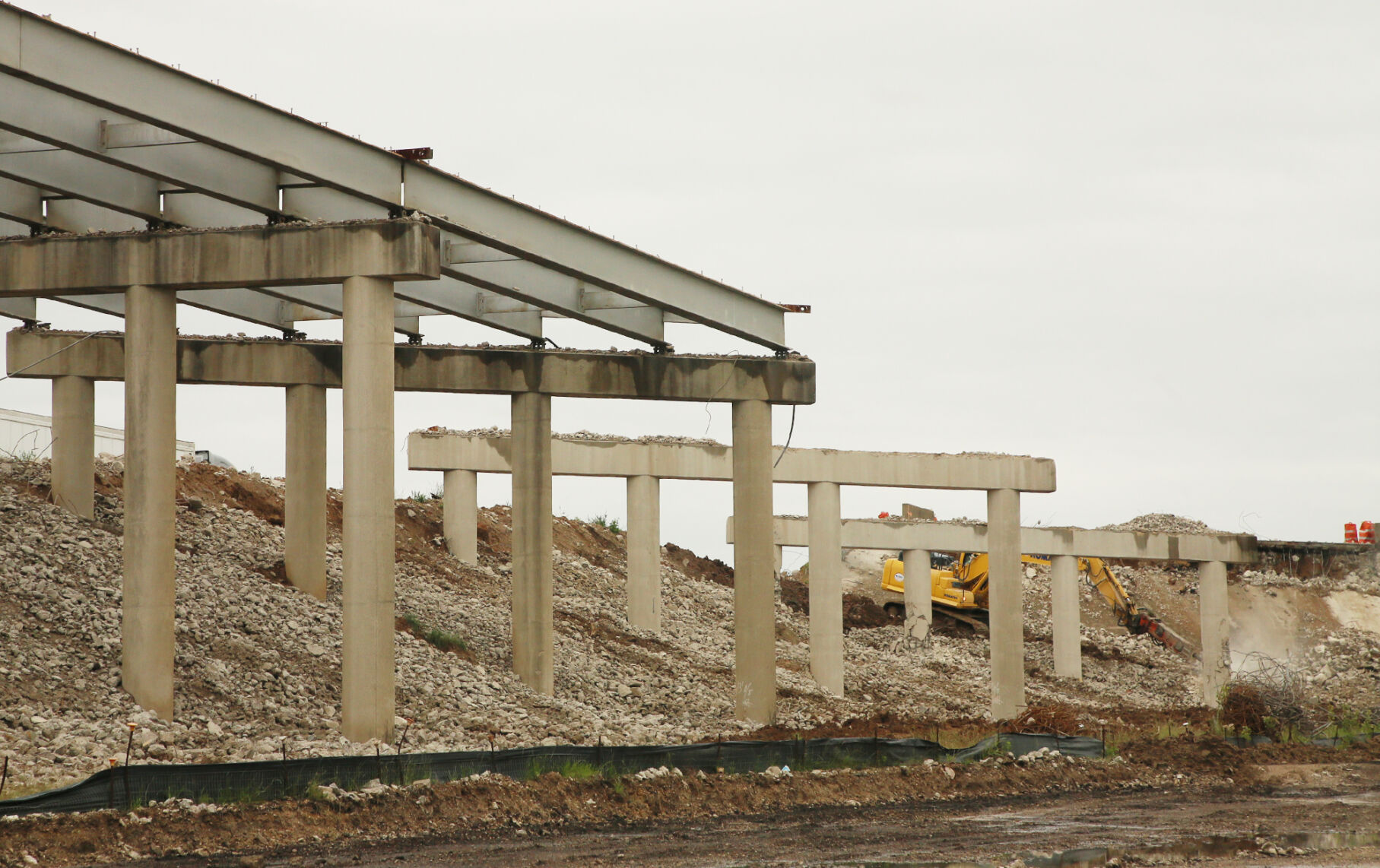

Interstate 35: March 2021

Traffic has been shifted from the northbound Interstate 35 bridge over the Brazos, and the demolition process is expected to start Monday, March 29.
Interstate 35: March 2021

Traffic has been shifted from the northbound Interstate 35 bridge over the Brazos, and the demolition process is expected to start Monday, March 29.
Interstate 35: March 2021

Northbound bridge of Intestate 35 is expected to be demolished beginning Monday, March 29.
Interstate 35: March 2021

Northbound bridge of Intestate 35 is expected to be demolished beginning Monday, March 29.
Interstate 35: March 2021

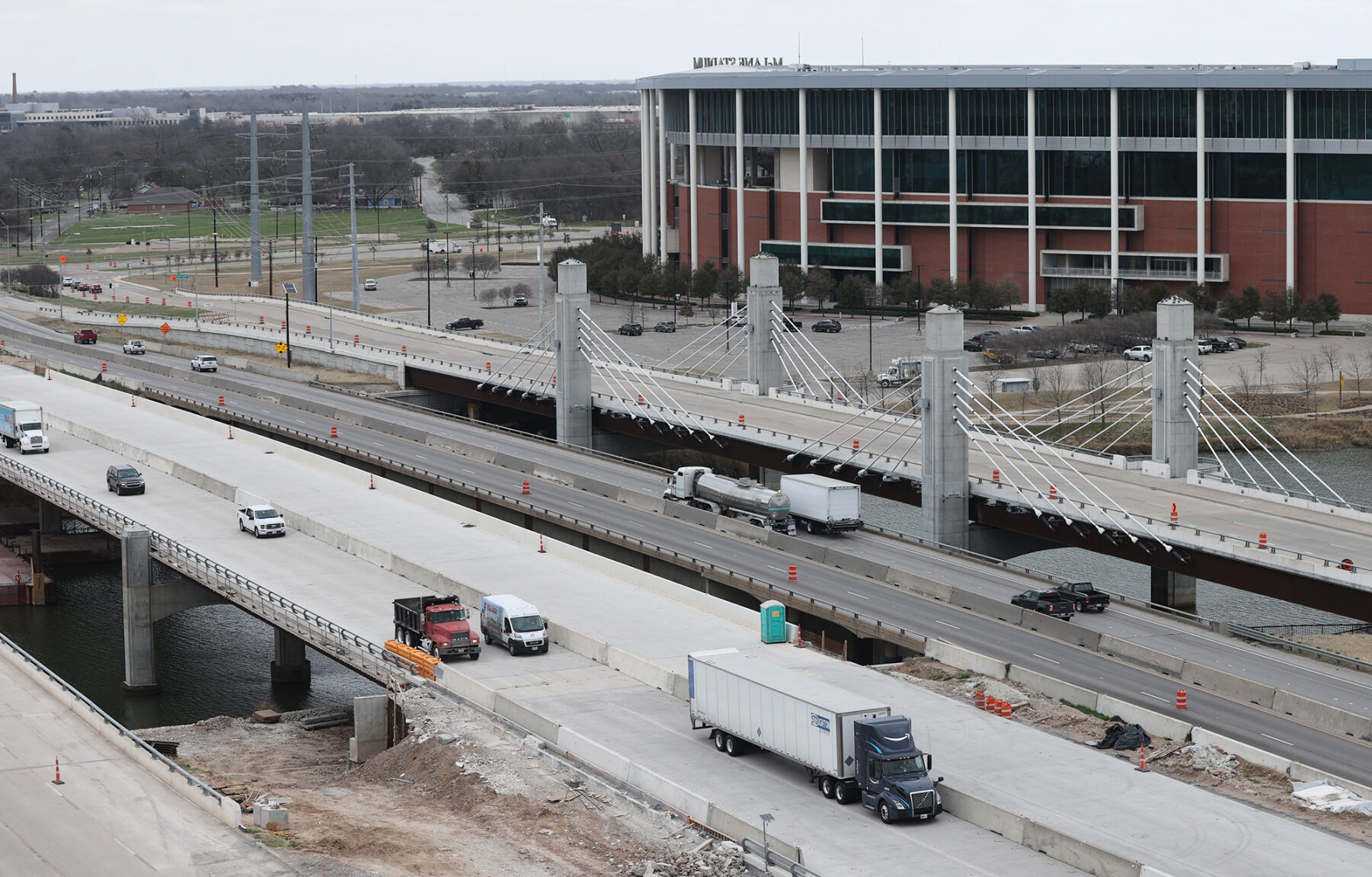

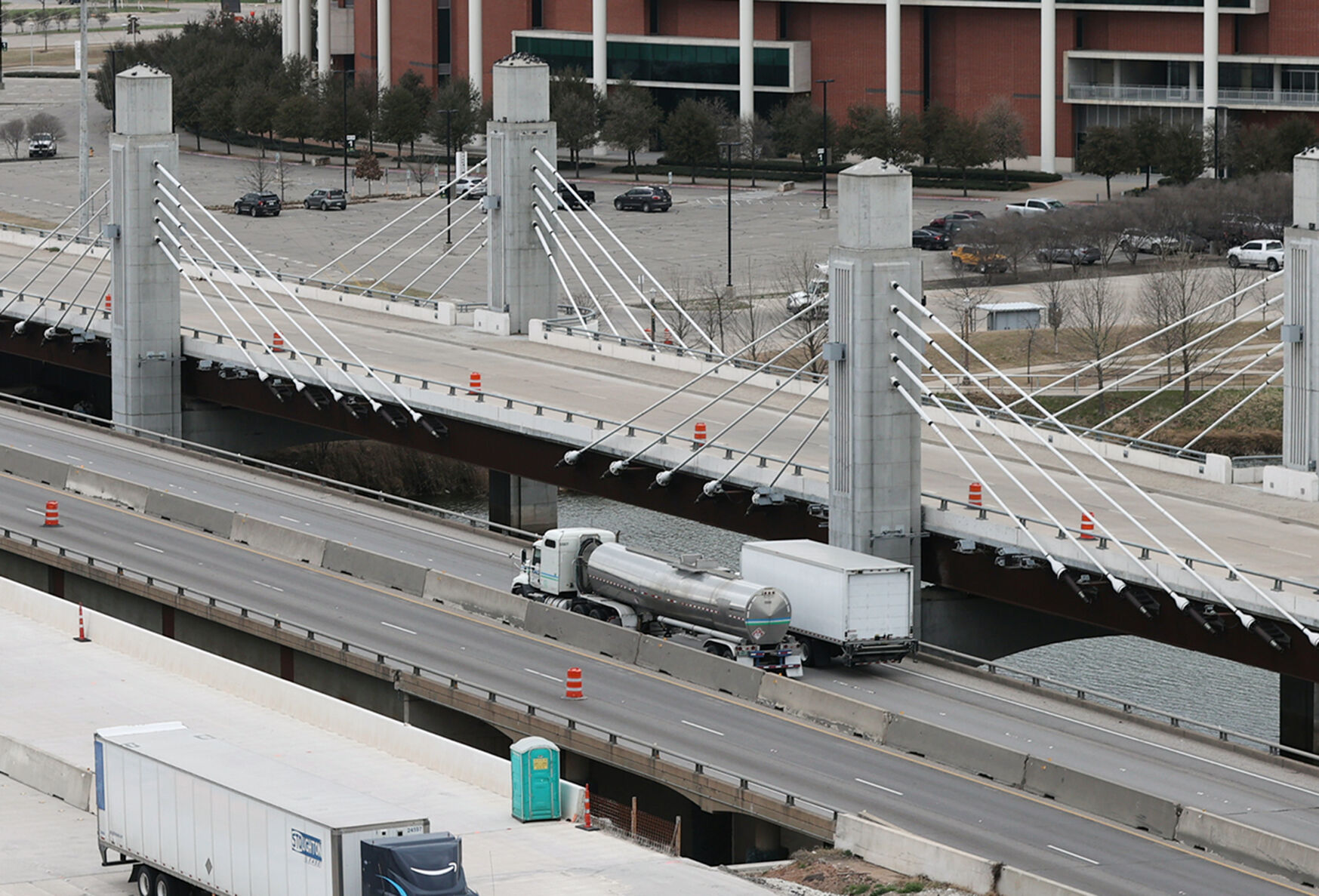

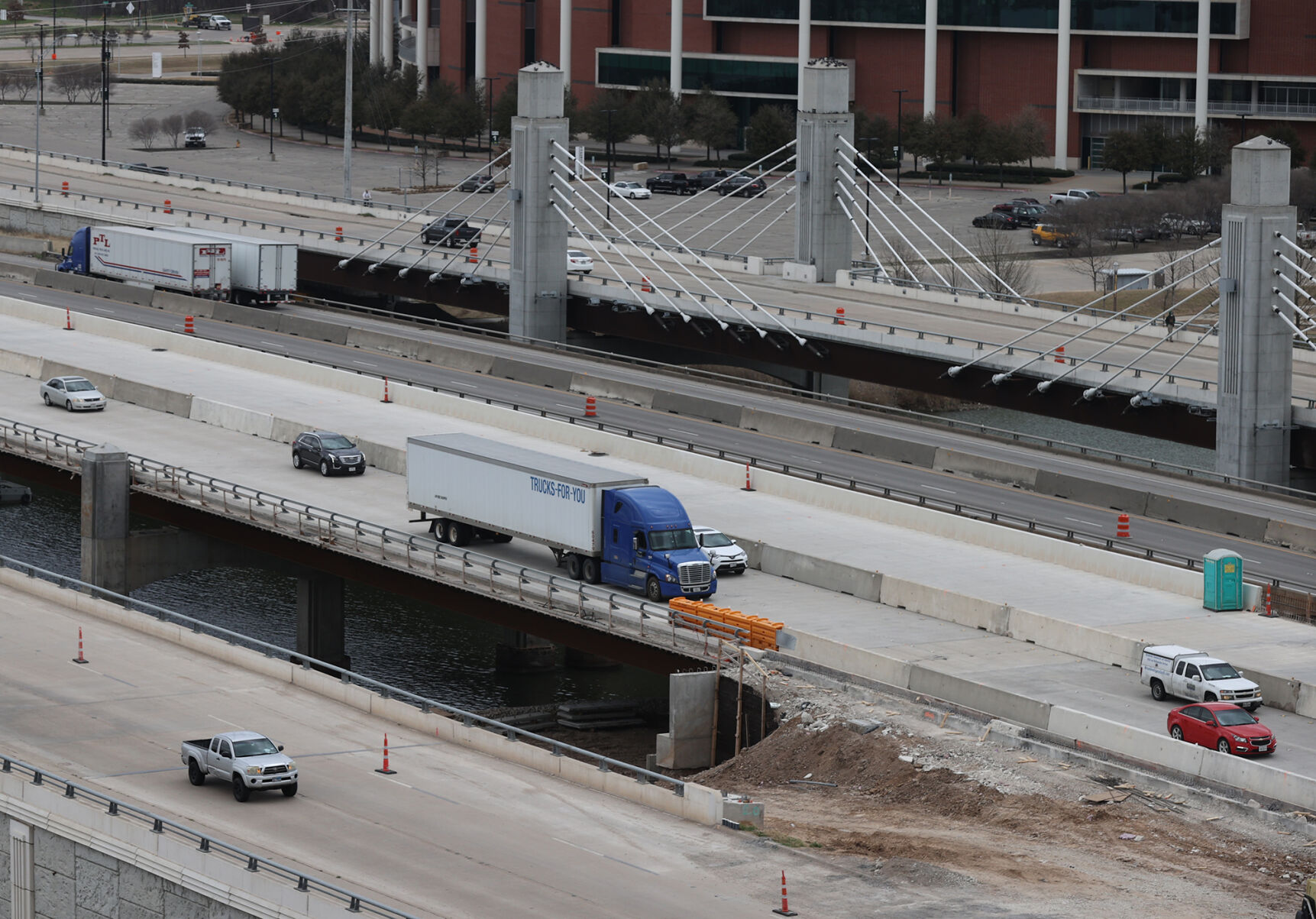

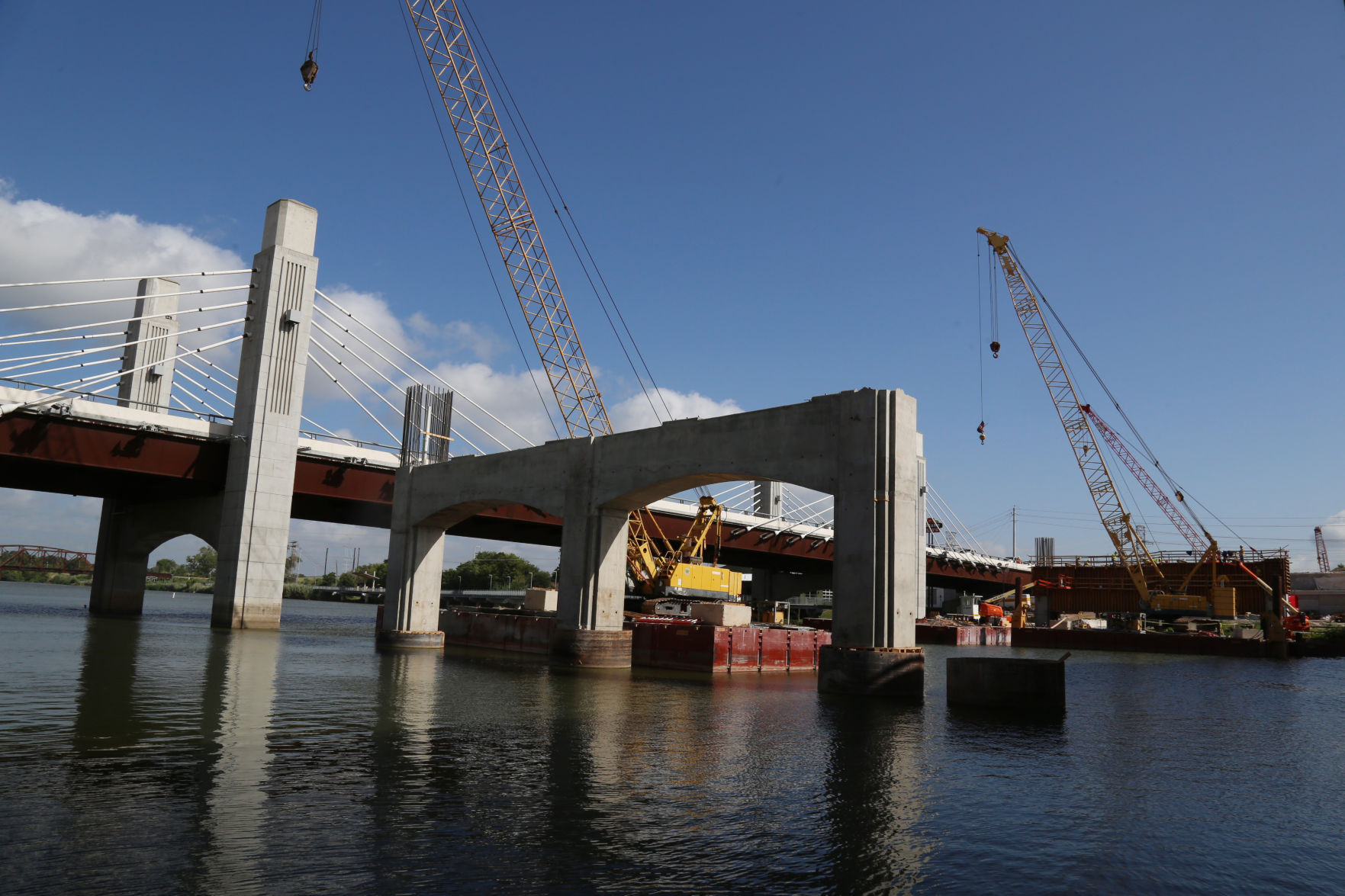

Southbound Interstate 35 traffic crosses new overpasses at Fourth and Fifth streets, bottom, and at 11th Street on Wednesday, March 10 in Waco before leaving the south end of the project area.
Interstate 35: March 2021

Southbound Interstate 35 traffic crosses the Brazos River on the new mainlane bridge on Wednesday, March 10 in Waco.
Interstate 35: March 2021

Southbound Interstate 35 traffic crosses new overpasses at Fourth and Fifth streets, bottom, and at 11th Street on Wednesday, March 10 in Waco before leaving the south end of the project area.
Interstate 35: March 2021

Southbound Interstate 35 traffic crosses new overpasses at Fourth and Fifth streets on Wednesday, March 10.
Interstate 35: March 2021

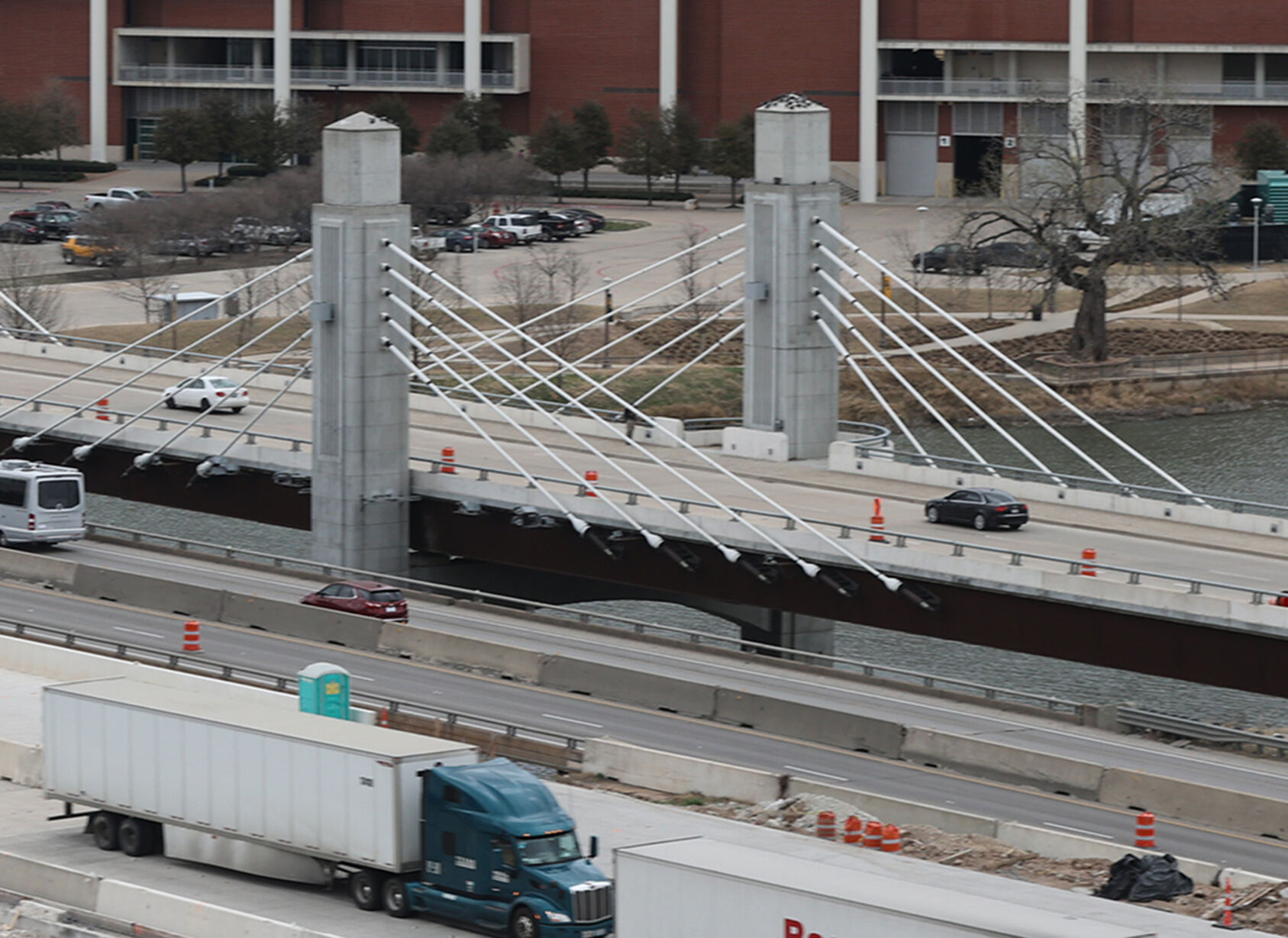

Southbound Interstate 35 traffic crosses the Brazos River on the new mainlane bridge on Wednesday, March 10 in Waco.
Interstate 35: March 2021

Southbound Interstate 35 traffic crosses the Brazos River on the new mainlane bridge on Wednesday, March 10 in Waco.
Interstate 35: March 2021

Southbound Interstate 35 traffic crosses the Brazos River on the new mainlane bridge on Wednesday, March 10 in Waco.
Interstate 35: March 2021

Southbound Interstate 35 traffic crosses the Brazos River on the new mainlane bridge on Wednesday, March 10 in Waco.
Interstate 35: March 2021

Southbound Interstate 35 traffic crosses the Brazos River on the new mainlane bridge on Wednesday, March 10 in Waco.
Interstate 35: March 2021

Southbound Interstate 35 traffic crosses the Brazos River on the new mainlane bridge on Wednesday, March 10 in Waco.
Interstate 35: March 2021

Southbound Interstate 35 traffic crosses the Brazos River on the new mainlane bridge on Wednesday, March 10 in Waco.
Interstate 35: March 2021

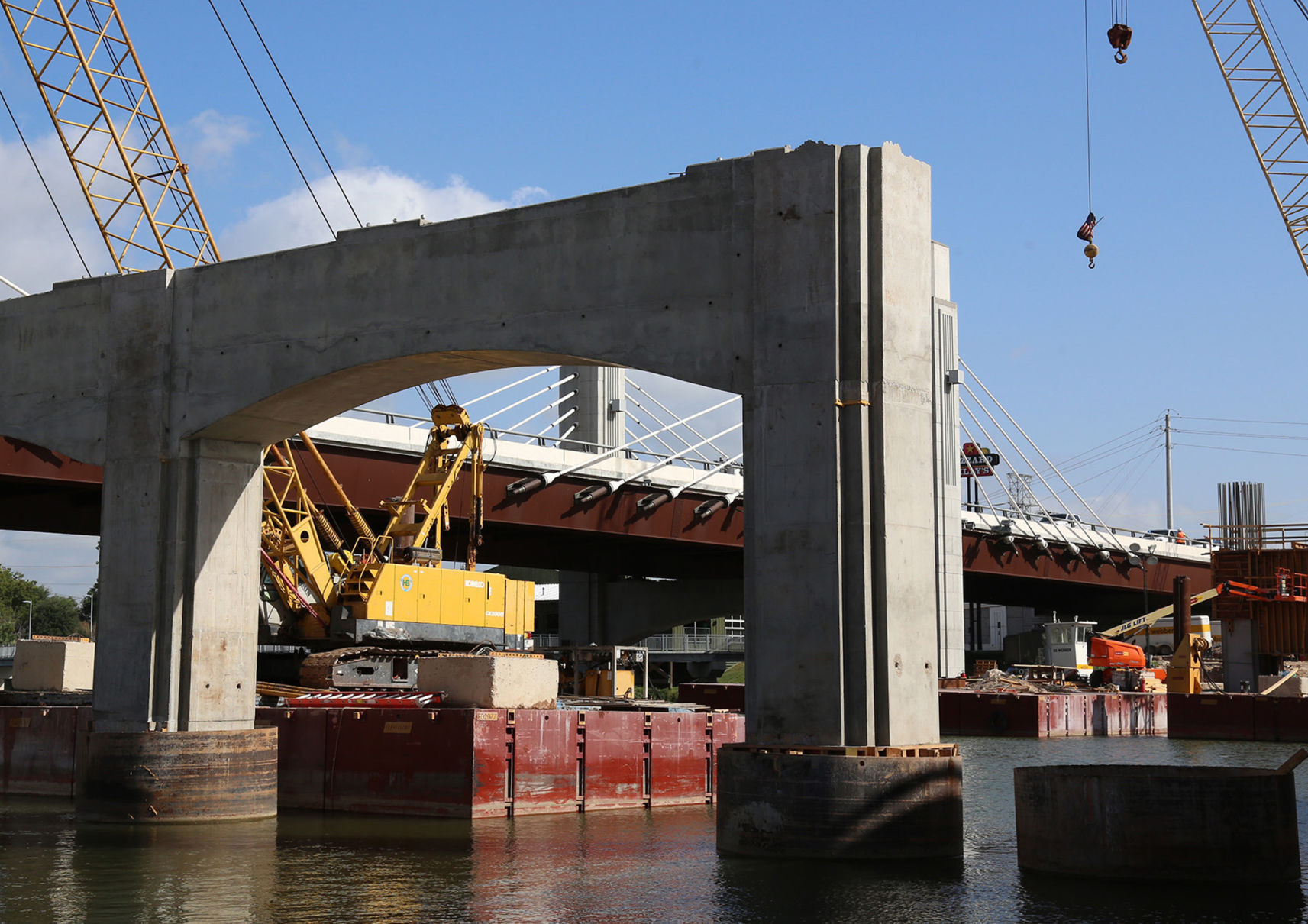

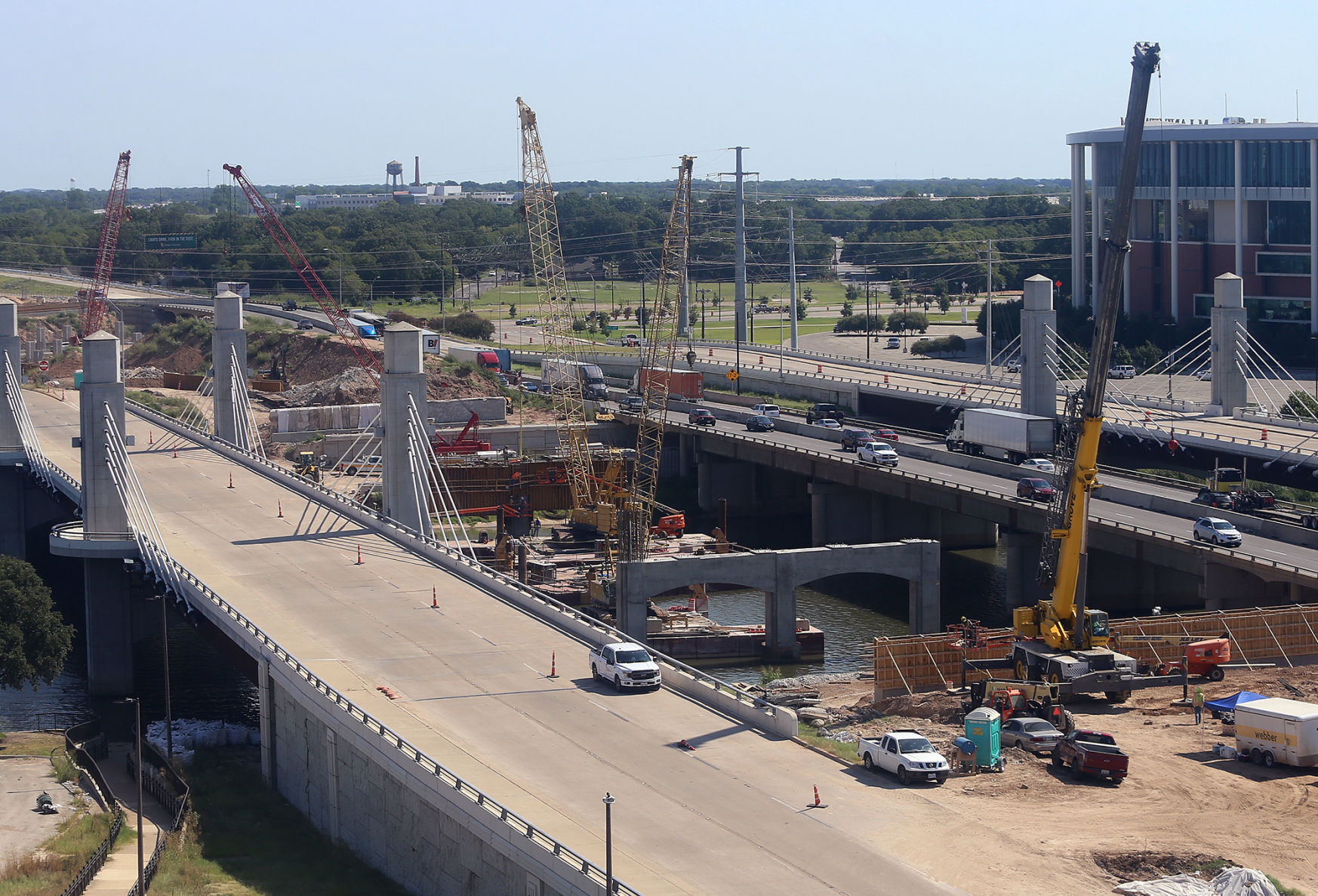

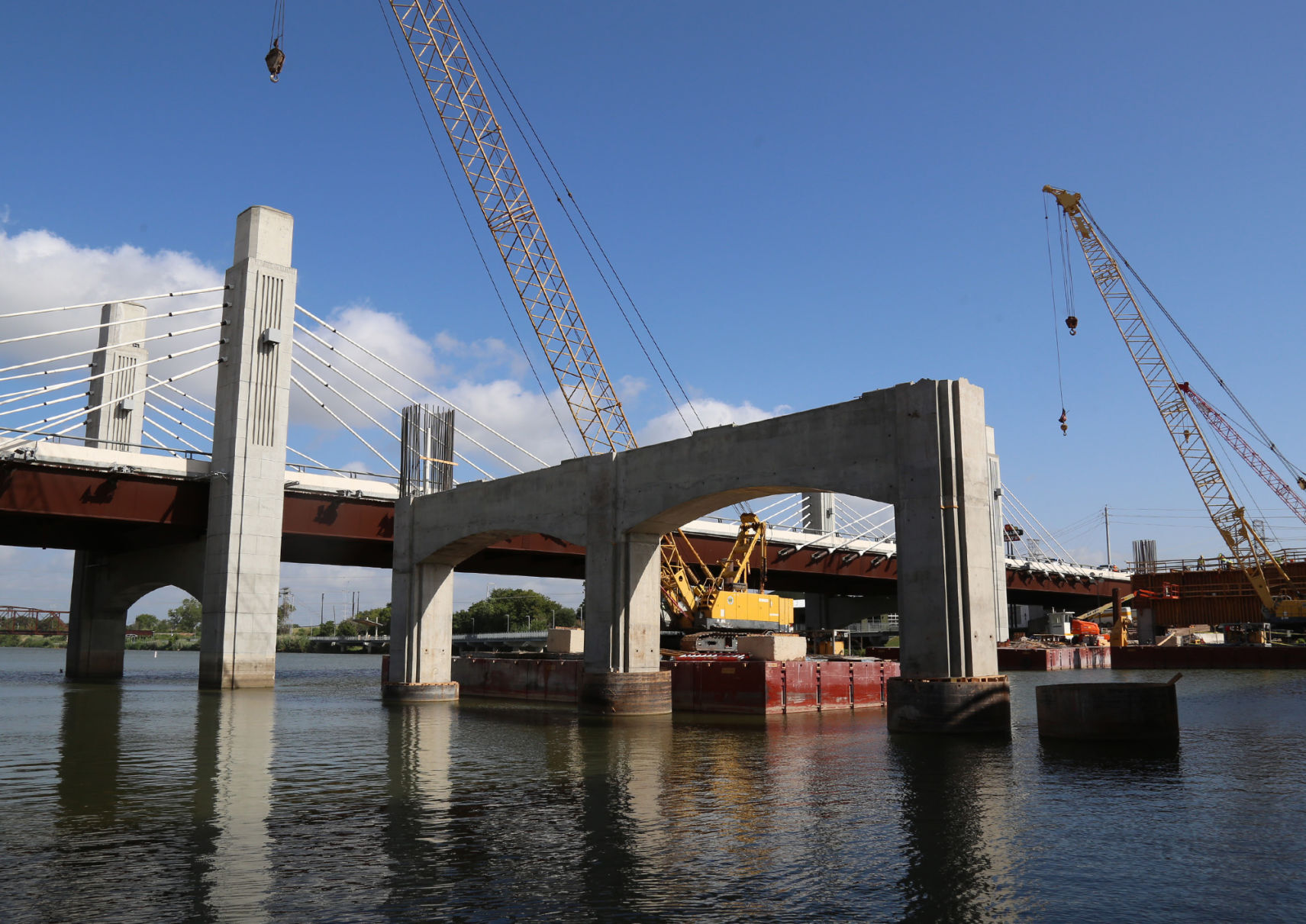

The new southbound Interstate 35 bridge over the Brazos River is scheduled to start carrying southbound traffic overnight Tuesday, March 9 into Wednesday. Northbound traffic will then shift to the new southbound lanes in the coming weeks, so work can proceed on the northbound side.
Interstate 35: March 2021

The new southbound Interstate 35 bridge over the Brazos River is scheduled to start carrying southbound traffic overnight Tuesday, March 9 into Wednesday. Northbound traffic will then shift to the new southbound lanes in the coming weeks, so work can proceed on the northbound side.
Interstate 35: March 2021

The new southbound Interstate 35 bridge over the Brazos River is scheduled to start carrying southbound traffic overnight Tuesday, March 9 into Wednesday. Northbound traffic will then shift to the new southbound lanes in the coming weeks, so work can proceed on the northbound side.
Interstate 35: October 2020

Massive support metal beams are installed on the southbound lanes of Interstate 35 at University Parks Drive as construction continues on the $341 project to rebuild the interstate through Waco. The southbound lanes are closed as new overpasses are being constructed all along the route, and when that work is finished in mid-2021, the northbound side will close.
Interstate 35: August 2020

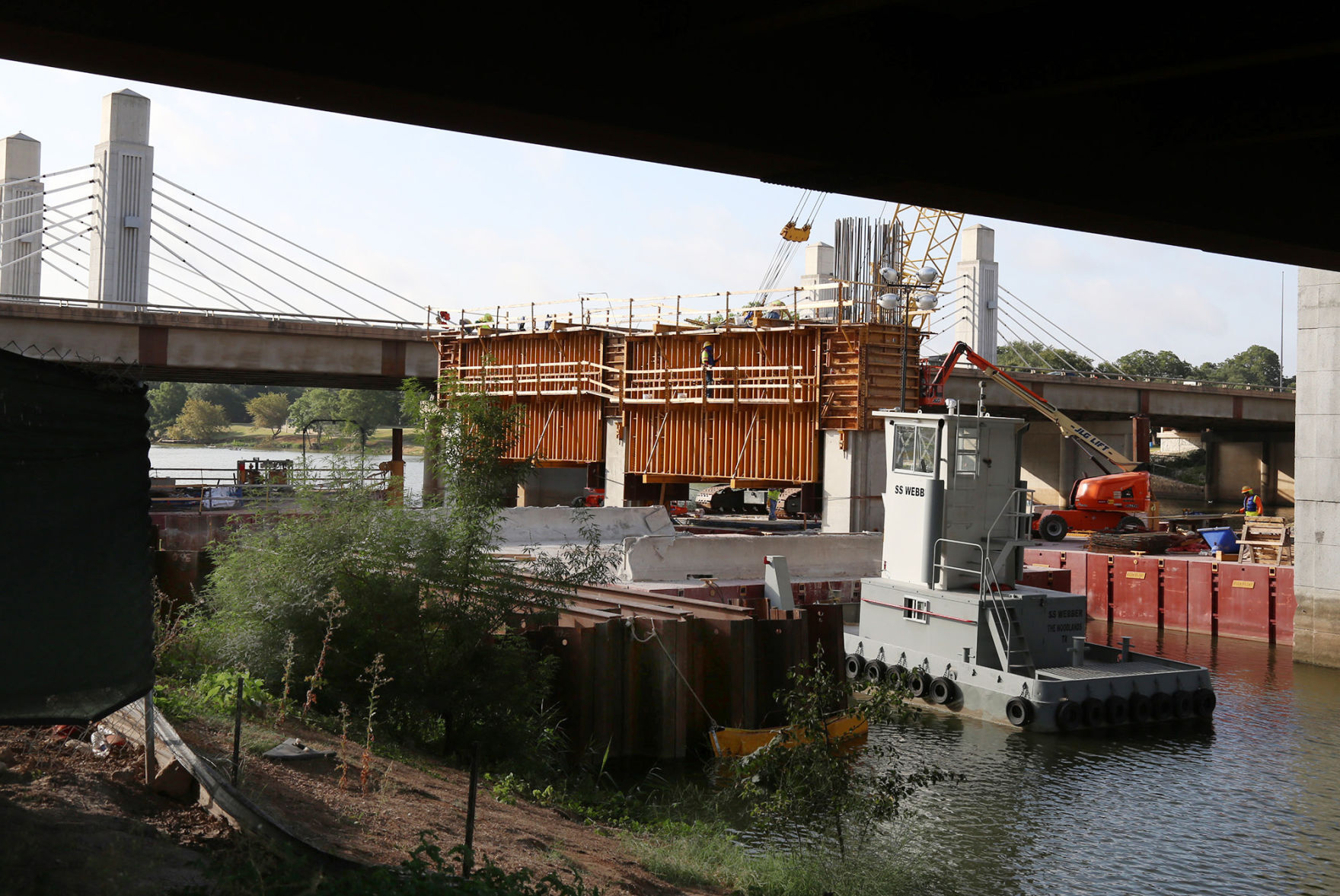

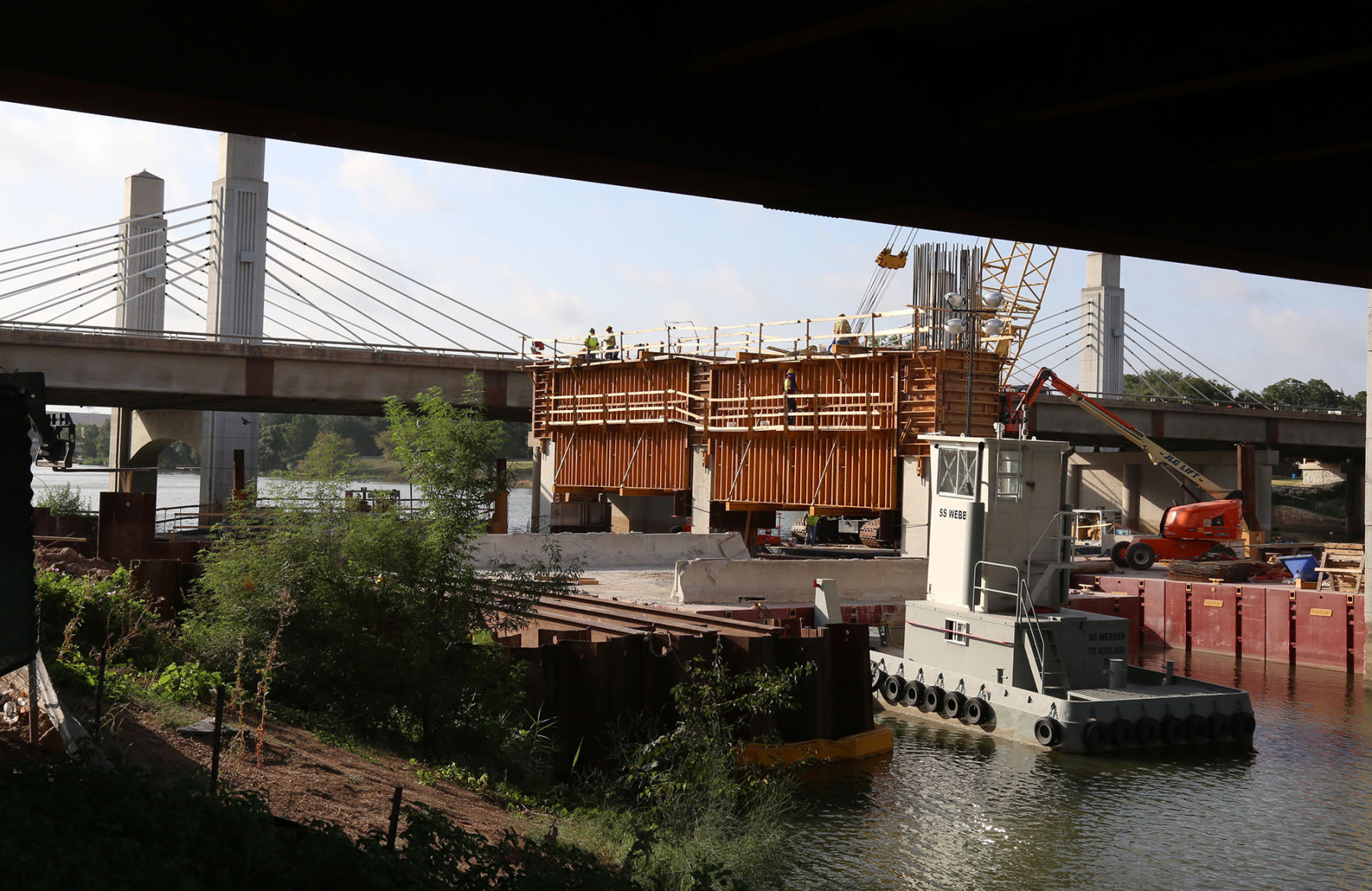

Work proceeds on the Brazos River bridge. The overall Interstate 35 project is on track for completion in 2023.
Interstate 35: August 2020

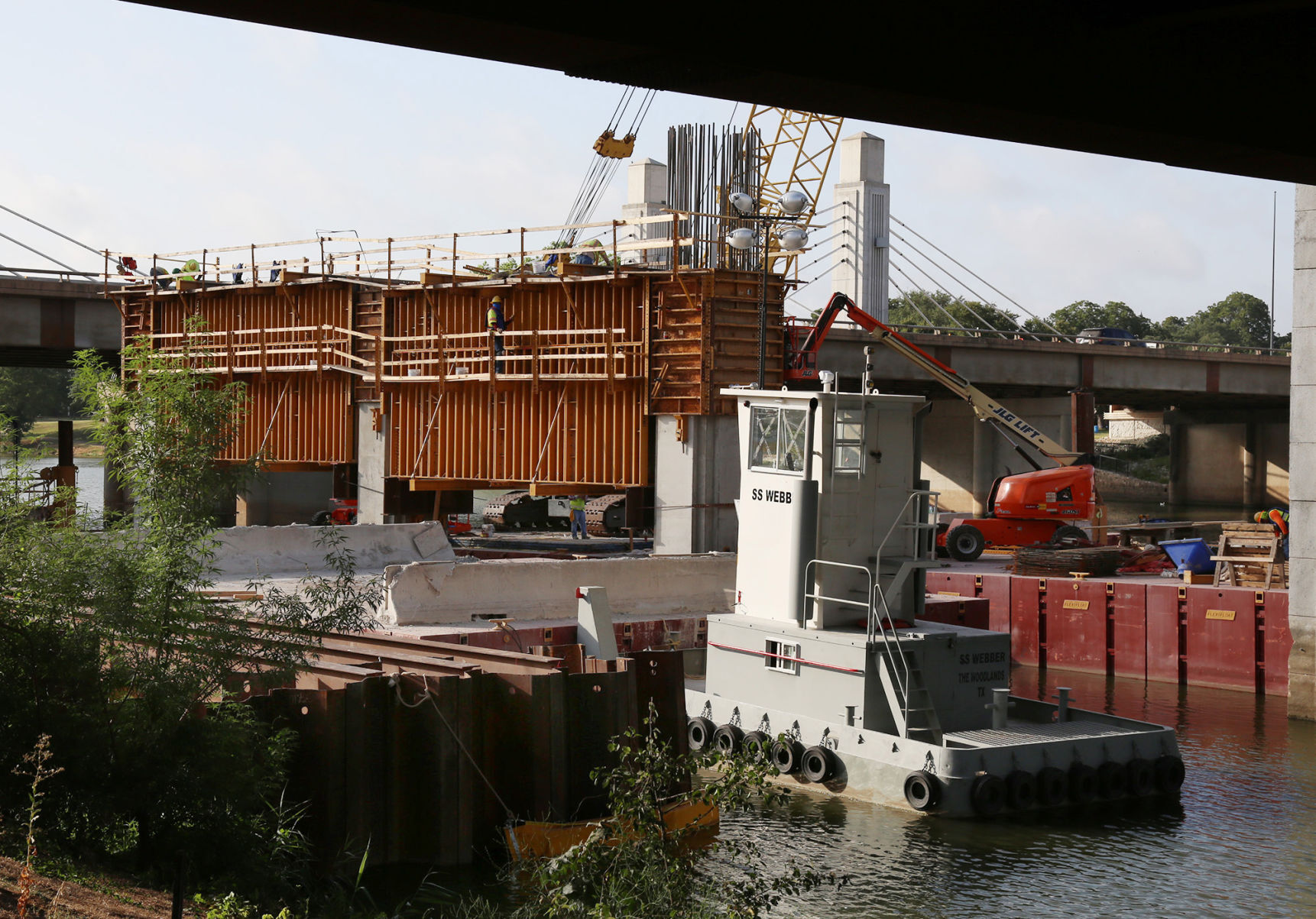

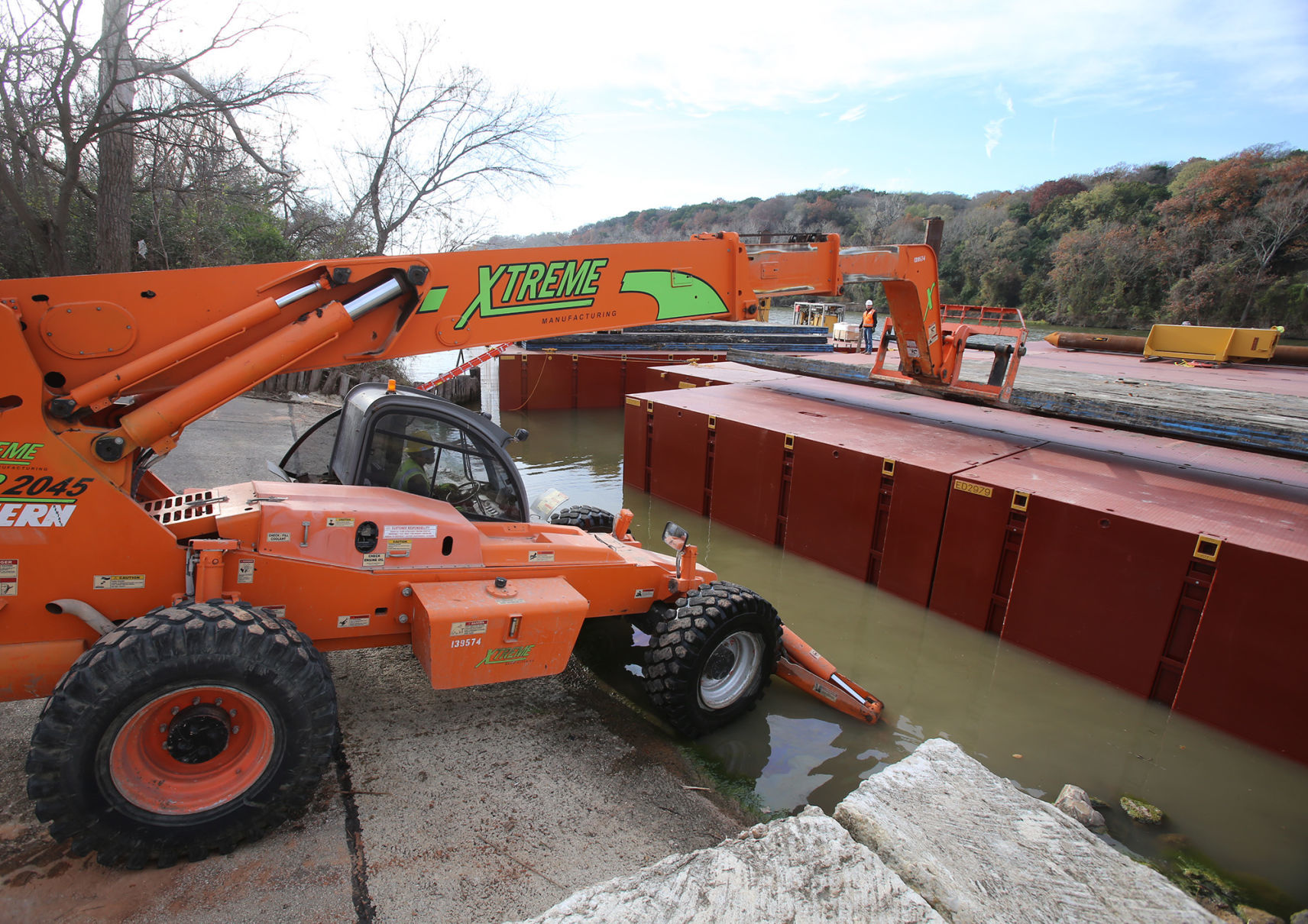

Working on barges in a river creates a whole host of construction challenges, according to TxDOT public information officer Jake Smith.
Interstate 35: August 2020

Beams and columns already placed in the river will support a new bridge. The northbound bridge is next.
Interstate 35: August 2020

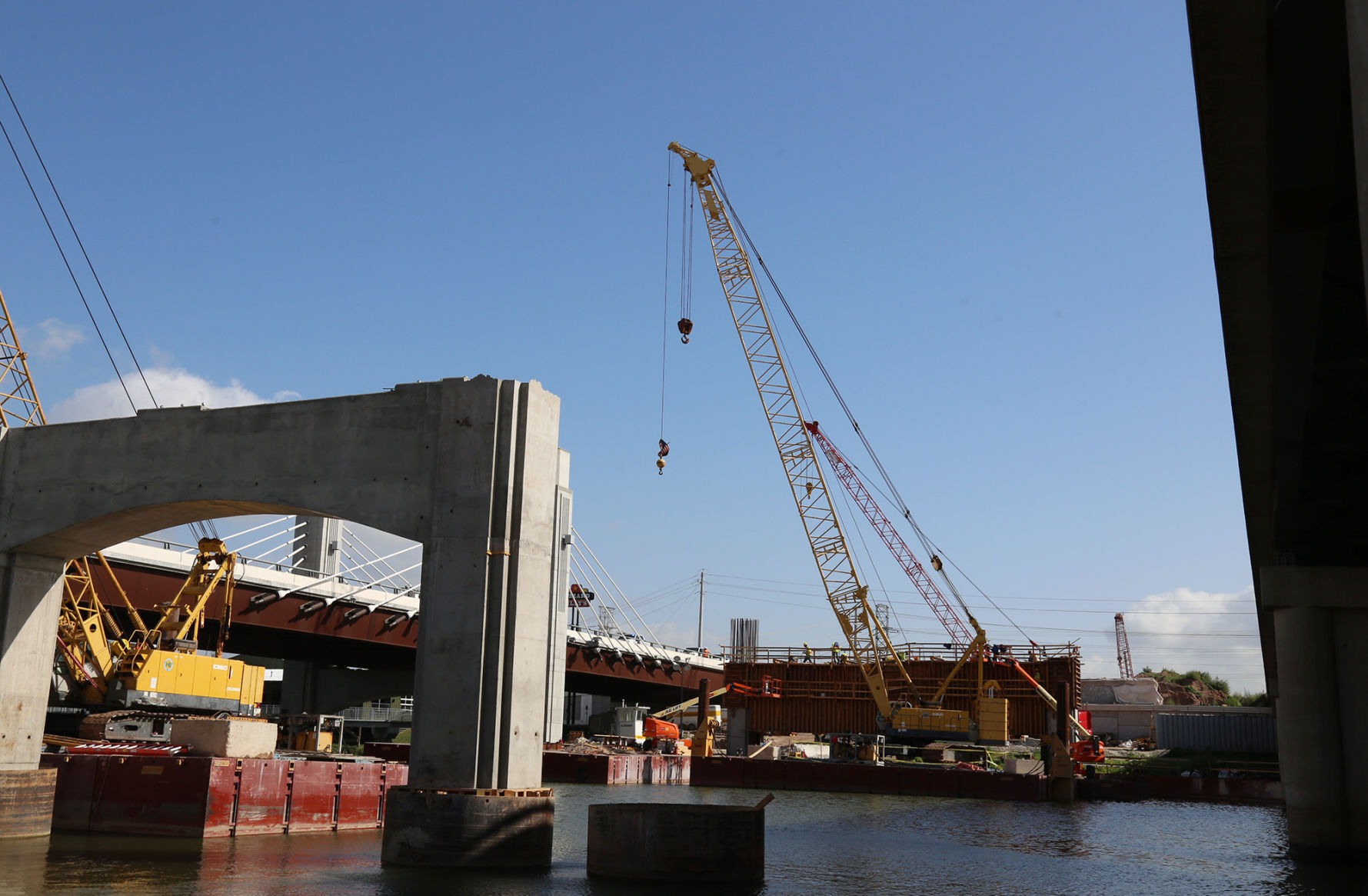

Cranes and barges aid in the demolition of old I-35 bridges and the construction of new, replacement ones.
Interstate 35: August 2020

Piers are being installed in the Brazos River for the southbound lane of Interstate 35.
Interstate 35: August 2020

All main-lane traffic has been shifted to the northbound roadbed as work proceeds on the southbound lanes at the Brazos River bridge.
Interstate 35: August 2020

Work continues on the Interstate 35 expansion, including a new southbound bridge that will span the Brazos River near McLane Stadium.
Interstate 35: August 2020

Decking work continues on the bridge over University Parks Drive.
Interstate 35: August 2020

Cranes and barges aid in the demolition of old I-35 bridges and the construction of new, replacement ones.
Interstate 35: August 2020

Beams and columns already placed in the river will support a new bridge. The northbound bridge is next.
Interstate 35: August 2020

The original southbound bridge was demolished in March 2020.
Interstate 35: August 2020

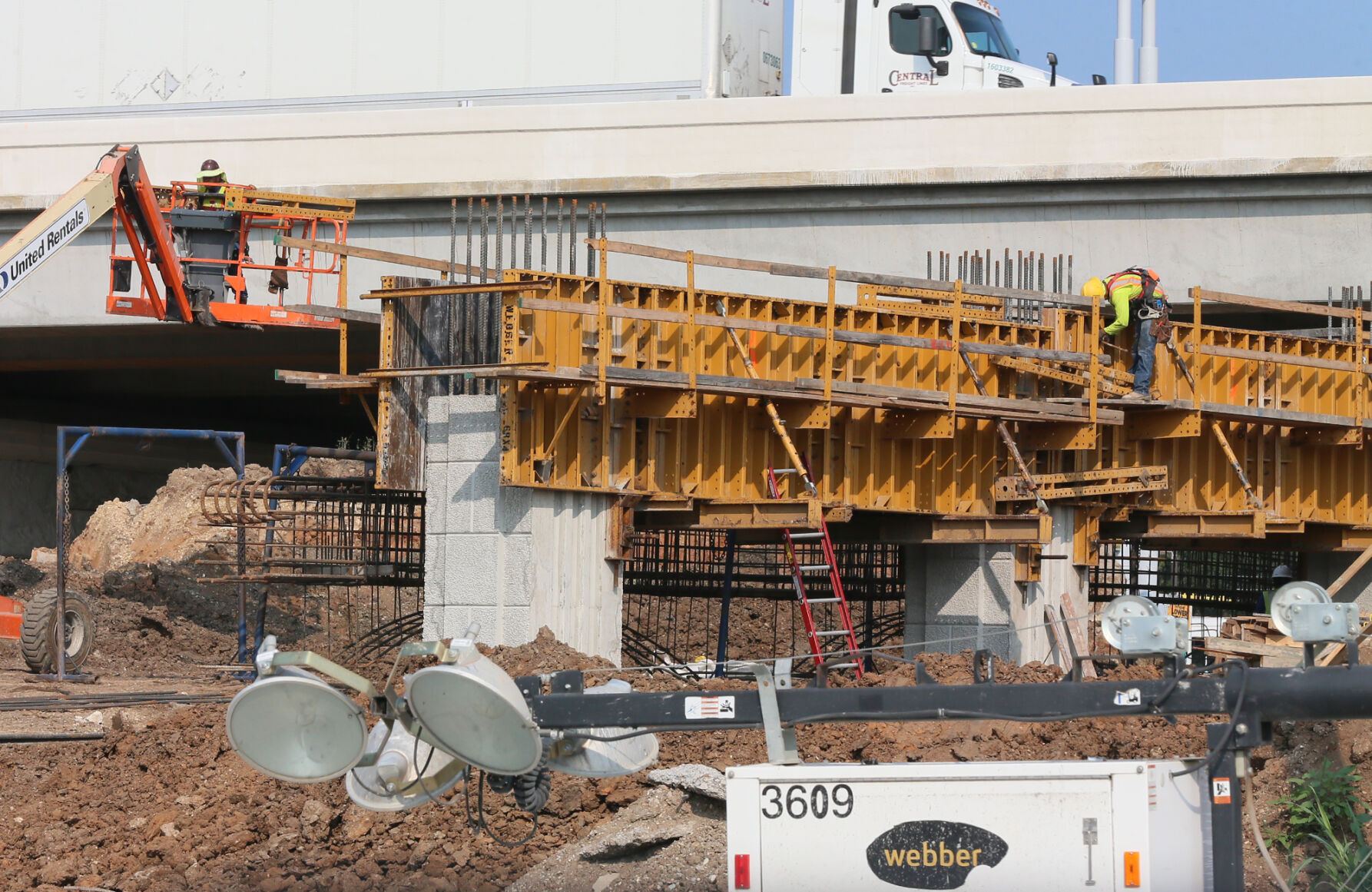

Work continues on the Interstate 35 bridge over Fourth and Fifth streets.
Interstate 35: August 2020

Decking work has begun on the bridge over University Parks Drive.
Interstate 35: June 2020

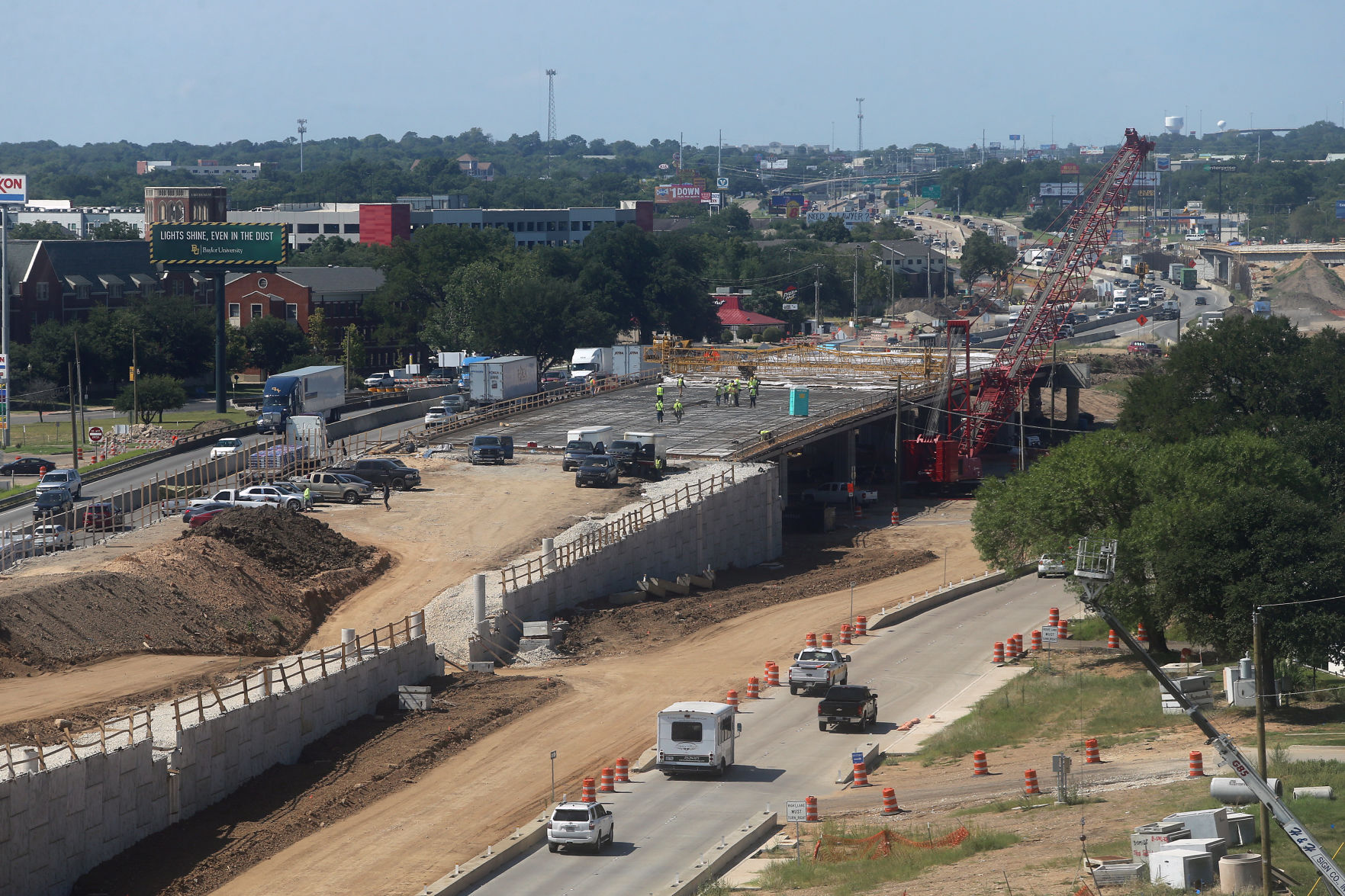

The downtown segment of the Interstate 35 reconstruction project through Waco is beginning to take shape. Crews finished installing beams (above) in mid-June on the 11th-12th Street overpass and will follow suit with the Fourth-Fifth Street bridge next week. As of June 10, $150 million had been spent on the $341 million project, state officials said.
Interstate 35: June 2020

The downtown segment of the Interstate 35 reconstruction project through Waco is beginning to take shape. Crews finished installing beams in mid-June on the 11th-12th Street overpass and will follow suit with the Fourth-Fifth Street bridge next week. As of June 10, $150 million had been spent on the $341 million project, state officials said.
Interstate 35: June 2020

Piers are in place for the new Interstate 35 bridge at Fourth-Fifth streets in mid-June 2020.
Interstate 35: June 2020

The downtown segment of the Interstate 35 reconstruction project through Waco is beginning to take shape. Crews finished installing beams in mid-June on the 11th-12th Street overpass and will follow suit with the Fourth-Fifth Street bridge next week. As of June 10, $150 million had been spent on the $341 million project, state officials said.
Interstate 35: June 2020

The downtown segment of the Interstate 35 reconstruction project through Waco is beginning to take shape. Crews finished installing beams in mid-June on the 11th-12th Street overpass and will follow suit with the Fourth-Fifth Street bridge next week. As of June 10, $150 million had been spent on the $341 million project, state officials said.
Interstate 35: June 2020

Crews install supports for the new 11th-12th Street bridge and remove old supports between there and Fourth-Fifth streets.
Interstate 35: June 2020

A view of Interstate 35 construction, looking south from the Forrest Street bridge.
Interstate 35: June 2020

A view of Interstate 35 construction looking south from the Forrest Street bridge.
Interstate 35: June 2020

A view of construction on Interstate 35, looking north from the Forrest Street bridge.
Interstate 35: June 2020

A view of Interstate 35 construction looking south from the Forrest Street bridge.
Interstate 35: June 2020

A view of Interstate 35 construction looking south from Forrest Street.
Interstate 35: June 2020

Construction progresses on Interstate 35, seen here looking south from the Forrest Street Bridge.
Interstate 35: June 2020

A view of I-35 construction looking north from the Forrest Street bridge.
Interstate 35: June 2020

A woman walks on Dutton Avenue near Baylor University where a sidewalk message from TxDOT warns pedestrians and cyclists about construction.
Interstate 35: June 2020

A message for pedestrians and cyclists from TxDOT on a sidewalk on Dutton Avenue near Baylor University directs them to alternative routes during I-35 construction.
Interstate 35: March 2020

Interstate construction, seen looking north from near Martin Luther King Jr. Boulevard, is forging ahead as an essential service during the city's shelter-in-place order.
Interstate 35: March 2020

The southbound lane of Interstate 35 near Bellmead in late March 2020.
Interstate 35: March 2020

Interstate construction, seen looking south from near Forrest Street, is forging ahead as an essential service during the city’s shelter-in-place order.
Interstate 35: March 2020

Work continues on the expansion of Interstate 35 despite the coronavirus pandemic. Workers are dismantling I-35 overpass bridge at Business 77.
Interstate 35: March 2020

Work continues on the expansion of Interstate 35 despite the coronavirus pandemic. Workers are dismantling I-35 overpass bridge at Business 77.
Interstate 35: March 2020

Work continues on the expansion of Interstate 35 despite the coronavirus pandemic. Workers are dismantling I-35 overpass bridge at Business 77.
Interstate 35: March 2020

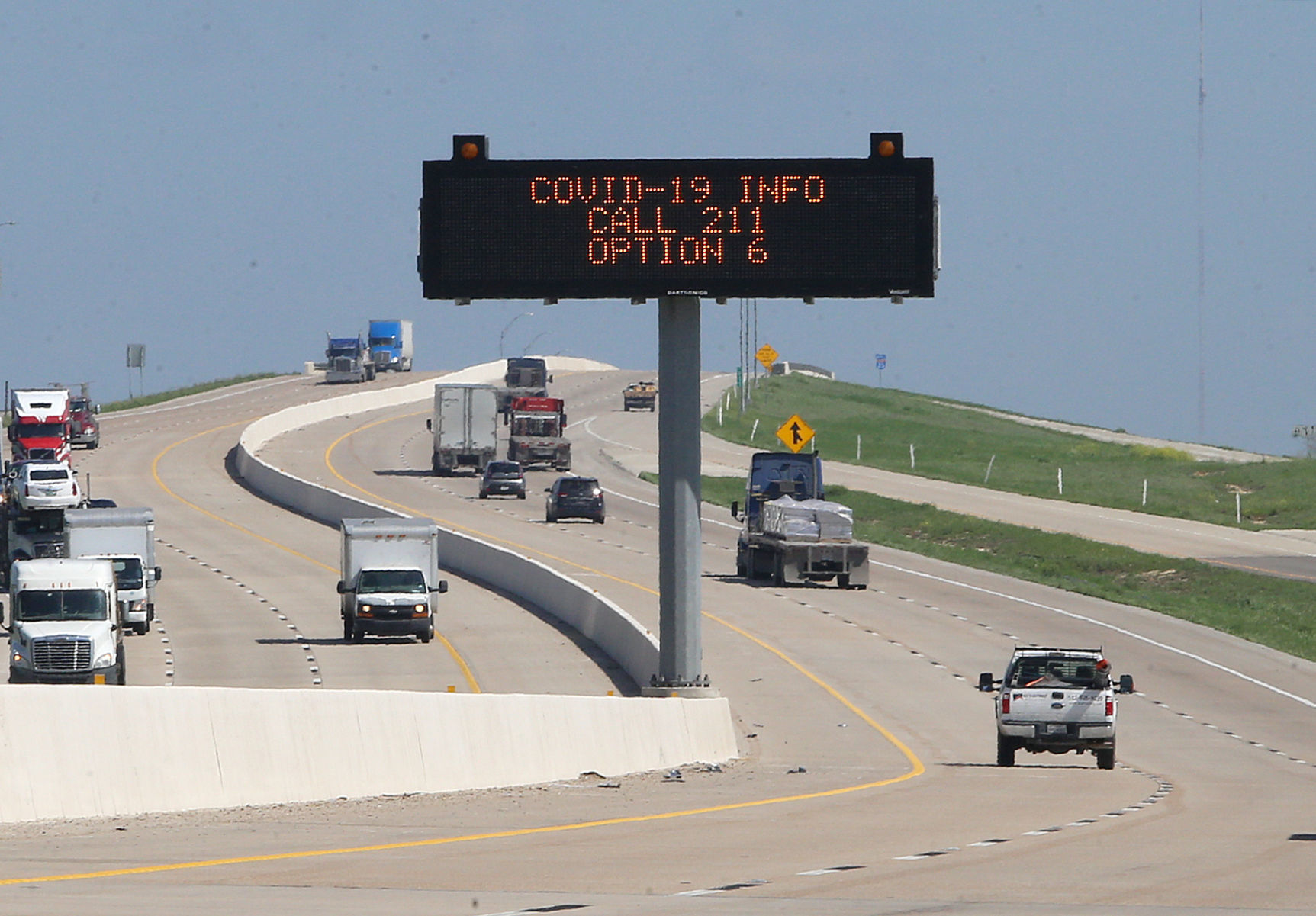

A TxDOT message board regarding the coronavirus outbreak informs drivers along Interstate-35.
Interstate 35: March 2020

Workers prepare new bridge supports at Fifth Street and Interstate 35.
Interstate 35: March 2020

Pillars are going up as construction continue at Fifth Street and Interstate 35.
Interstate 35: March 2020

Pillars are going up as construction continue at Fifth Street and Interstate 35.
Interstate 35: March 2020

TxDOT initially altered the design the the highway, raising the main lanes by several feet, to avoid floodwaters during a 50-year flood event.
Interstate 35: March 2020

Work continues on the expansion of Interstate 35 near Fifth Street.
Interstate 35: January 2020

The southbound Interstate 35 bridge at Martin Luther King Jr. Boulevard was removed in early January.
Interstate 35: January 2020

The southbound Interstate 35 overpass at Martin Luther King Jr. Boulevard was removed in early January.
Interstate 35: January 2020

The southbound Interstate 35 bridge at Martin Luther King Jr. Boulevard was removed in early January.

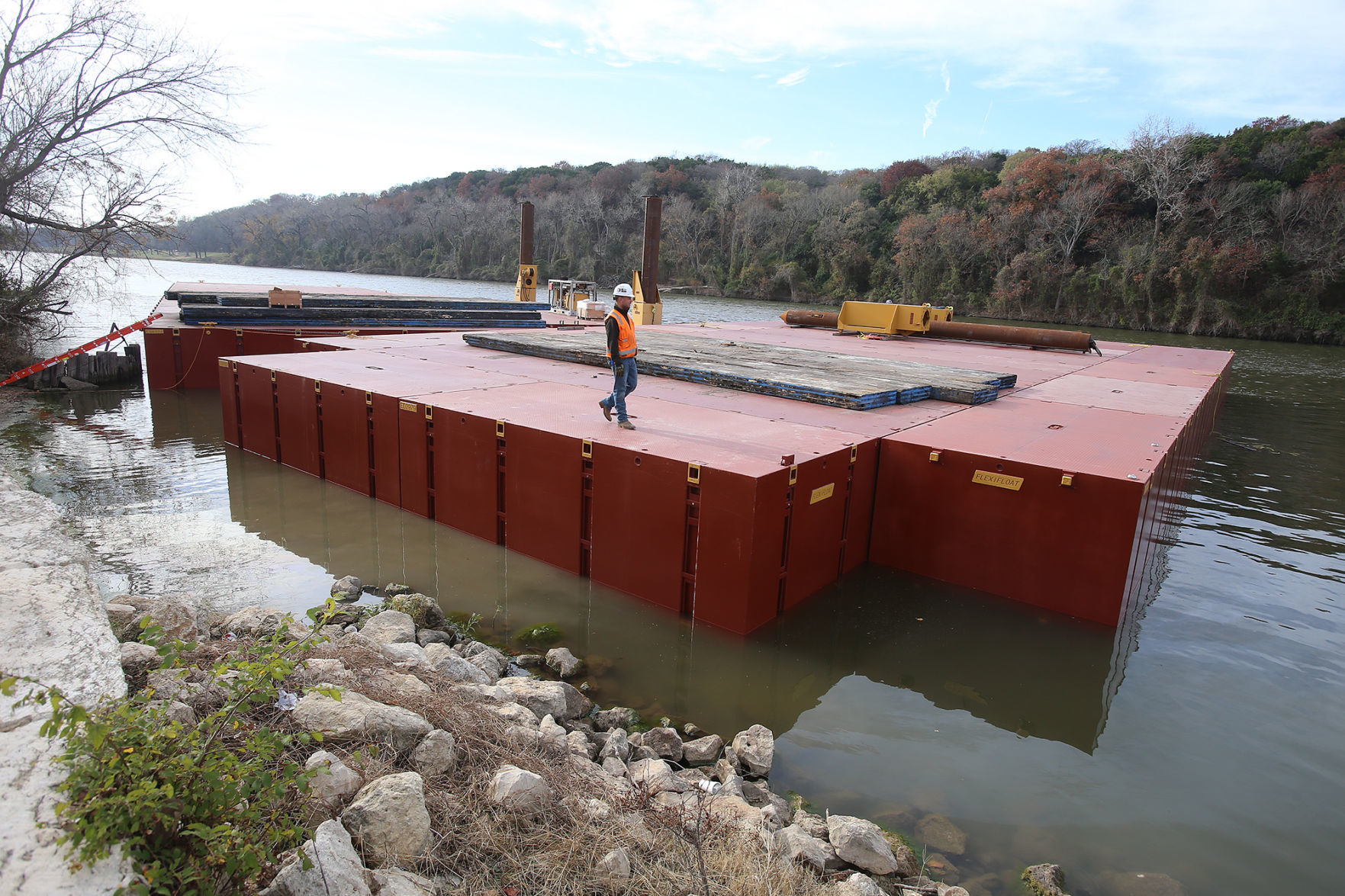

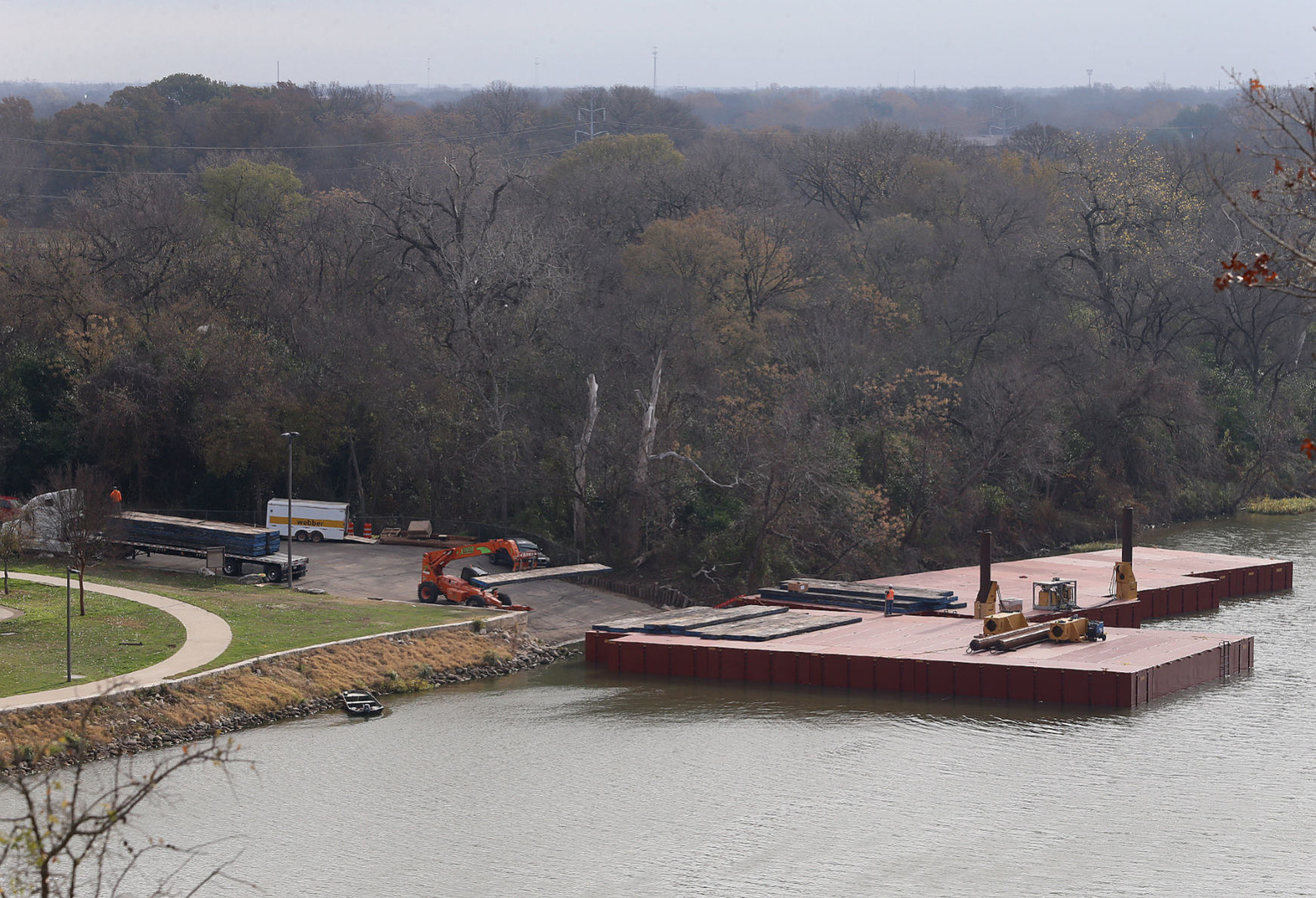

Interstate 35: Barges

A barge is loaded with equipment and materials at Brazos East Park in preparation for work on the Interstate 35 bridges crossing the Brazos River. The main-lane bridges will be removed and replaced with wider and higher bridges that will give I-35 travelers a view of the river through Waco.
Interstate 35: Barges

A barge is loaded with equipment and materials at Brazos East Park in preparation for work on the Interstate 35 bridge over the Brazos River. Crews will start next week by removing lead paint from the bridge railings, then start early next year on demolition of the southbound bridge.
Interstate 35: Barges

A barge is assembled and loaded Thursday at Brazos East Park in preparation for work on the Interstate 35 bridges over the Brazos River. Crews will start next week by removing lead paint from the bridge railings, then start early next year on demolition of the southbound bridge.
Interstate 35: Barges

An aerial view looking north up Interstate 35 shows the crossing at the Brazos River. The middle main lanes will be removed and replaced with bridges carrying a total of eight lanes.
Interstate 35: November 2019

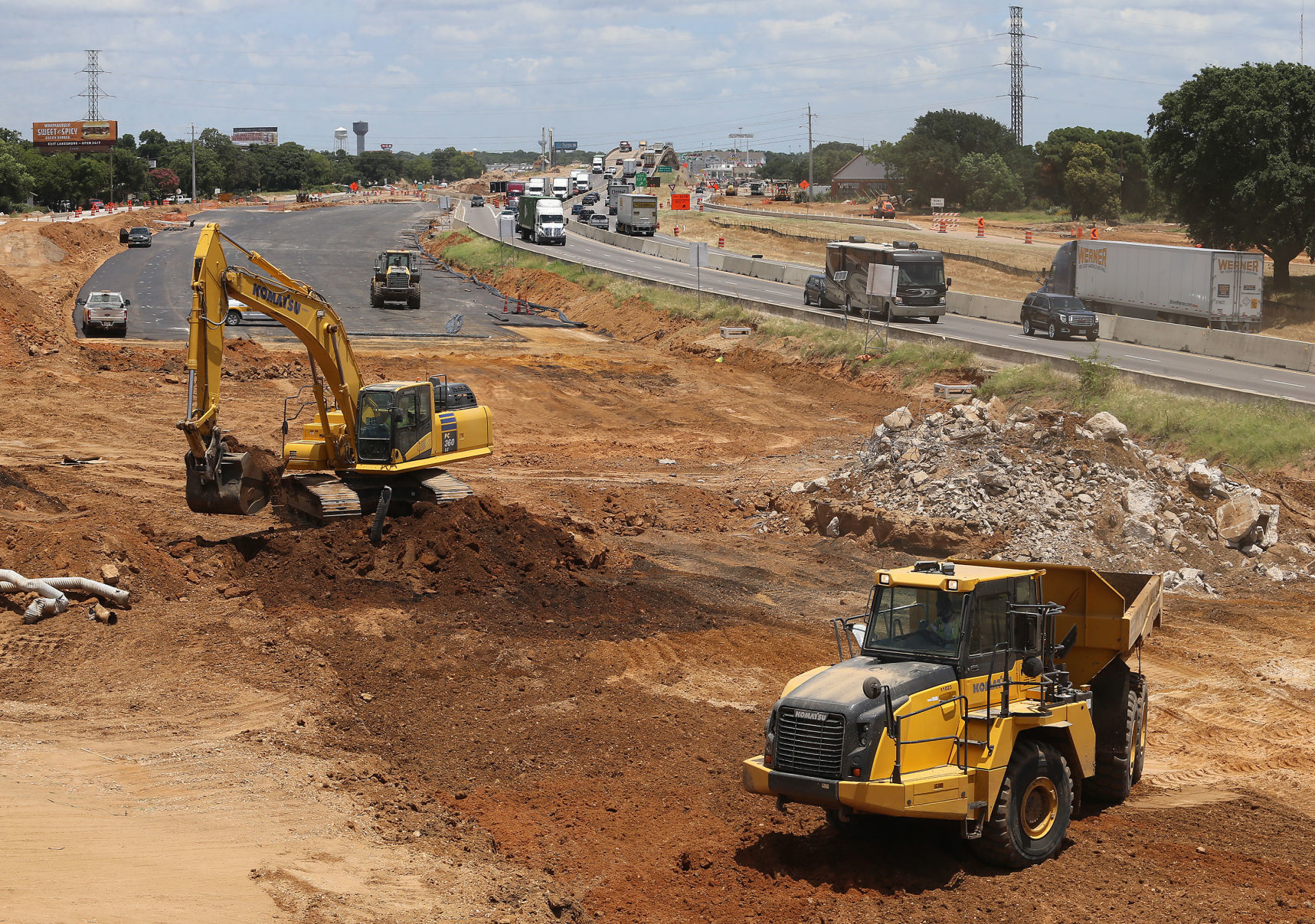

Webber LLC crews have been building new southbound frontage roads between University Parks Drive and Fourth Street in downtown Waco, resulting in long lines along the existing frontage roads.
Interstate 35: November 2019

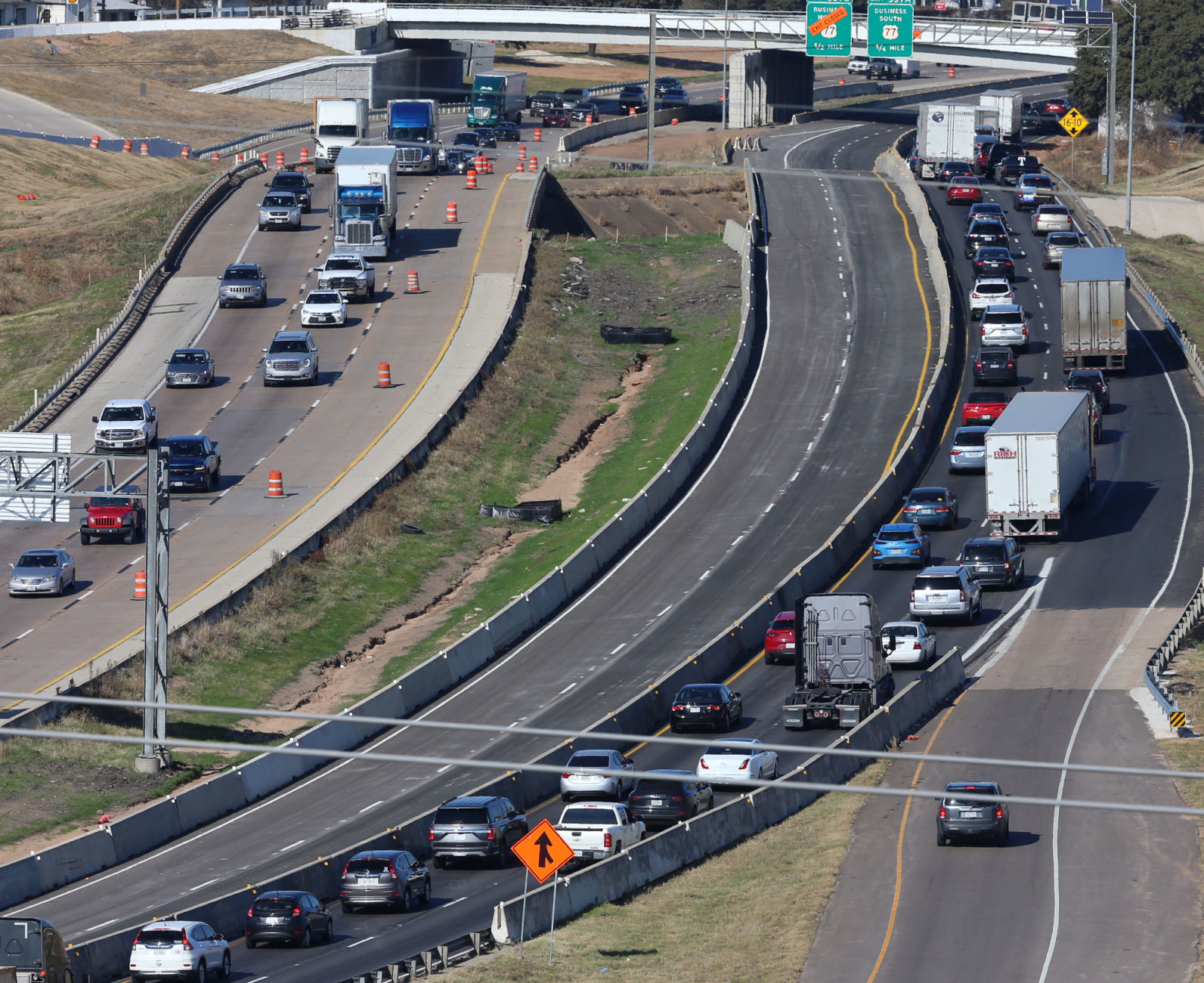

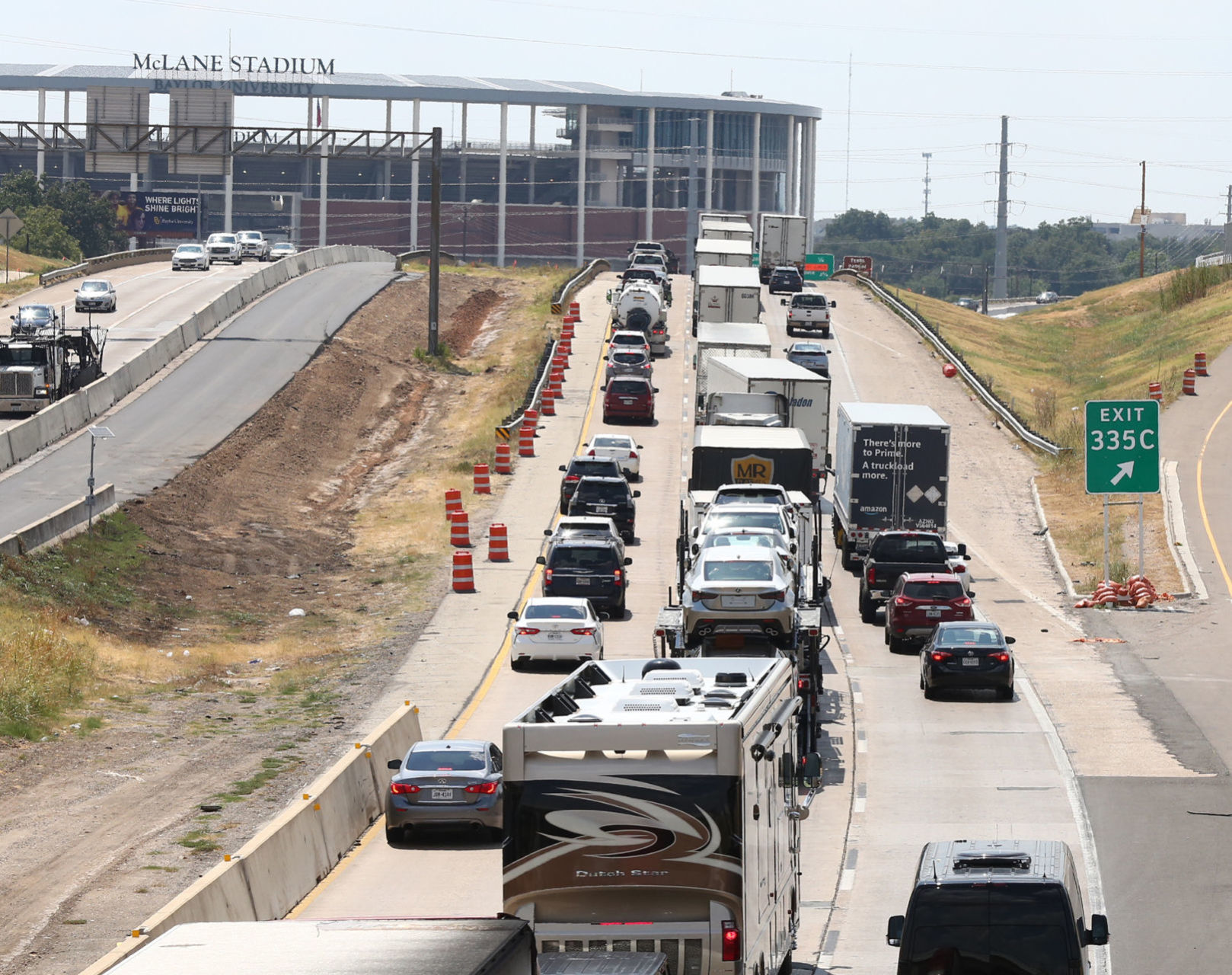

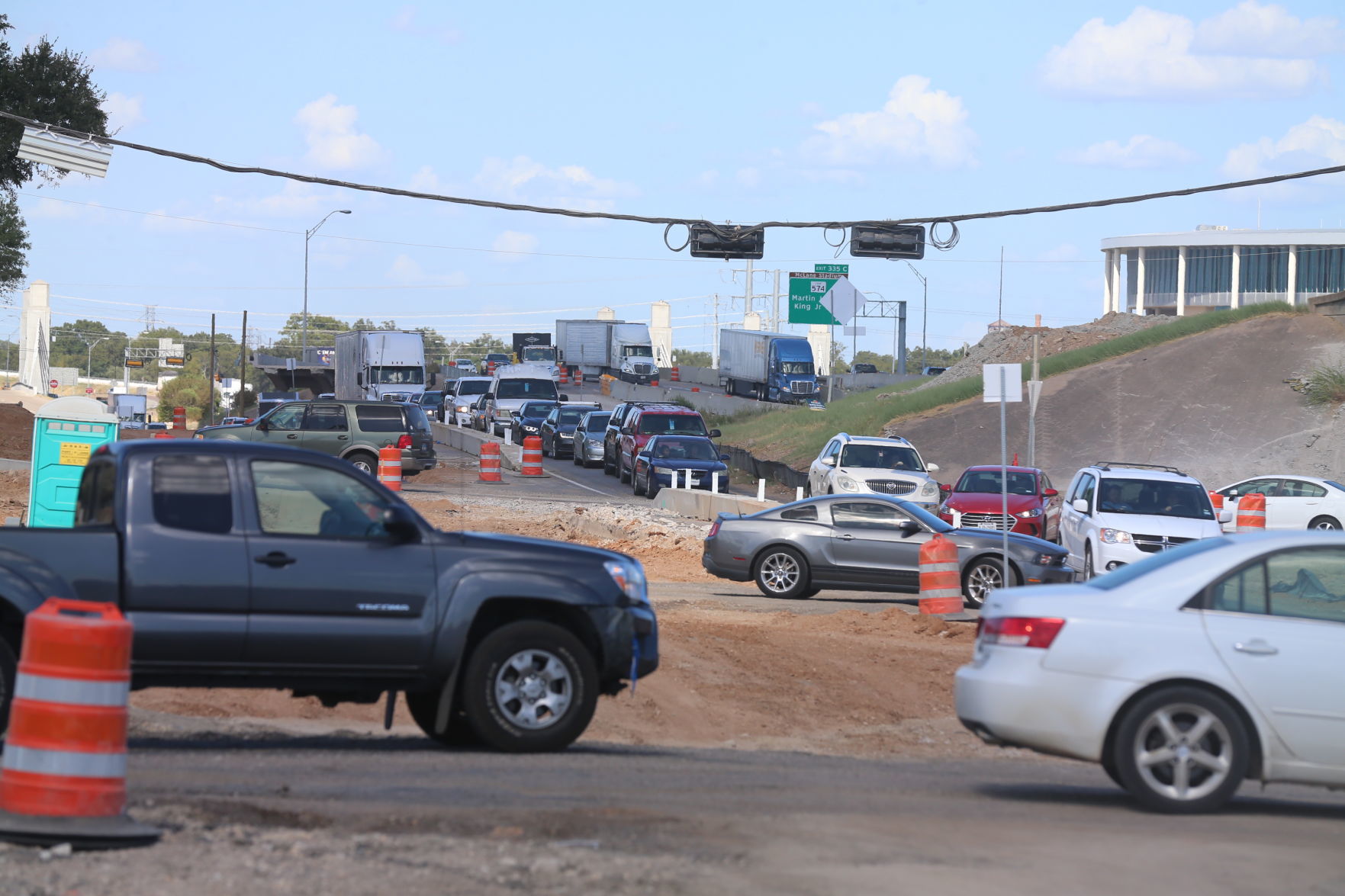

Northbound I-35 near Loop 340 in Bellmead remains one of the most congested areas in the 6-mile local construction zone.
Interstate 35: November 2019

A number of exits and on-ramps along Interstate 35, including this one in Bellmead, are closed, leaving local drivers scrambling to gain access to the roadway.
Interstate 35: November 2019

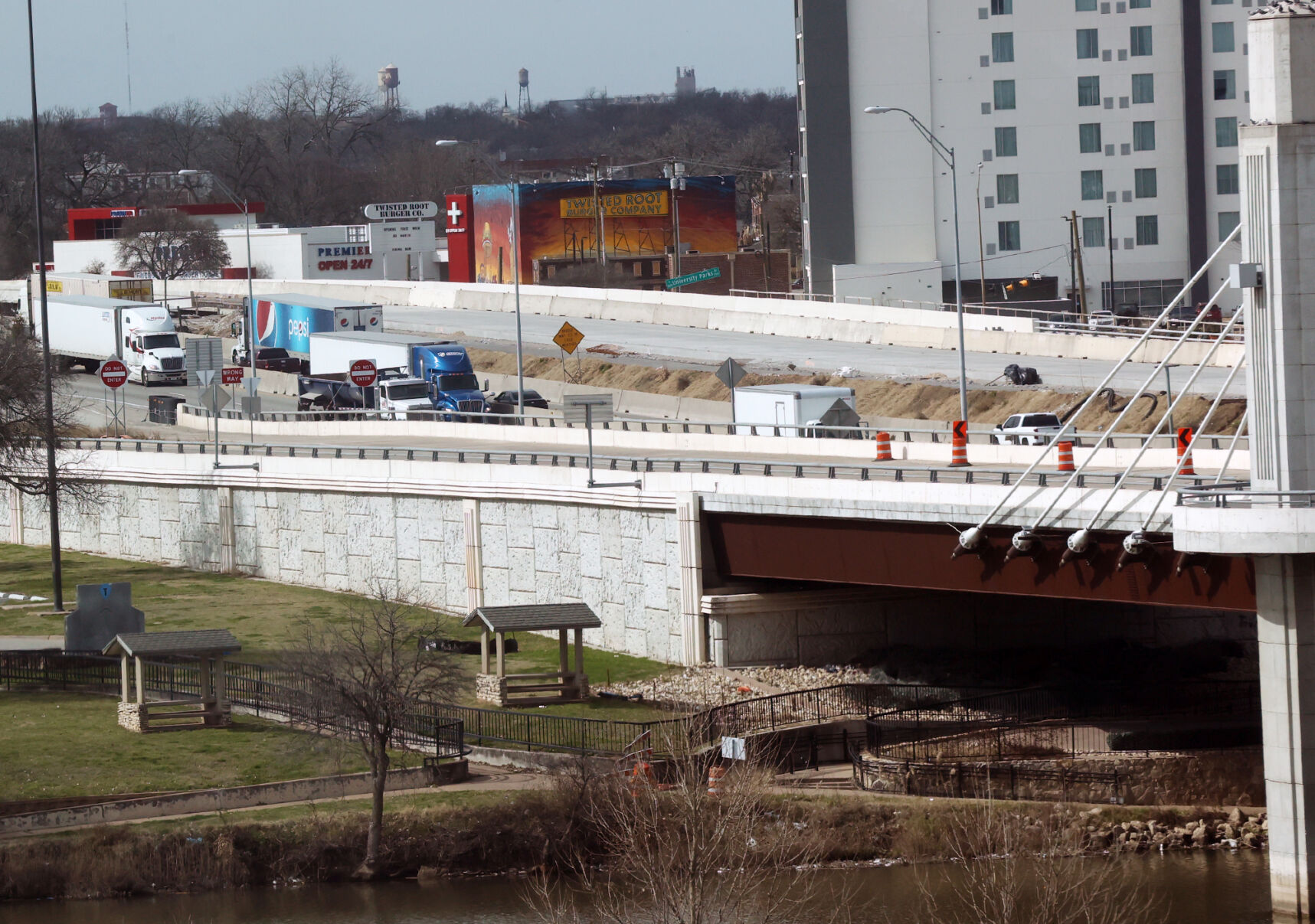

Traffic flows in the southbound lane of Interstate 35 south of Bellmead.
Interstate 35: November 2019

A bike rider pedals his way down the access road next to the northbound lane of Interstate 35 in Bellmead.
Interstate 35: November 2019

Traffic slows at the Loop 340 exit ramp on southbound Interstate 35.
Interstate 35: November 2019

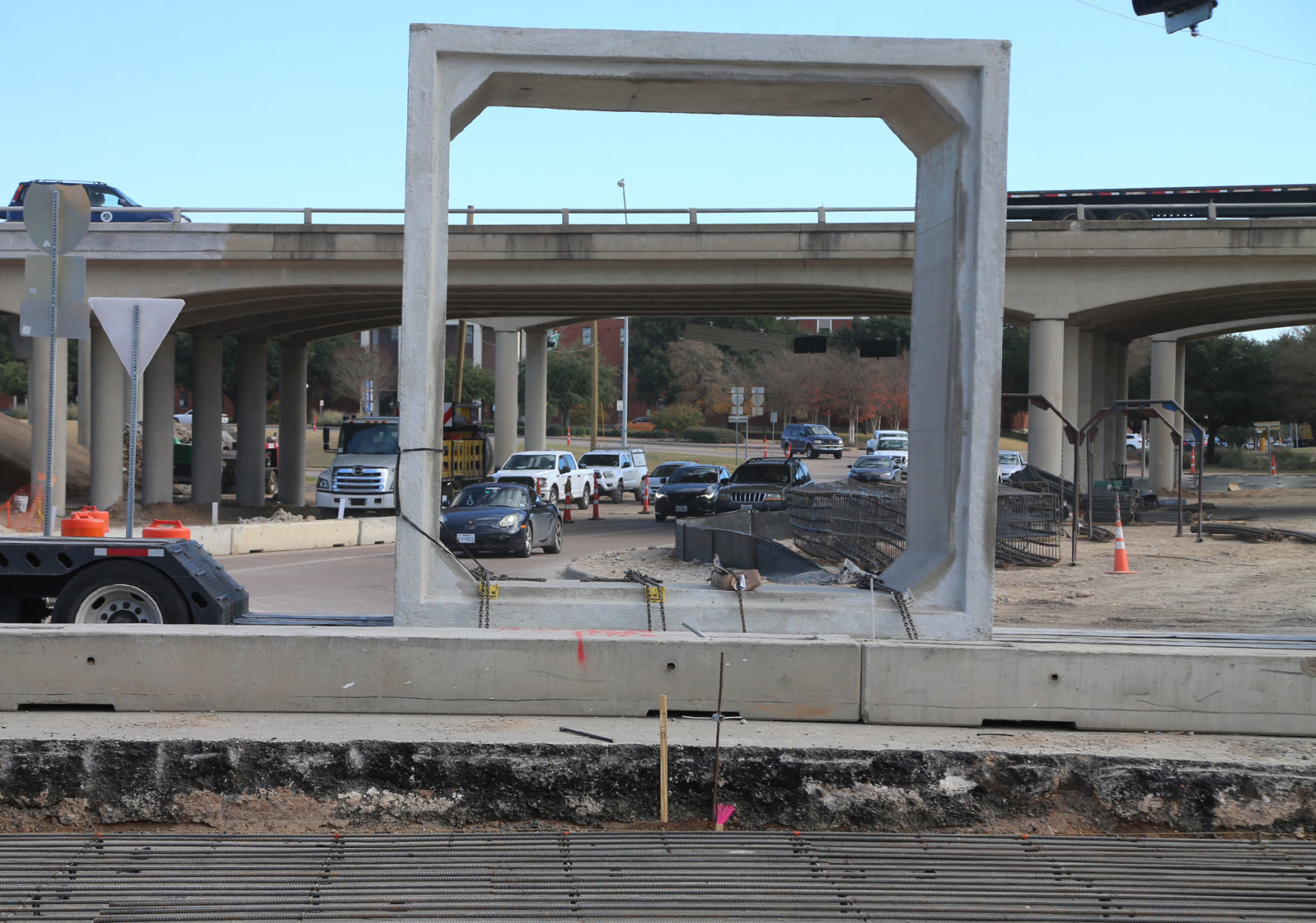

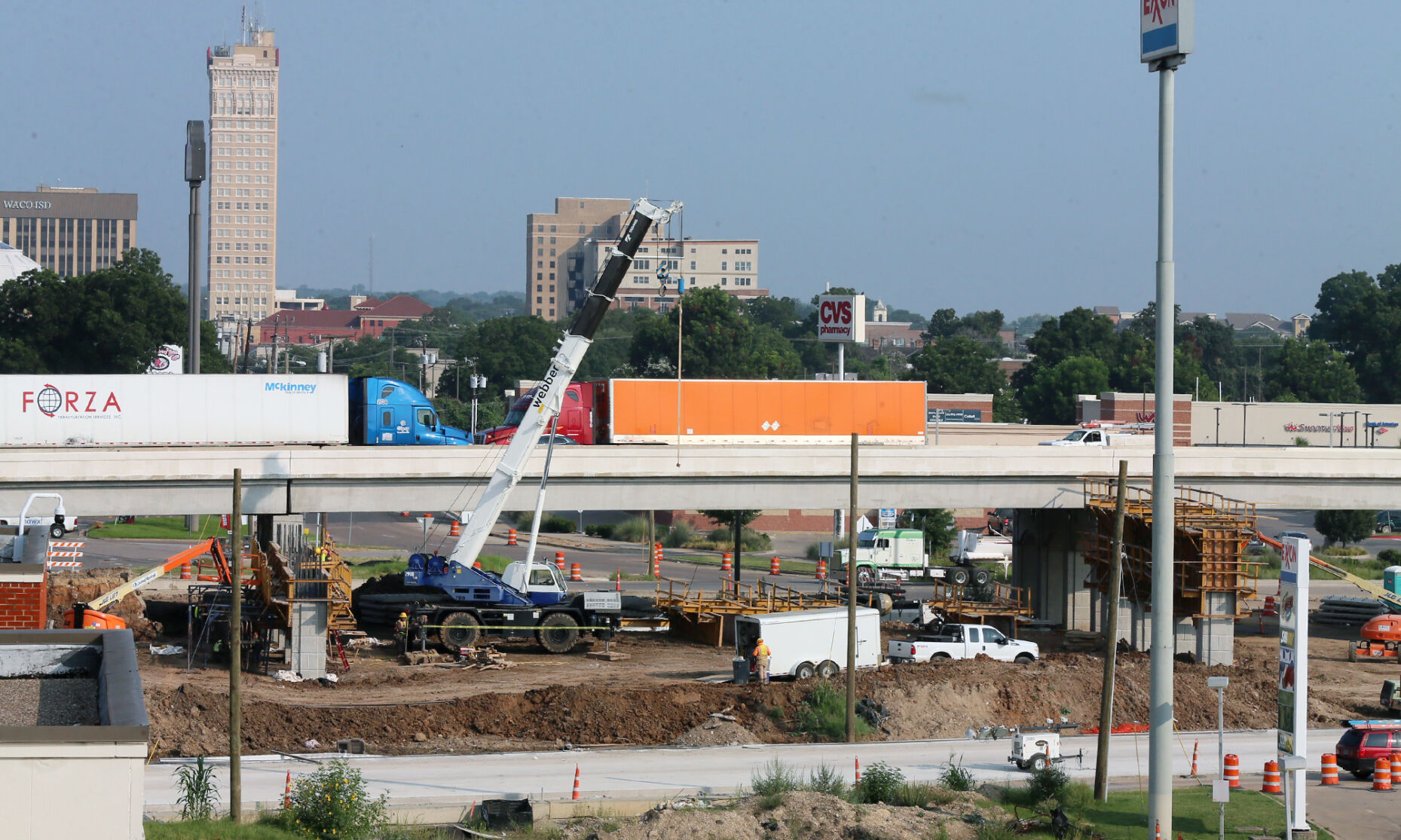

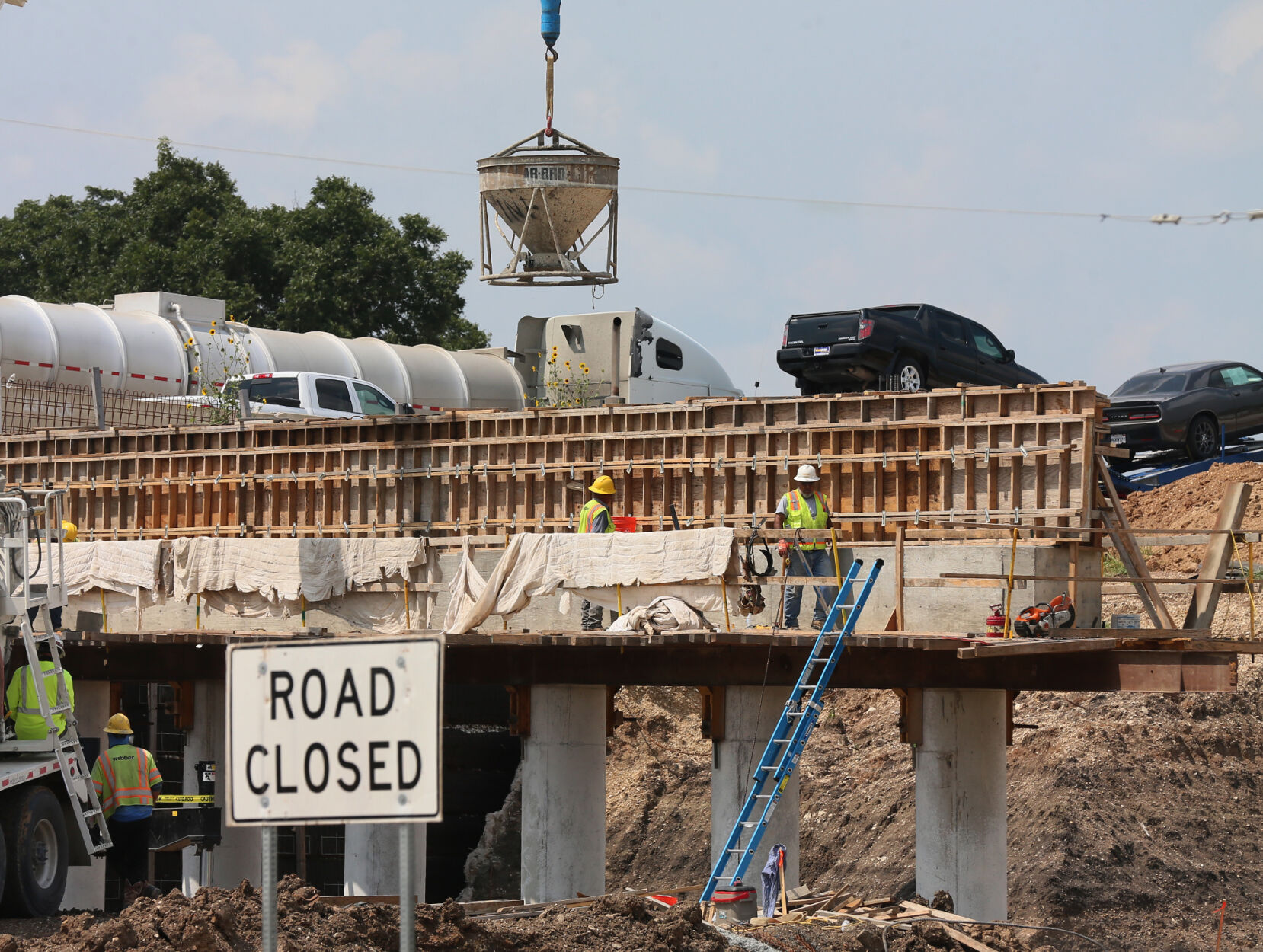

A piece of a box culvert is transported on a flatbed trailer past Fourth Street on the southbound Interstate 35 frontage road. The blocks will form drainage tunnels near 11th Street that will allow Waco Creek to pass under the interstate.
Interstate 35: November 2019

Access road along southbound lane of Interstate 35 backed up in-between University Parks drive and Fourth Street.
Interstate 35: November 2019

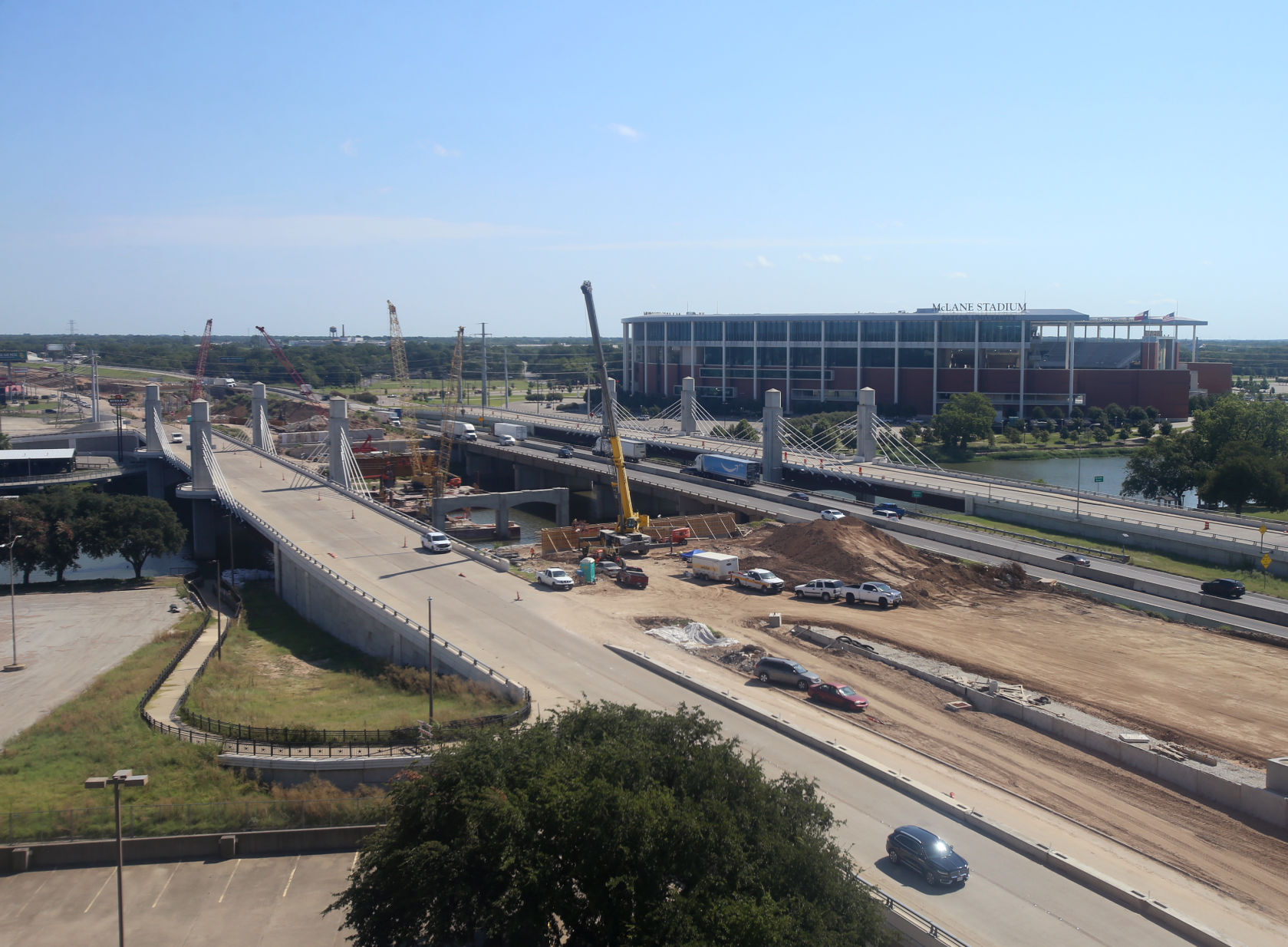

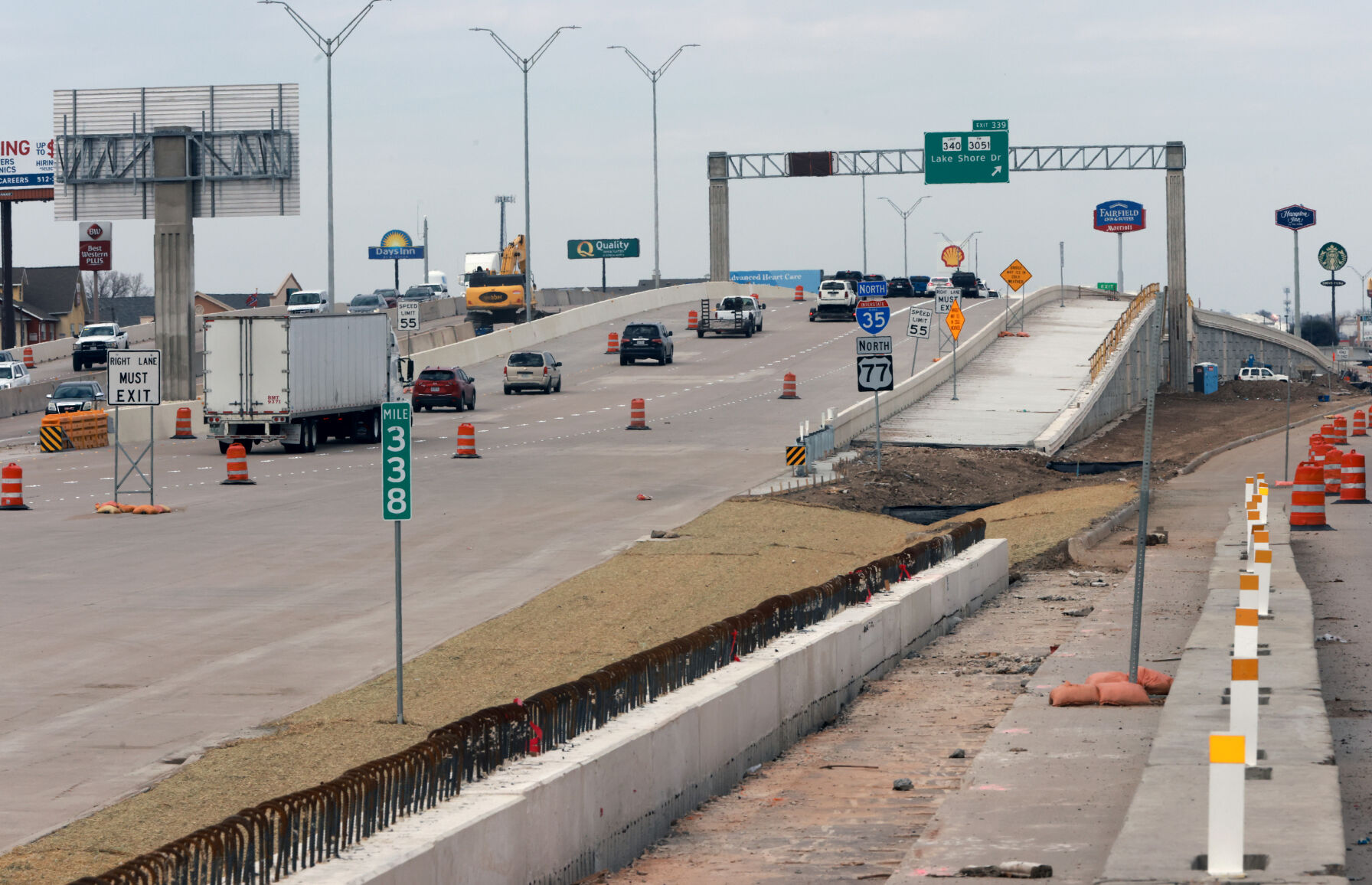

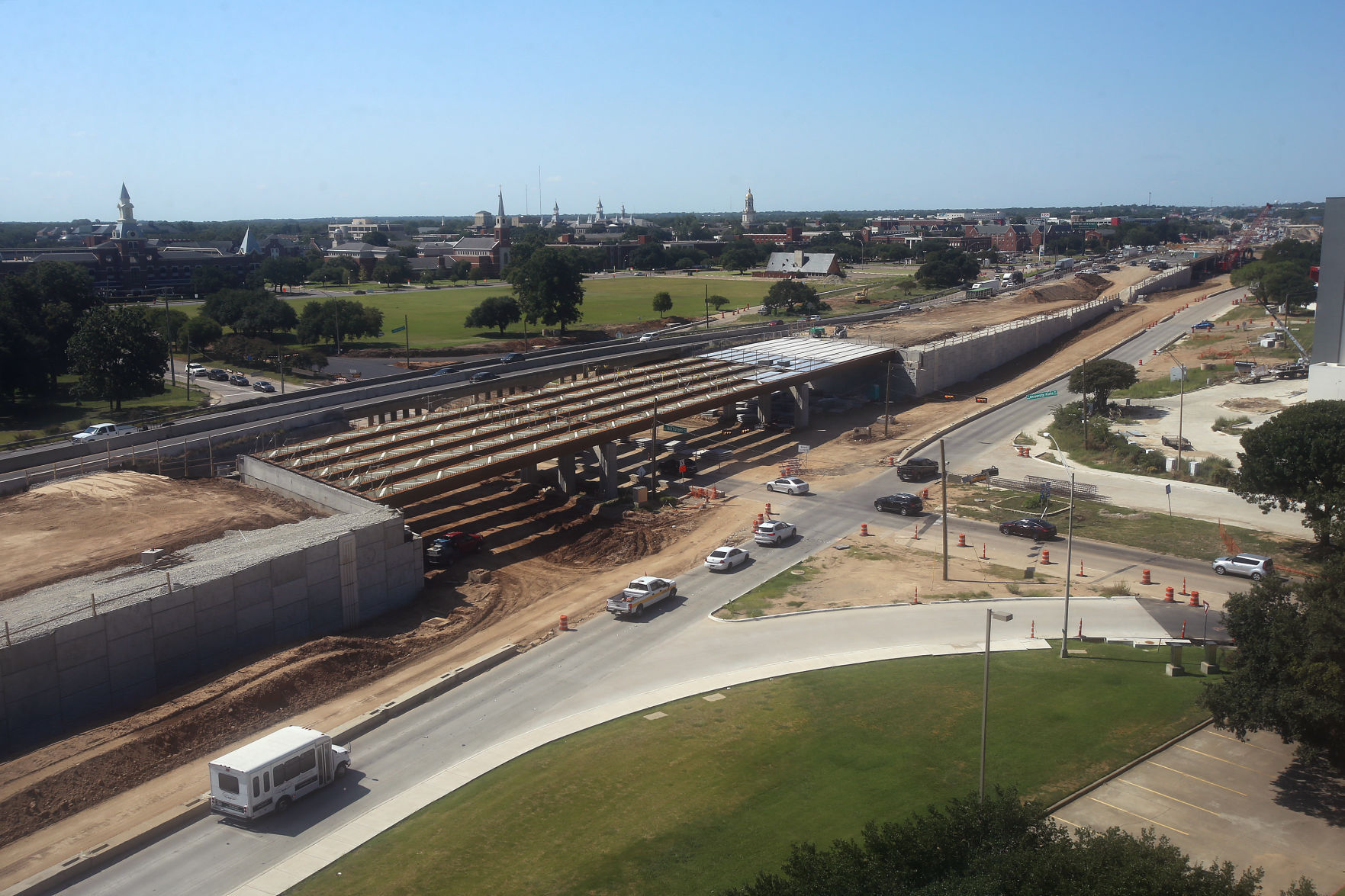

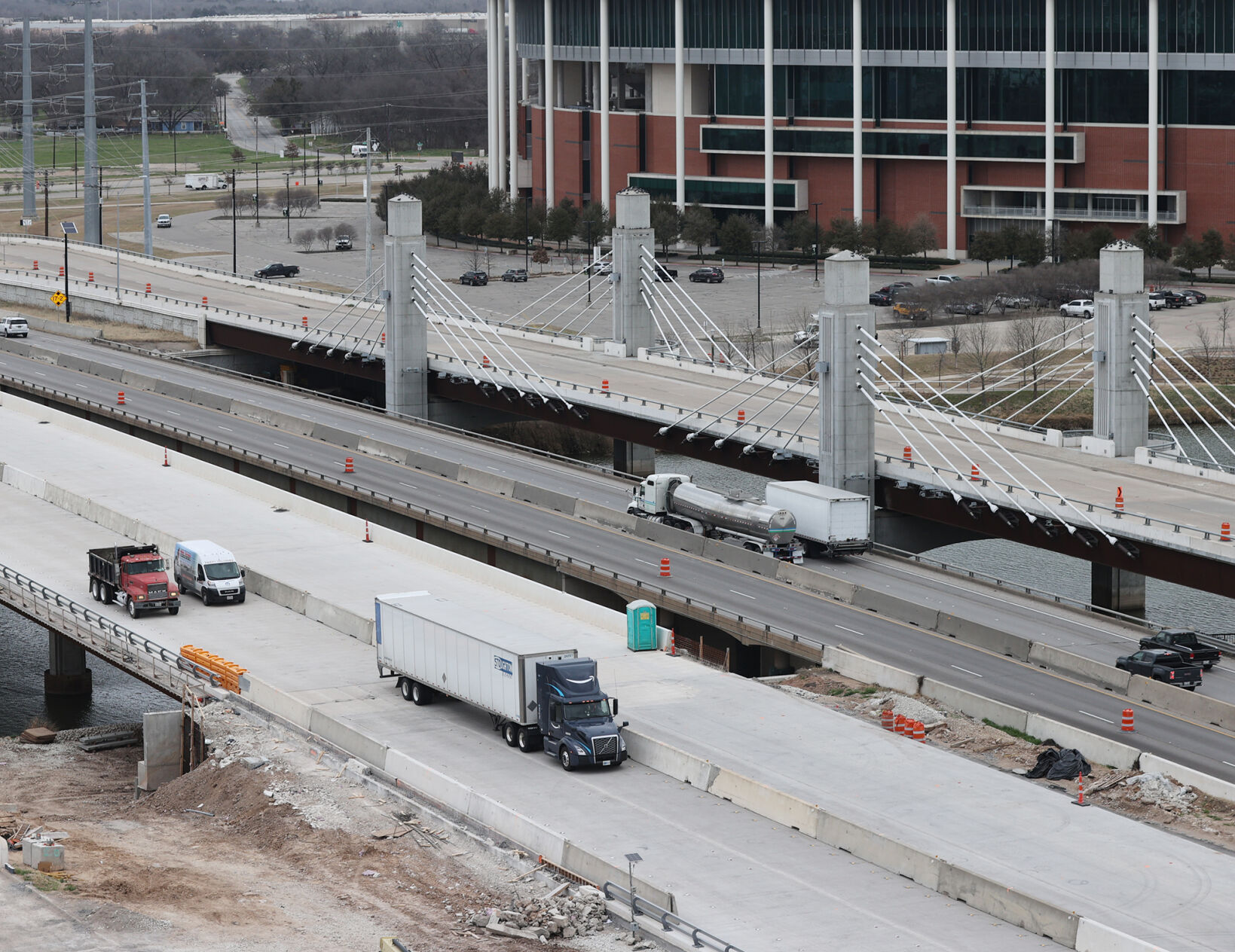

Temporary Interstate 35 lanes sit ready for southbound traffic to be shifted to the northbound side of the old median. A $341 million project to overhaul a 6.7-mile stretch of the highway through Waco started in April and is scheduled to last at least until late 2022.
Interstate 35: Baylor homecoming parade

The Baylor Golden Wave Band crosses Fourth Street at Interstate 35 in the middle of the construction zone on Oct. 12, 2019.
Interstate 35: September 2019

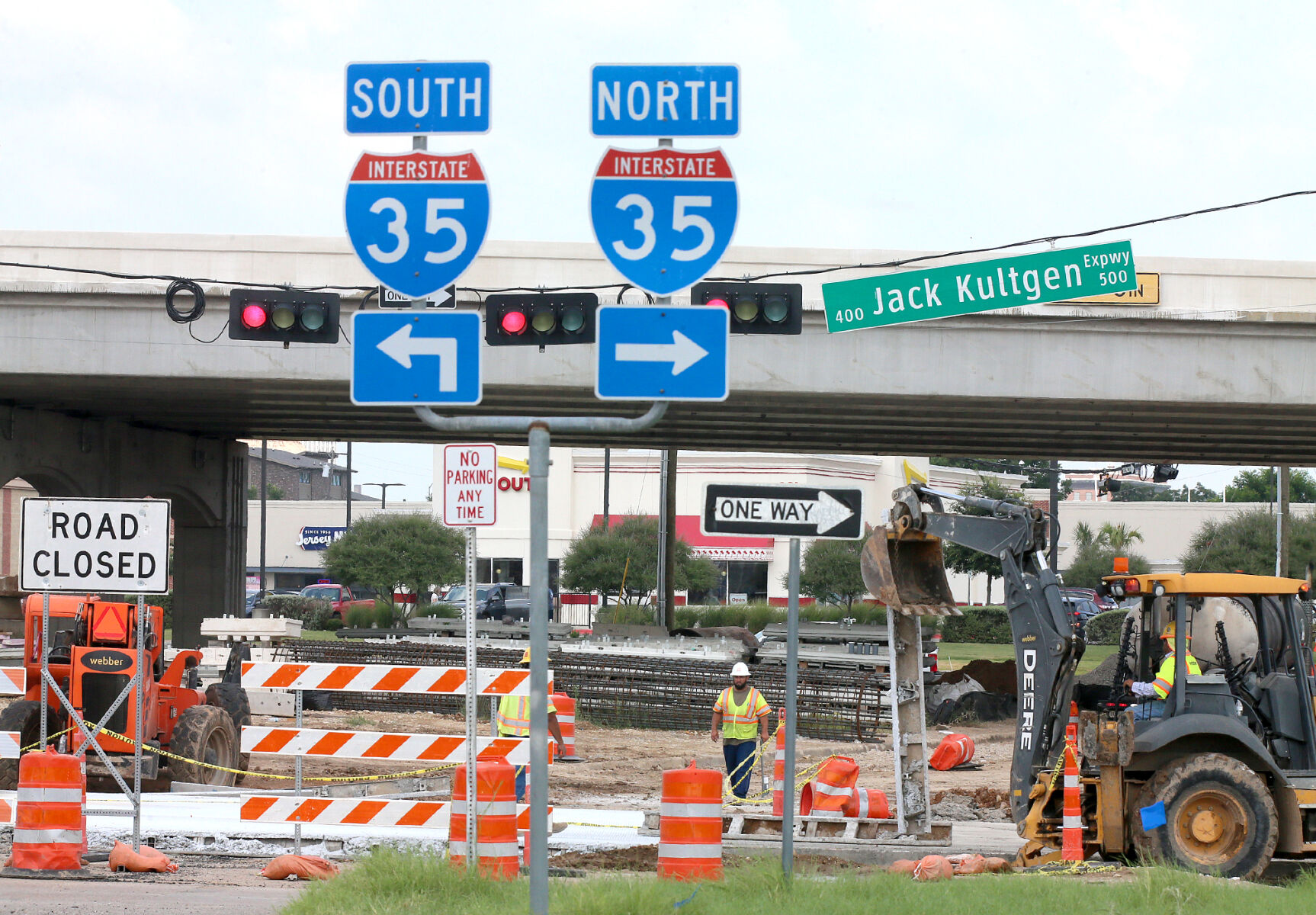

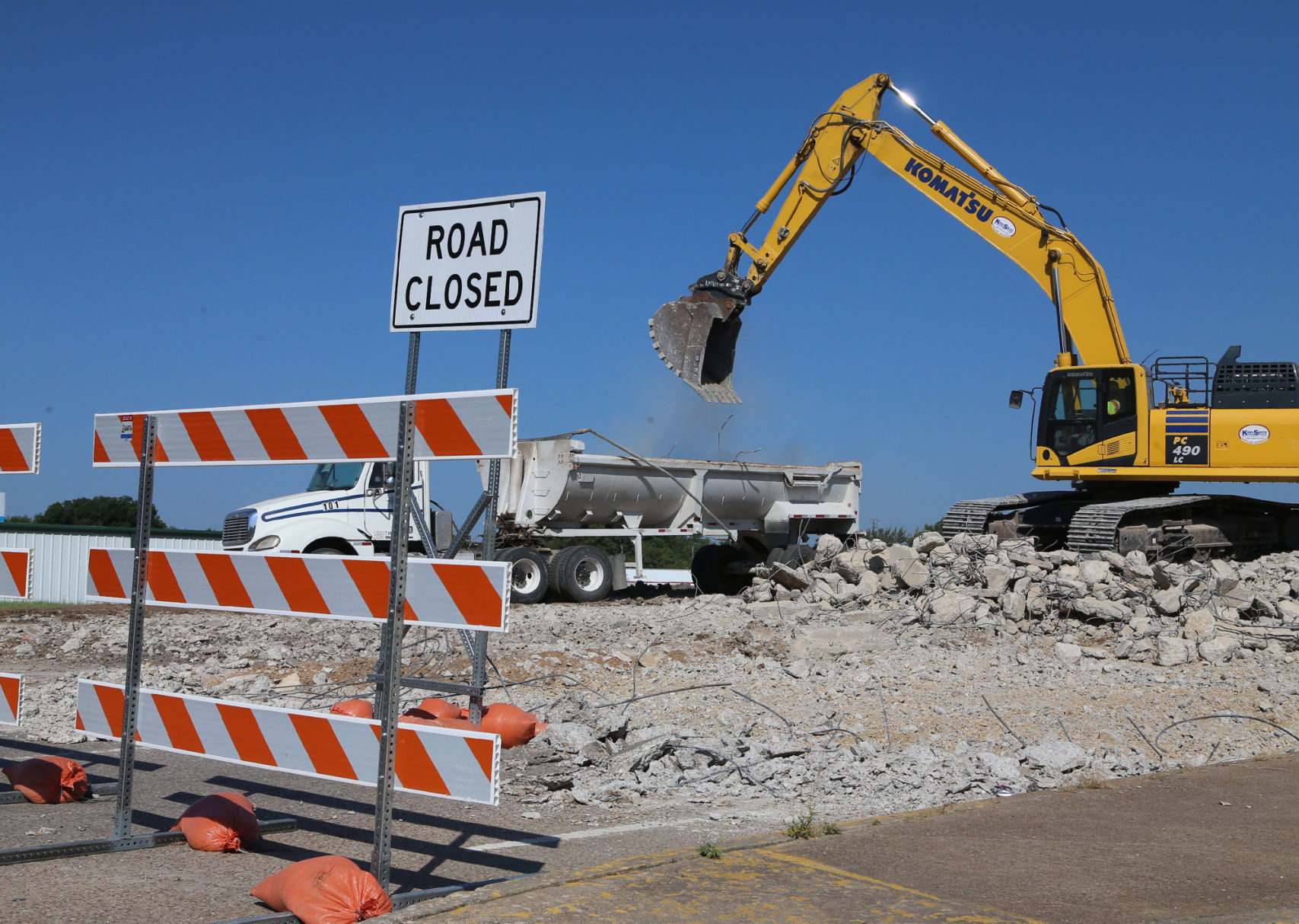

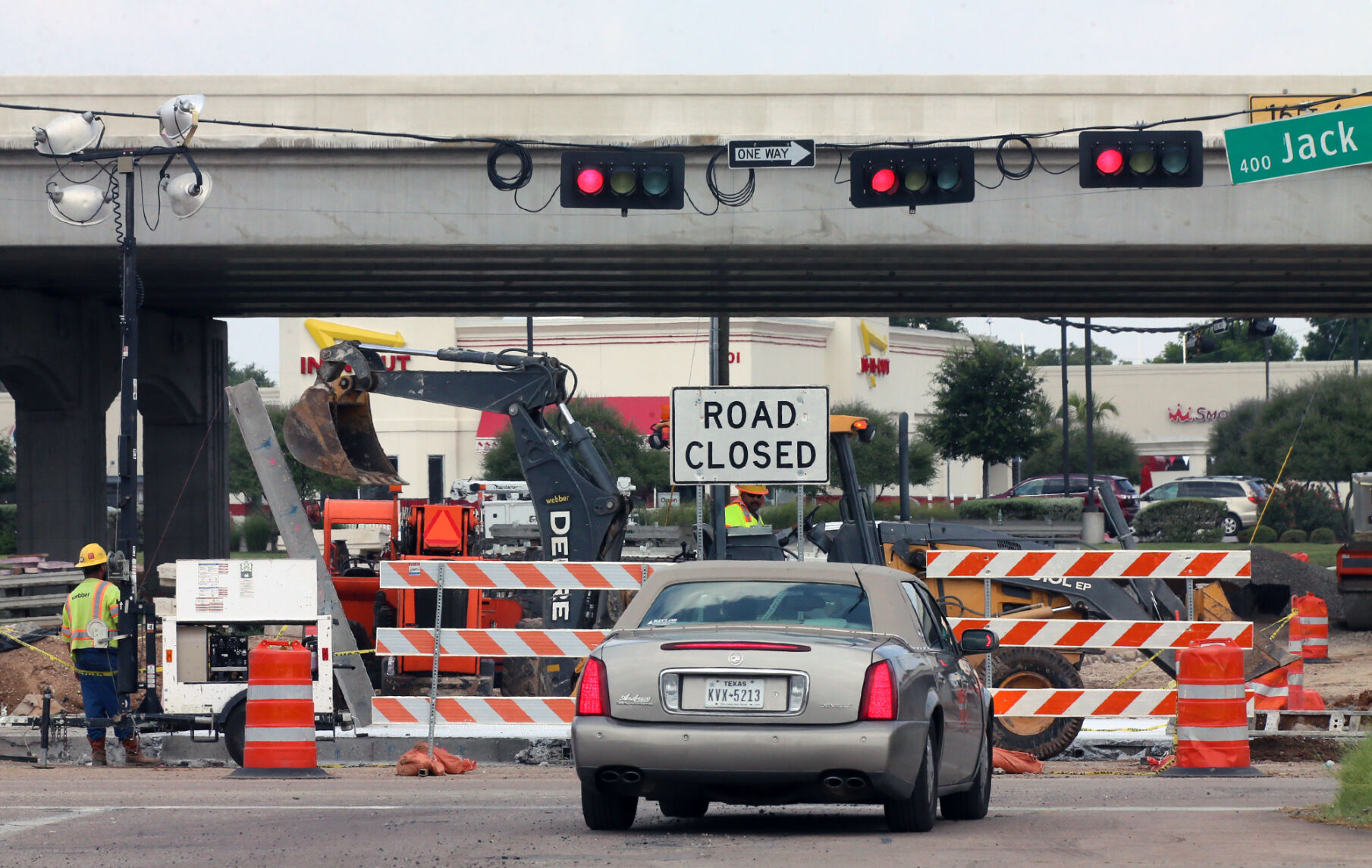

Crews were expected to close the southbound frontage road between Ninth and 12th street during the first week of October 2019.
Interstate 35: Businesses

Several businesses near Interstate 35 have reported a drop in customers since construction started.
Interstate 35: Businesses

Traffic backs up along southbound Interstate 35 Fourth-Fifth streets as construction continues.
Interstate 35: Businesses

Several businesses near Interstate 35 have reported a drop in customers since construction started.
Interstate 35: Businesses

Several businesses near Interstate 35 have reported a drop in customers since construction started.
Interstate 35: Businesses

Several businesses near Interstate 35 have reported a drop in customers since construction started.
Interstate 35: Businesses

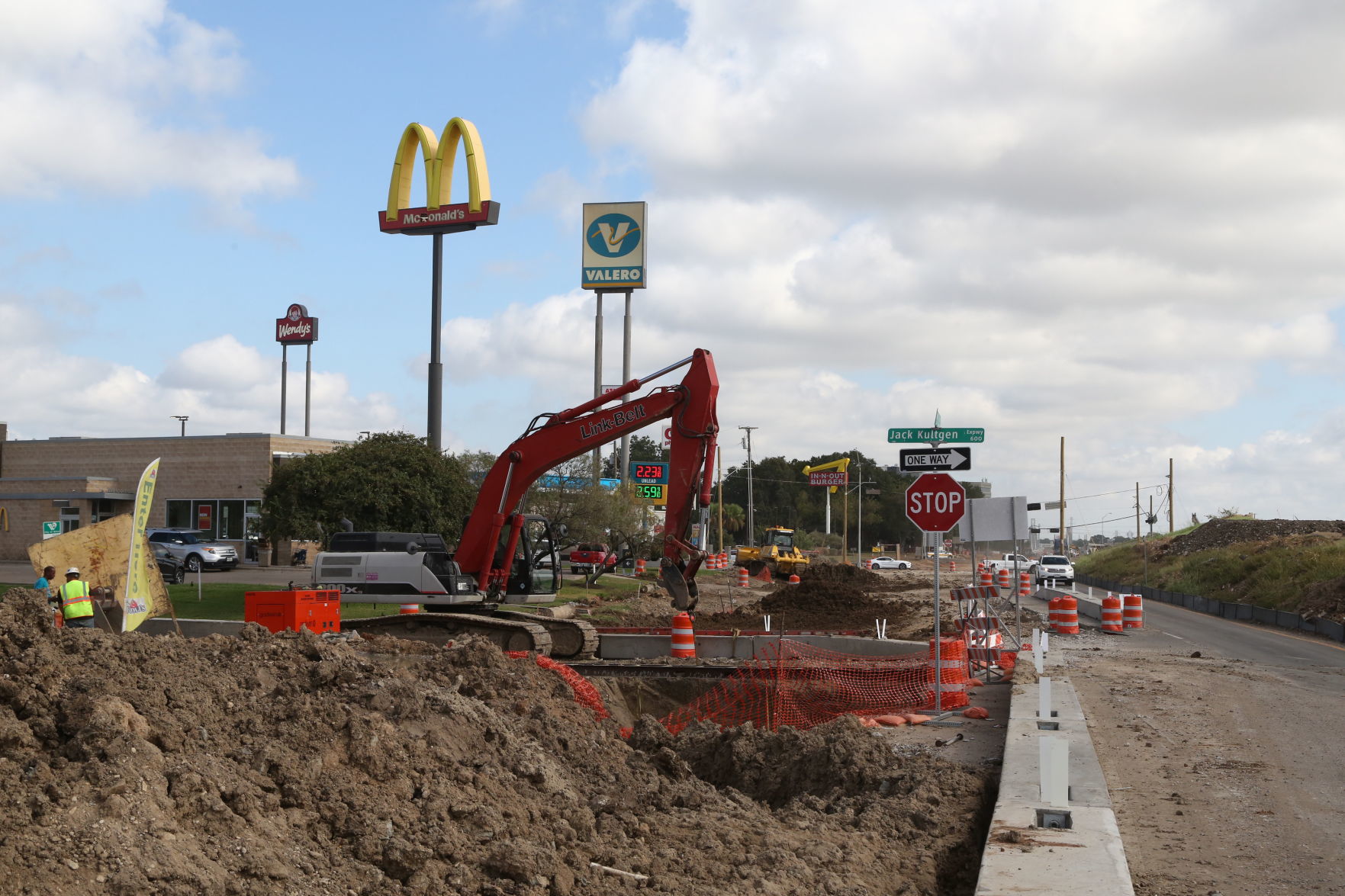

A motorist pulls into a temporary McDonald's entrance from the Interstate access road near downtown.
Interstate 35: Businesses

Sascee’s co-owner John Neal said business has dropped off noticeably since the nearby 11th Street bridge over I-35 closed, especially among the “Baylor crowd.”
Interstate 35: September 2019

A man navigates crossing the southbound Interstate 35 frontage road, which is under construction at Fifth Street in September 2019.
Interstate 35: September 2019

A man makes his way across the Interstate 35 frontage road in the construction zone at Fifth Street.
Interstate 35: September 2019

Traffic goes around a stuck 18-wheeler that got jammed on a tight turn on the southbound Interstate frontage road at Fifth street, which backed up traffic for 20 minutes. The truck finally managed to back its way out of the turn and traffic returned to normal.
Interstate 35: September 2019

Traffic along southbound frontage road of Interstate 35 backs up at Fourth-Fifth streets after the southbound main lane bridge was demolished.
Interstate 35: Southbound bridge demolished

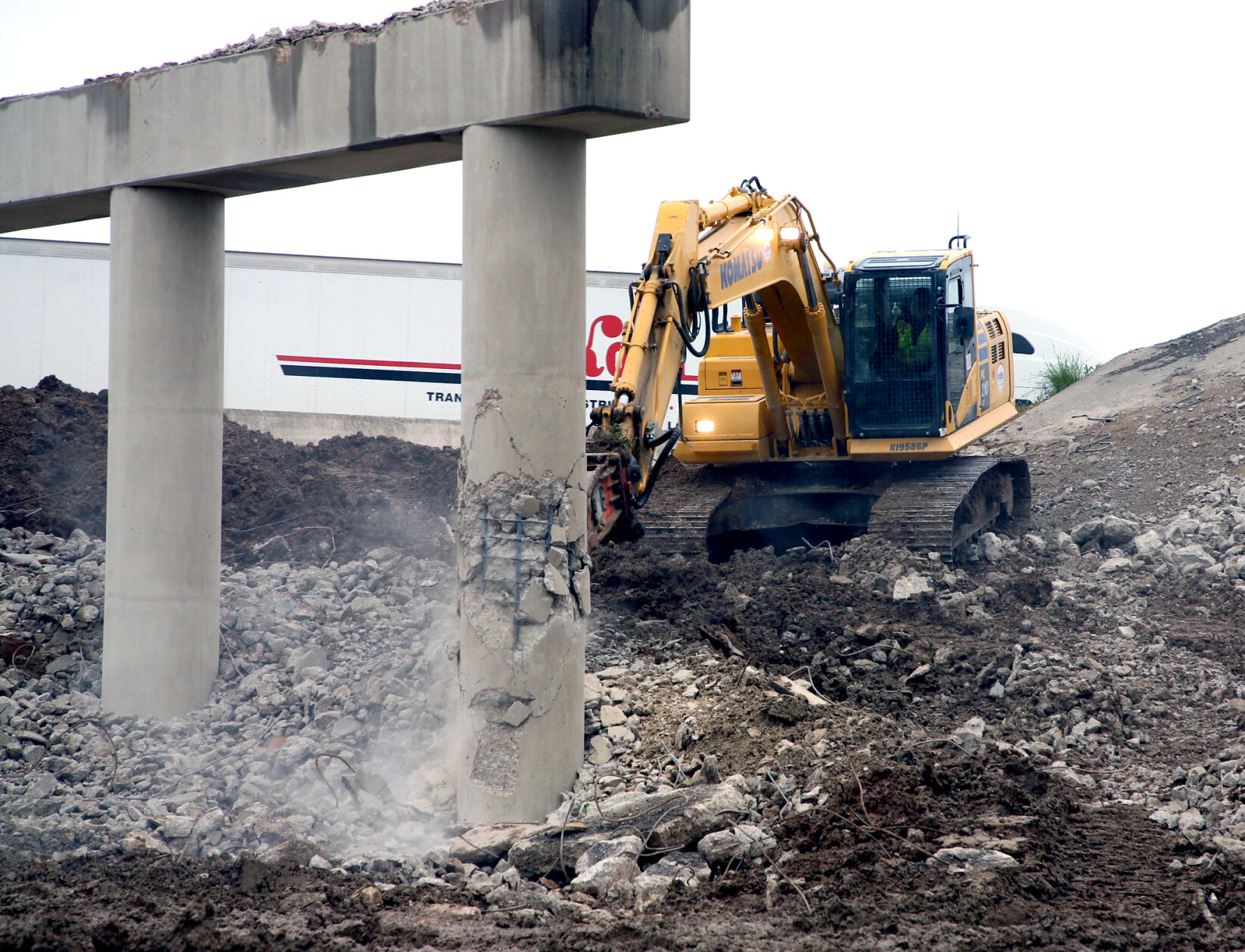

After the bridge that formerly carried the main lanes of southbound Interstate 35 over Fourth-Fifth streets was demolished, construction machinery works at the site in September 2019.
Interstate 35: Southbound bridge demolished

After the bridge that formerly carried the main lanes of southbound Interstate 35 over Fourth-Fifth streets was demolished, construction machinery works at the site in September 2019.
Interstate 35: Southbound bridge demolished

Traffic is seen in September 2019 along Fifth Street after the southbound main-lane bridge was demolished that formerly carried traffic over Fourth-Fifth streets.
Interstate 35: September 2019

Interstate 35 will see southbound lanes shift Saturday night, Sept. 7, to share the roadbed with the northbound lanes south of the Brazos River.
Interstate 35: September 2019

Interstate 35 will see southbound lanes shift Saturday night, Sept. 7, to share the roadbed with the northbound lanes.
Interstate 35: September 2019

Interstate 35 will see southbound lanes shift Saturday night, Sept. 7, to share the roadbed with the northbound lanes.
Interstate 35: Baylor

Drivers head from downtown Waco toward Interstate 35 and Baylor on University Parks Drive. Labor Day weekend and closures on and along I-35 are adding to Baylor’s football game day traffic challenges.
Interstate 35: Baylor move-in day

Traffic along Interstate 35 is slowed near the exit for Baylor University on Wednesday, Aug. 21, 2019. Traffic was slow, but did not directly impact move-in days for students as the university and Texas Department of Transportation devised alternative routes around I-35.
Interstate 35: August 2019

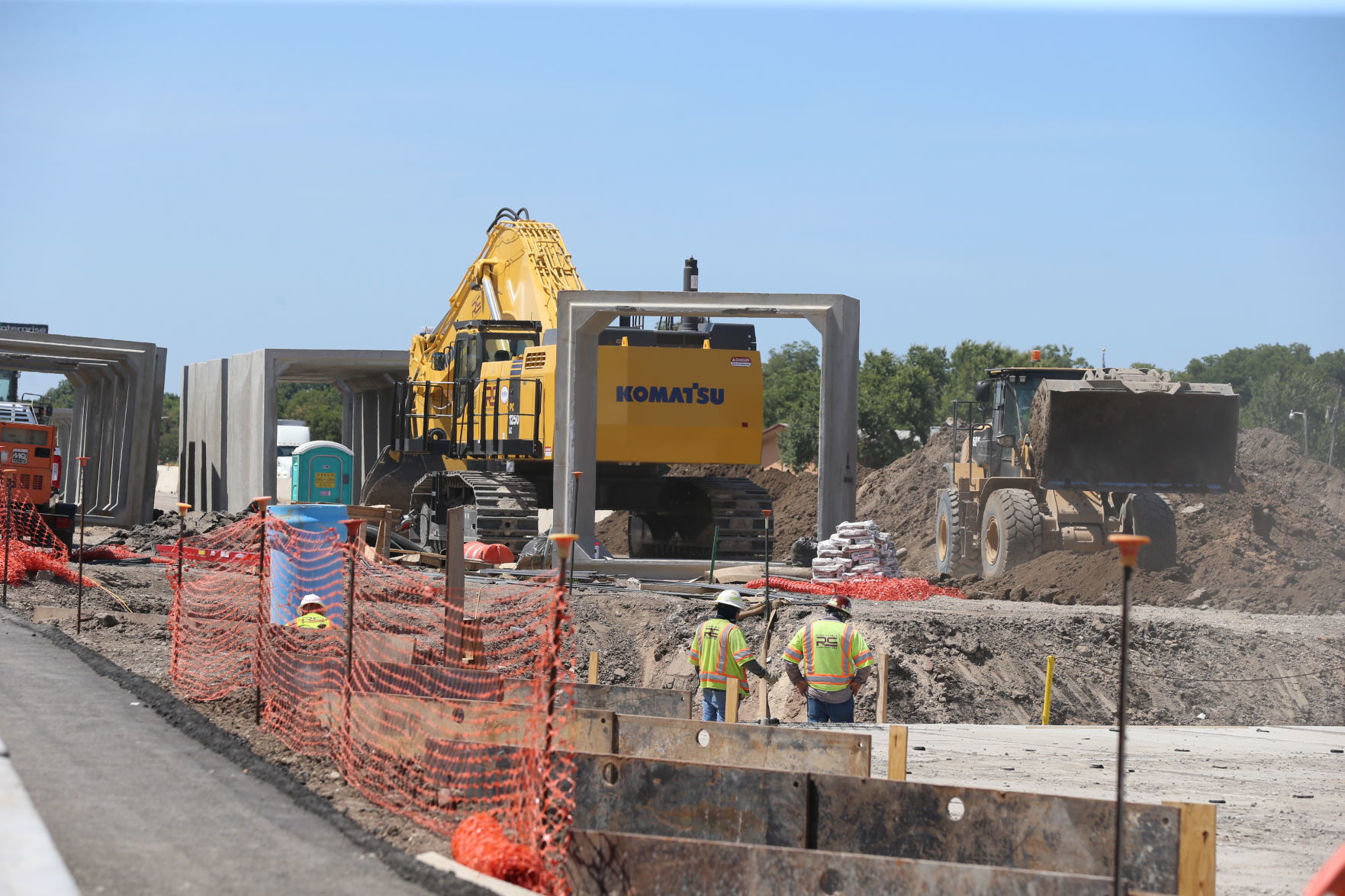

Crews around 10th Street at Interstate 35 work on a project to install large box culverts to convey Waco Creek under the highway.
Interstate 35: August 2019

Crews around 10th Street at Interstate 35 work on a project to install large box culverts to convey Waco Creek under the highway.
Interstate 35: August 2019

Crews near 10th Street at Interstate 35 work on a project to install large box culverts to convey Waco Creek under the highway.
Interstate 35: August 2019

The northbound lane of Interstate 35 is backed up due to a wreck on the bridge before the Waco Drive exit in Bellmead. Friday's late five o'clock didn't help matters as traffic was a standstill in both directions.
Interstate 35: August 2019

A bulldozer makes it way down the median between northbound (right) and southbound lanes of Interstate 35.
Interstate 35: 11th Street bridge

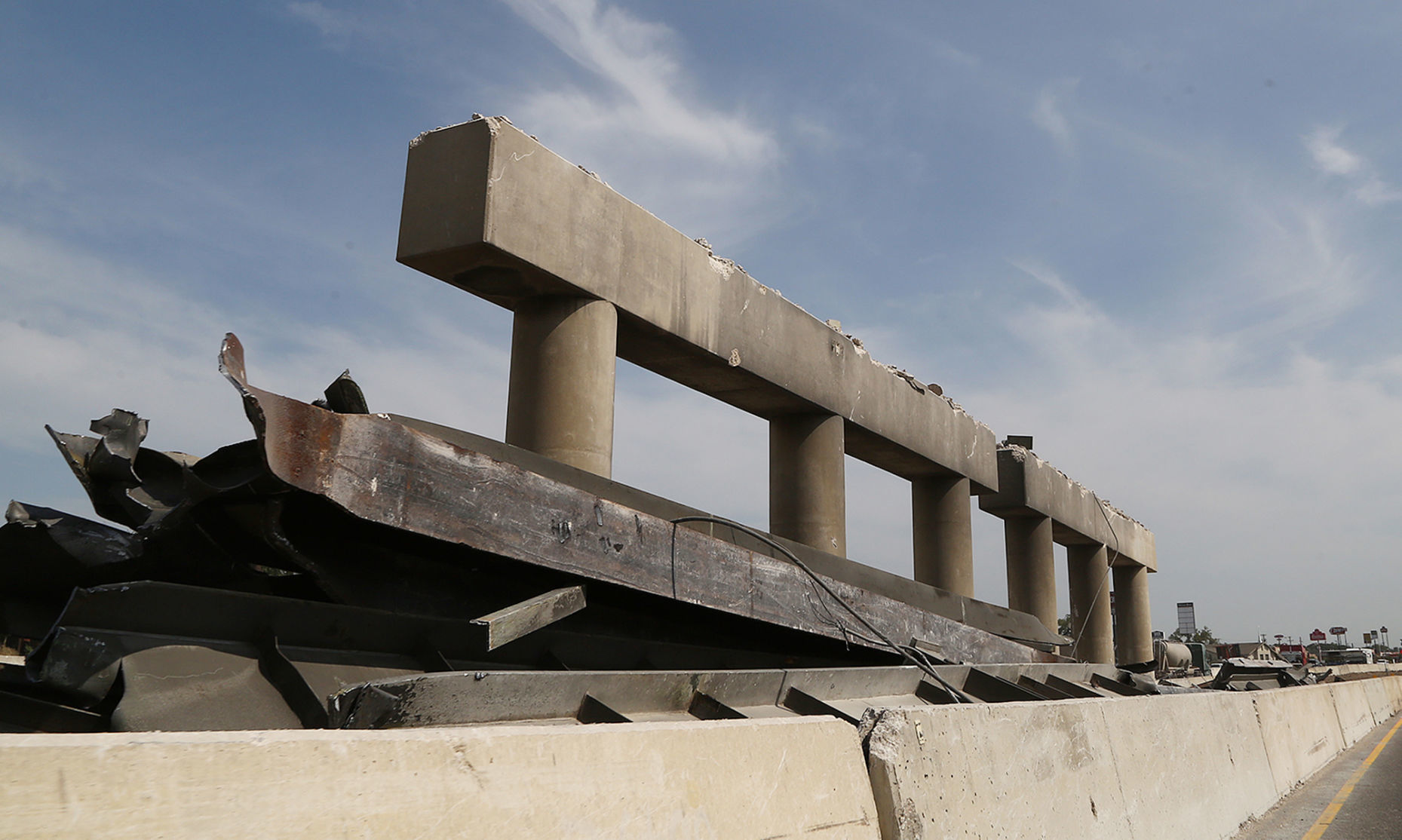

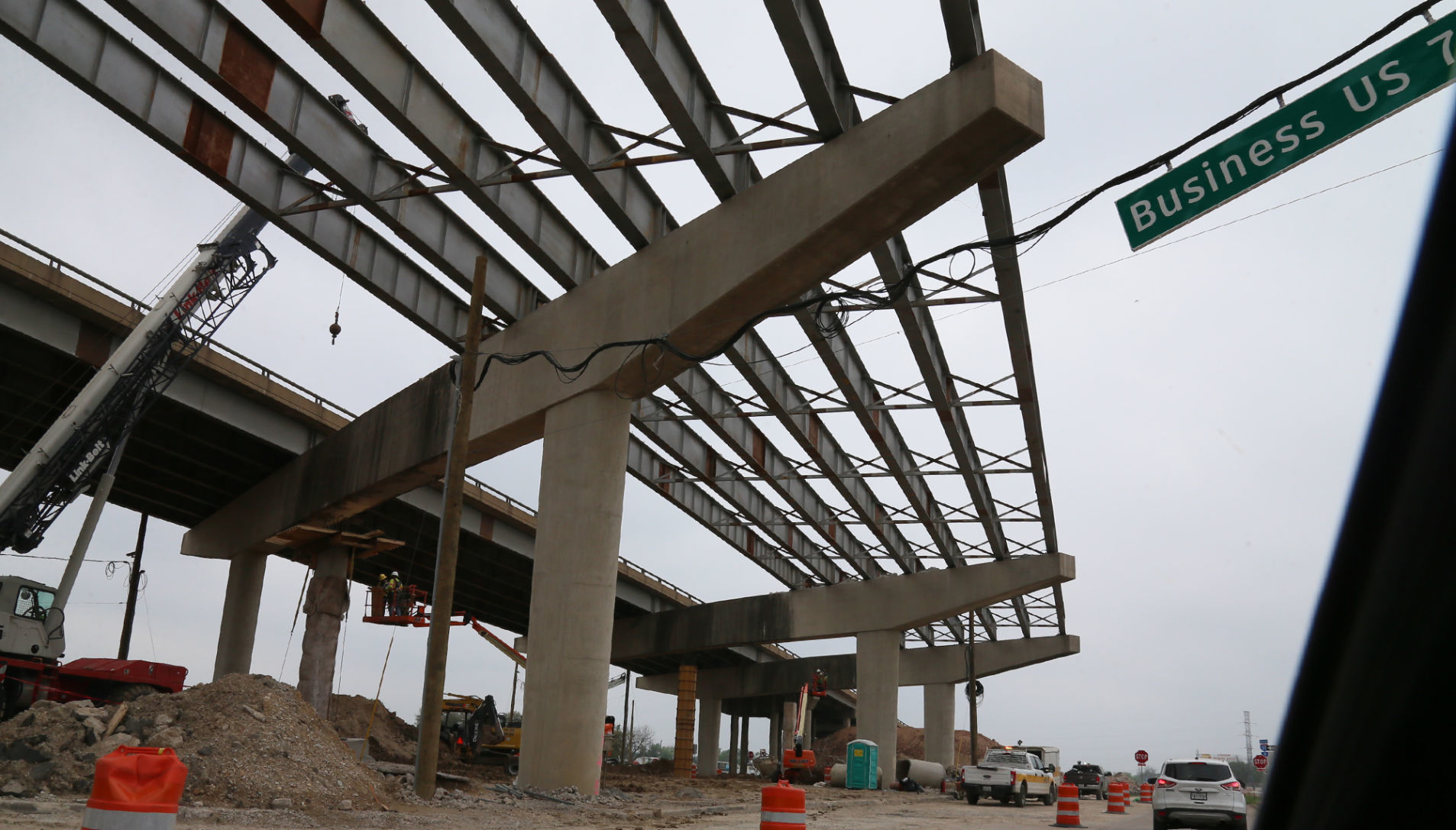

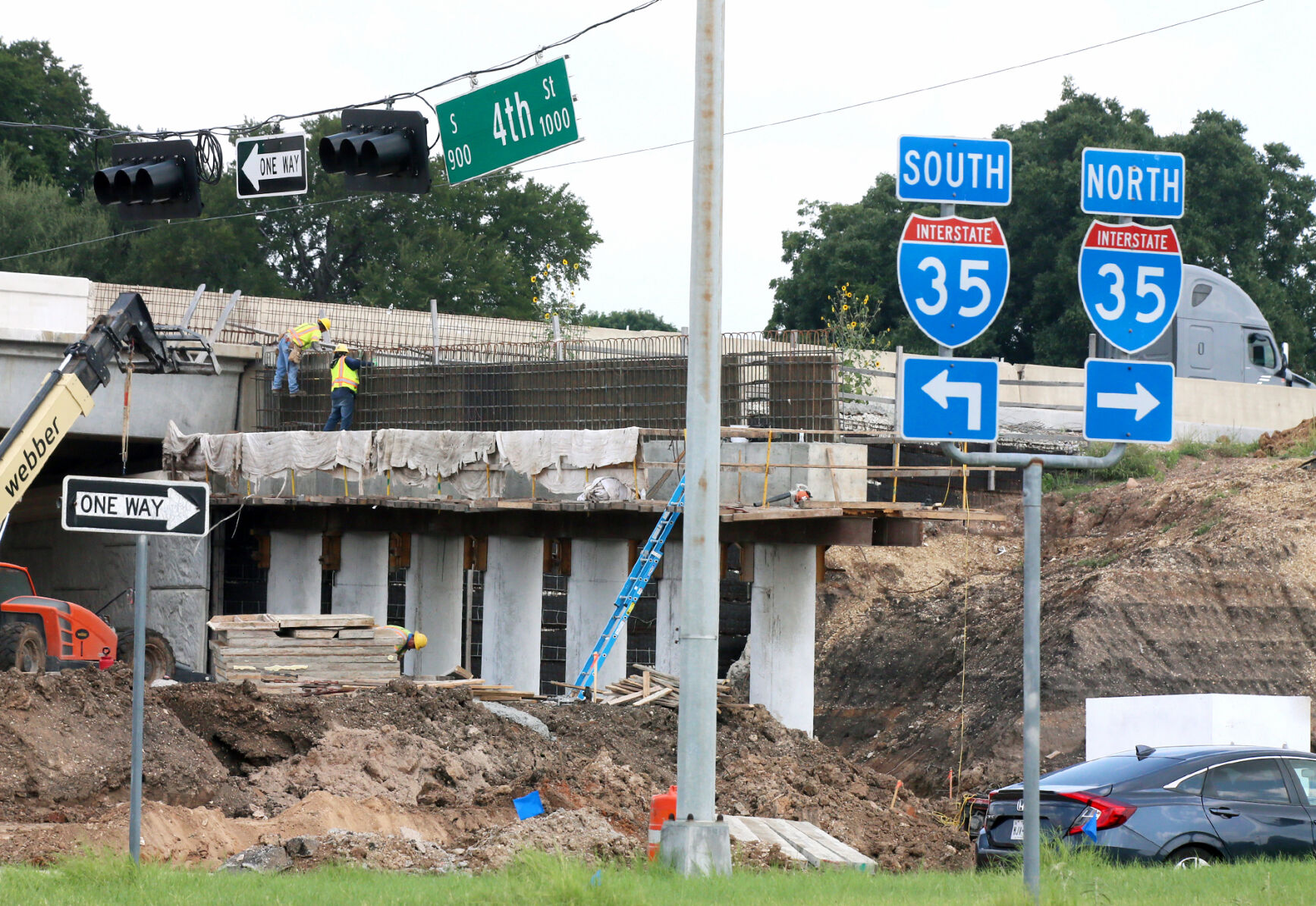

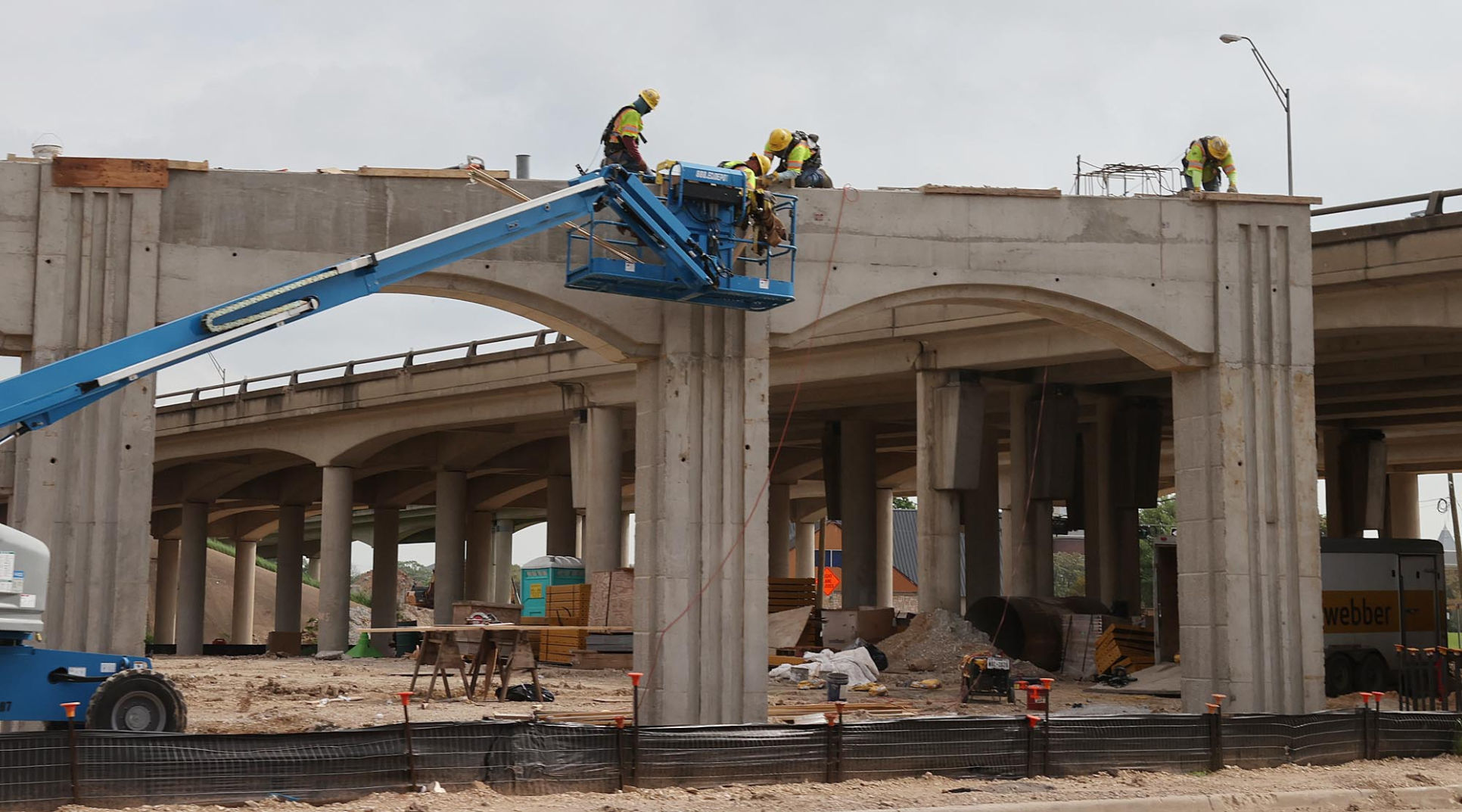

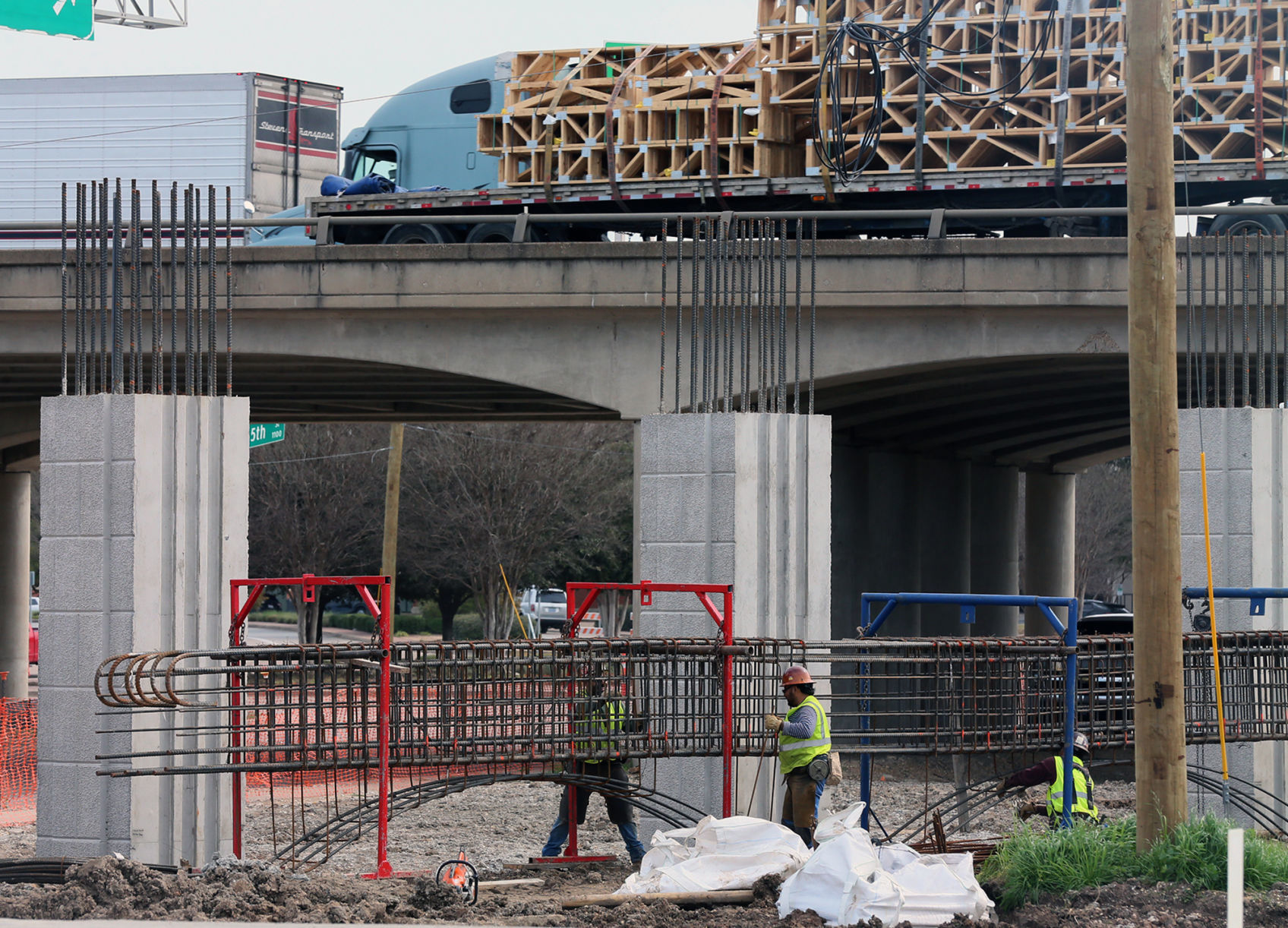

Concrete supports stay standing after metal beams have removed from the 11th and 12th street bridge deck along Interstate 35 on Aug. 1, 2019 as demolition of the bridge continues. An underpass will replace the crossing by the time a $340 million I-35 widening project wraps up.
Interstate 35: 11th Street bridge

Concrete supports stay standing after metal beams have removed from the 11th and 12th street bridge deck along Interstate 35 on Aug. 1, 2019 as demolition of the bridge continues. An underpass will replace the crossing by the time a $340 million I-35 widening project wraps up.
Interstate 35: 11th Street bridge

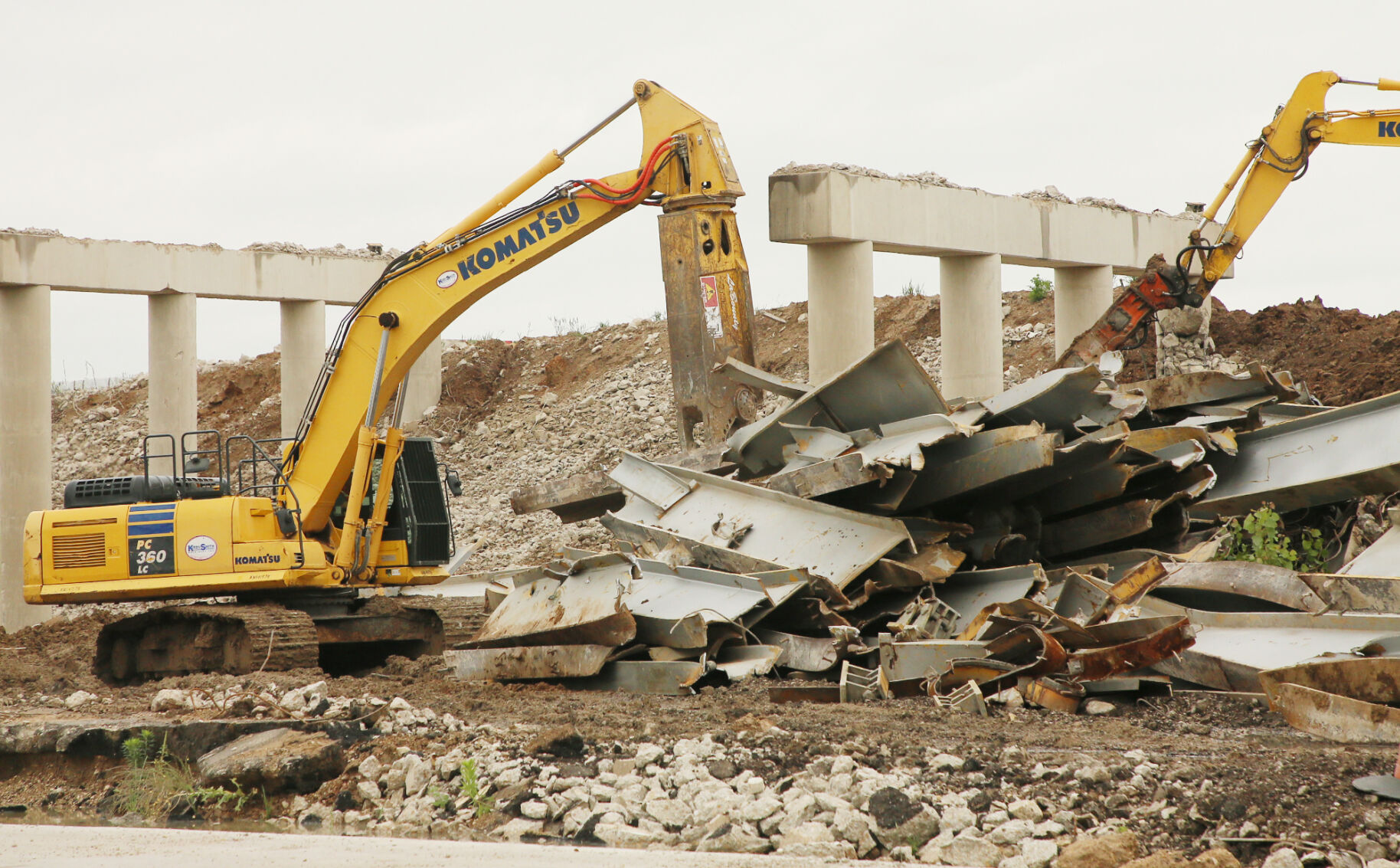

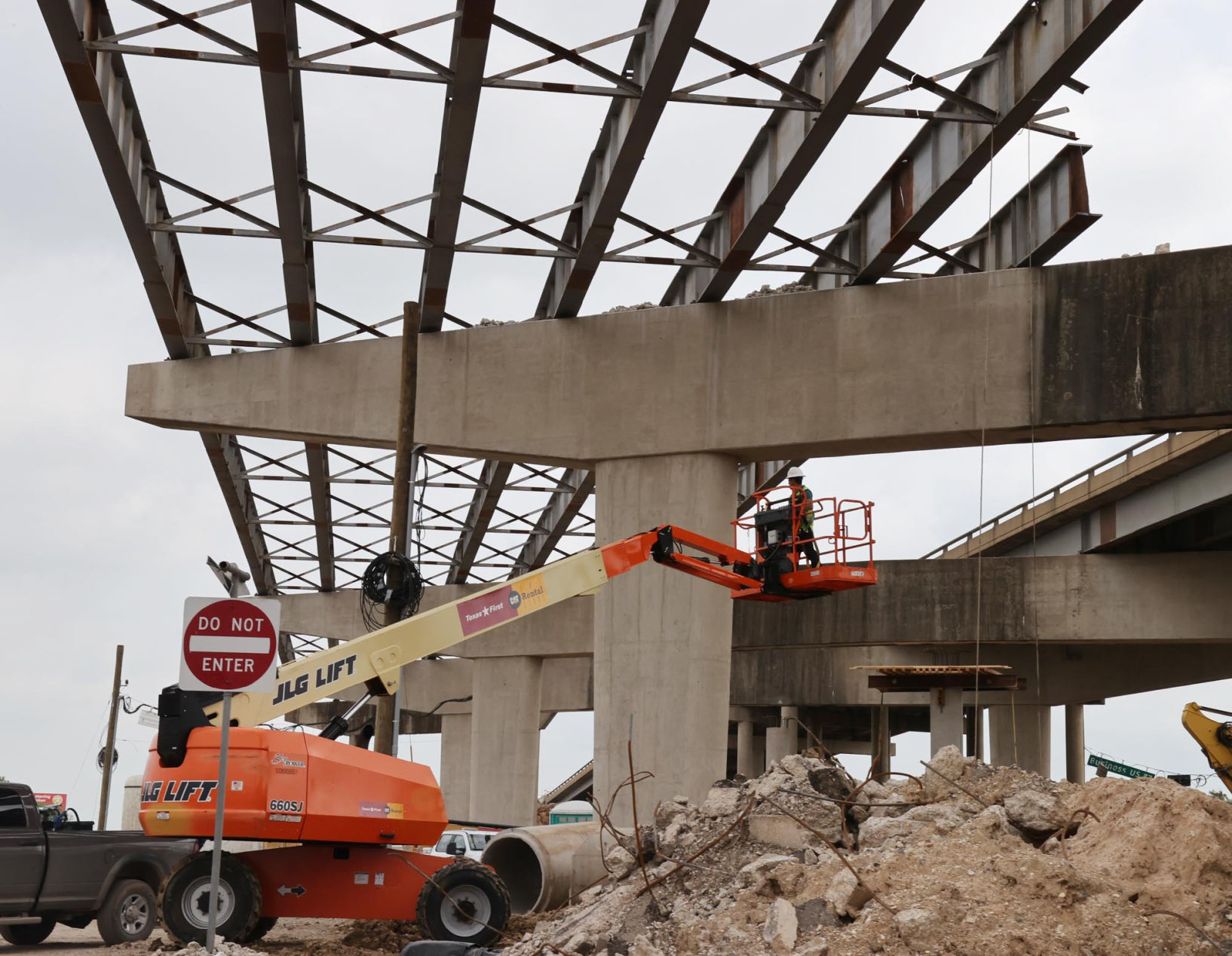

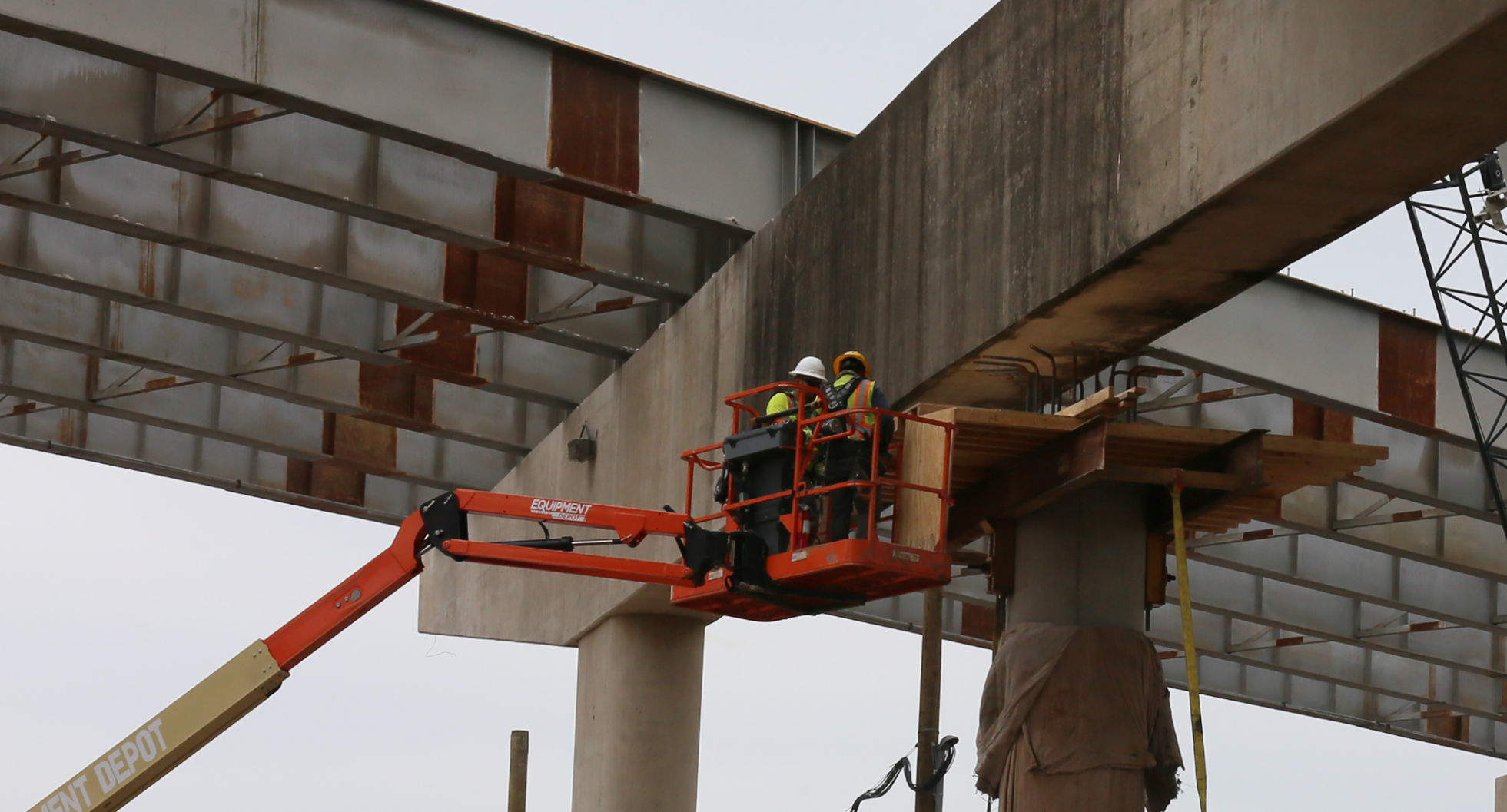

Metal beams removed from the 11th and 12th street bridge are piled up along Interstate 35 on Aug. 1, 2019 as demolition of the bridge continues. An underpass will replace the crossing by the time a $340 million I-35 widening project wraps up.
Interstate 35: 11th Street bridge

Workers prepare to haul away chunks of the 11th and 12th street bridge deck in late July 2019.
Interstate 35: 11th Street bridge

Much of the deck has been removed from the 11th and 12th street bridge over Interstate 35, where the now-exposed metal beams are set to be pulled down in late July 2019.
Interstate 35: 11th Street bridge

Metal supports are visible on the 11th-12th street bridge Saturday as crews work through the process of demolishing the bridge. An 11th-12th street underpass will replace the bridge by the time the interstate widening is complete.
Interstate 35: 11th Street bridge

Metal supports are visible as decking is being removed from the 11th-12th street bridge that is in the process of being demolished.
Interstate 35: 11th Street bridge

Southbound traffic on Interstate 35 passes under the 11th-12th street bridge that is in the process of being demolished.
Interstate 35: 11th Street bridge

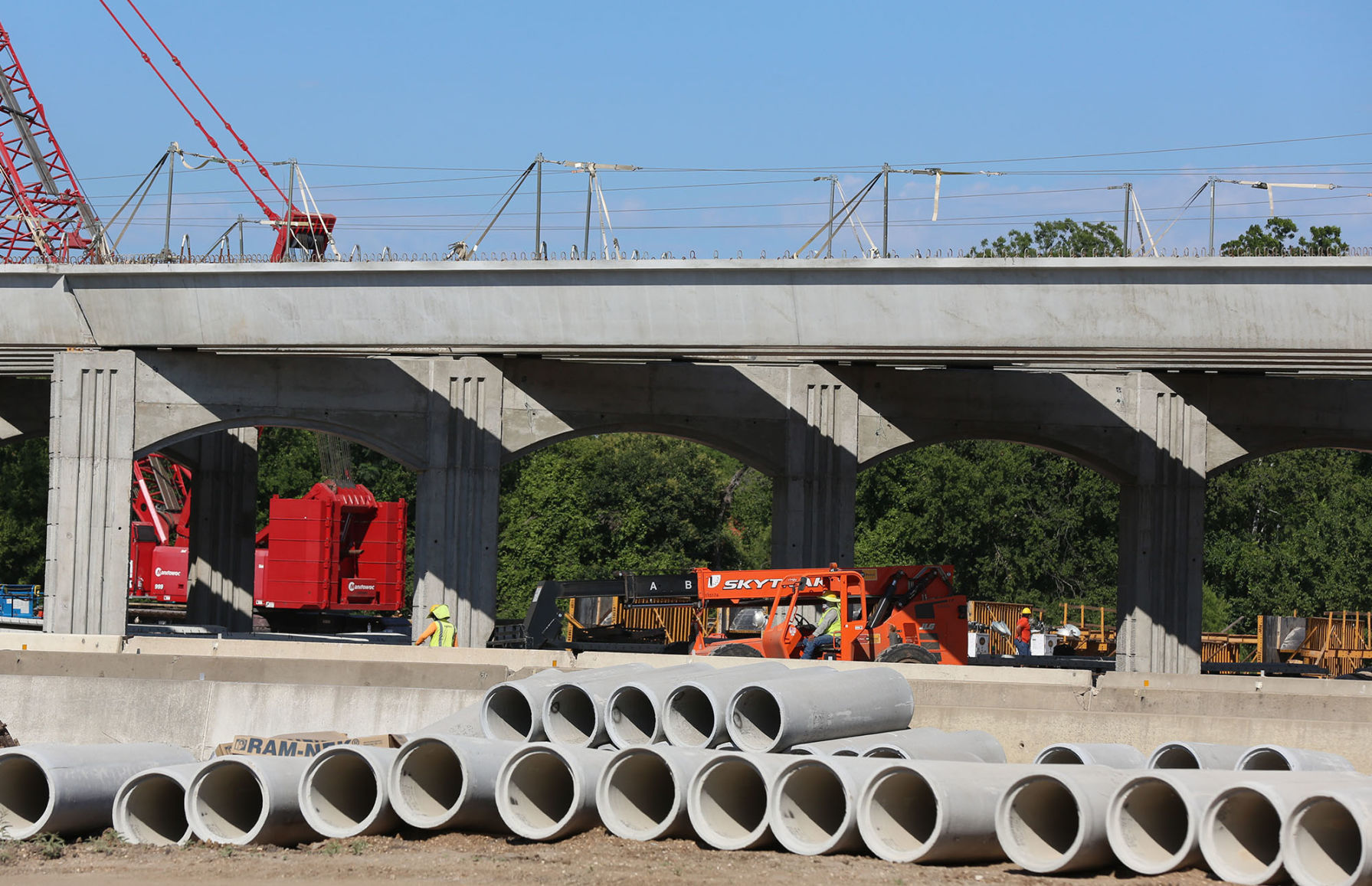

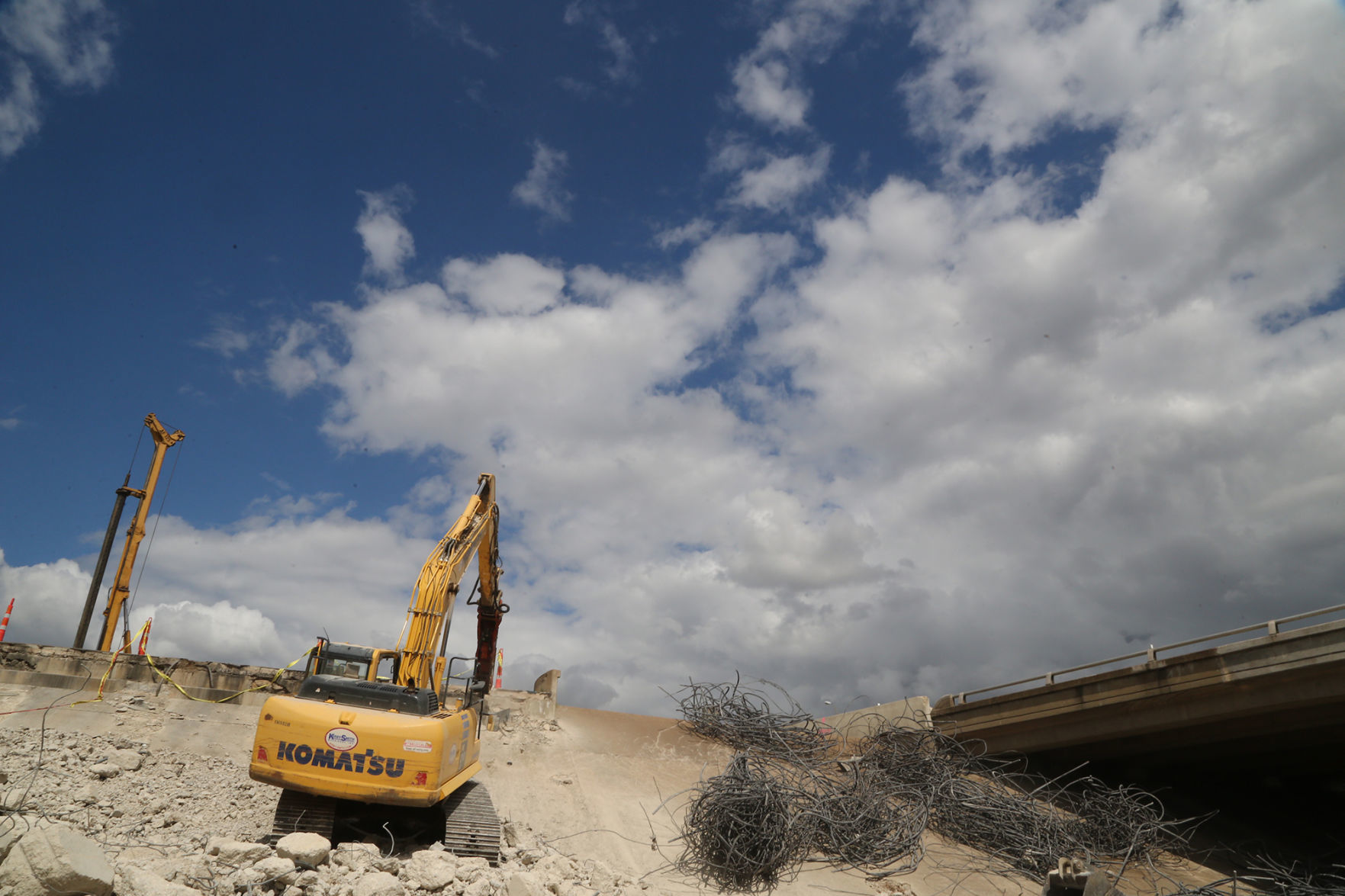

Workers rest inside a section of a box culvert waiting to be installed under Interstate 35 near the 11th Street underpass that is being demolished.
Interstate 35: July 2019

Most of the exit ramp to Fourth-Fifth streets (bottom left) has been removed on the southbound side of Interstate 35 as traffic and construction continue through Waco.

Interstate 35: July 2019

Traffic slows down near Fifth Street as cars move through the construction zone heading northbound.
Interstate 35: July 2019

Northbound traffic slows down near Bellmead on a lane-reduced Interstate 35, which will be a daily occurrence as construction continues.
Interstate 35: 11th Street bridge

Heavy machinery works on the northbound access road of Interstate 35 near the 11th Street bridge, .
Interstate 35: 11th Street bridge

A man walks over the closed 11th Street bridge, which was slated for demolition Wednesday night.
Interstate 35: July 2019

Construction at 17th Street along the east side of Interstate 35.
Interstate 35: July 2019

Construction at 17th Street along the east side of Interstate 35.
Interstate 35: July 2019

Construction at 17th Street along the east side of Interstate 35.
